Berg 2008 Garage Expansion
by Messina Construction Inc.
John Messina 630-330-1503 cell
Office:
630-894-5512
messinainc@sbcglobal.net
(left click on the thumbnail to enlarge the picture)

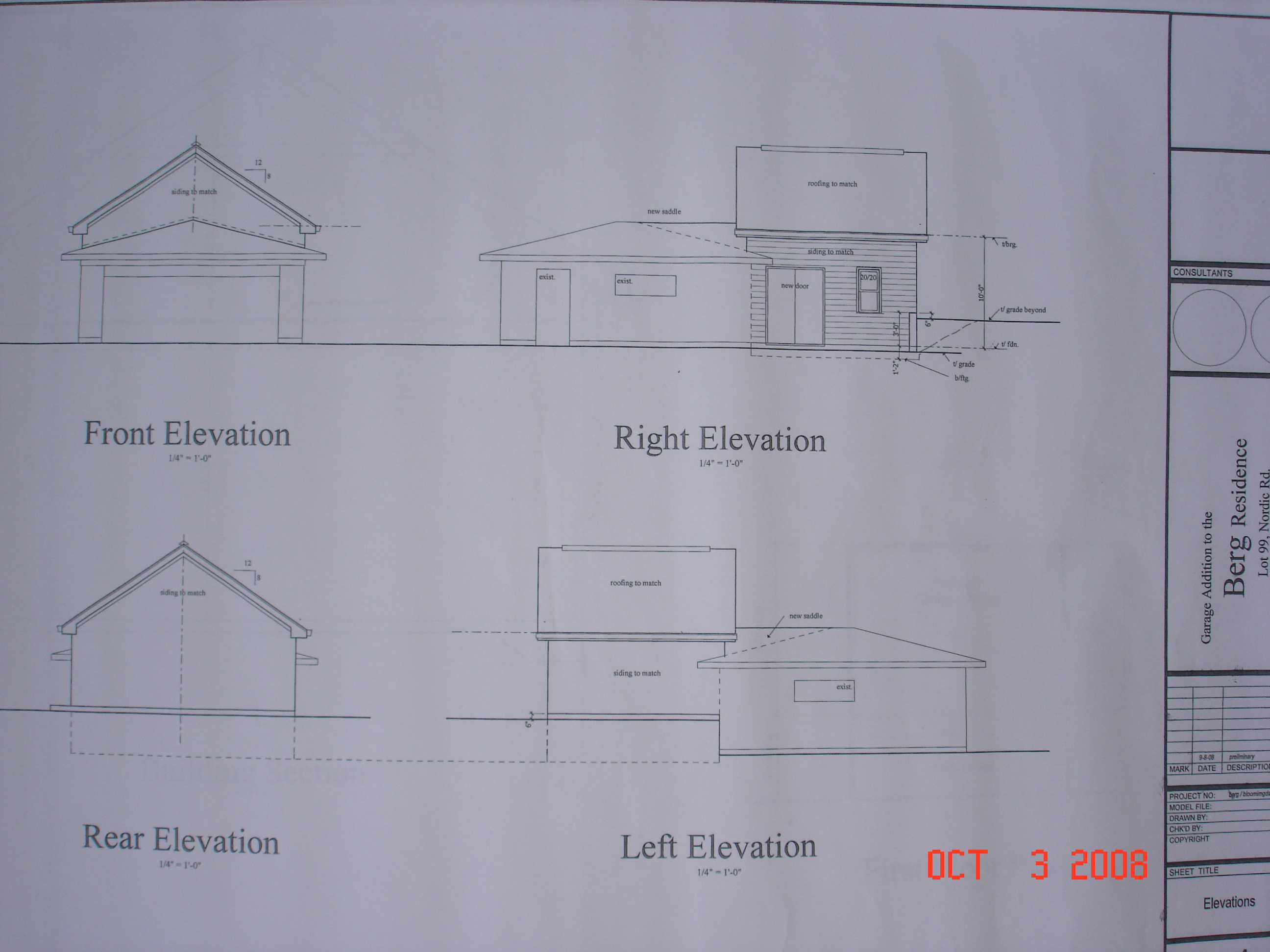

Front - Before start Rear - Before start The Plan Completed

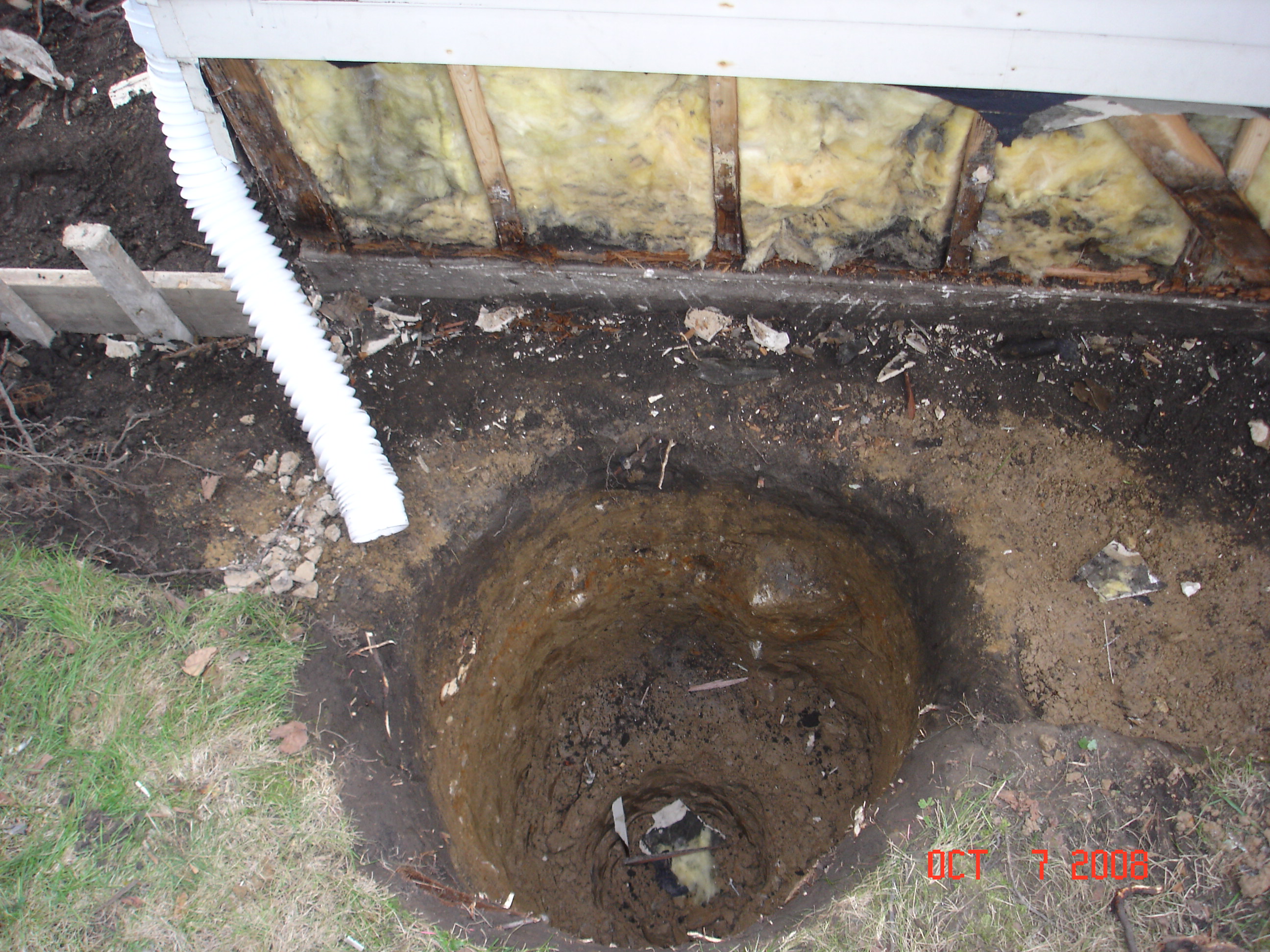

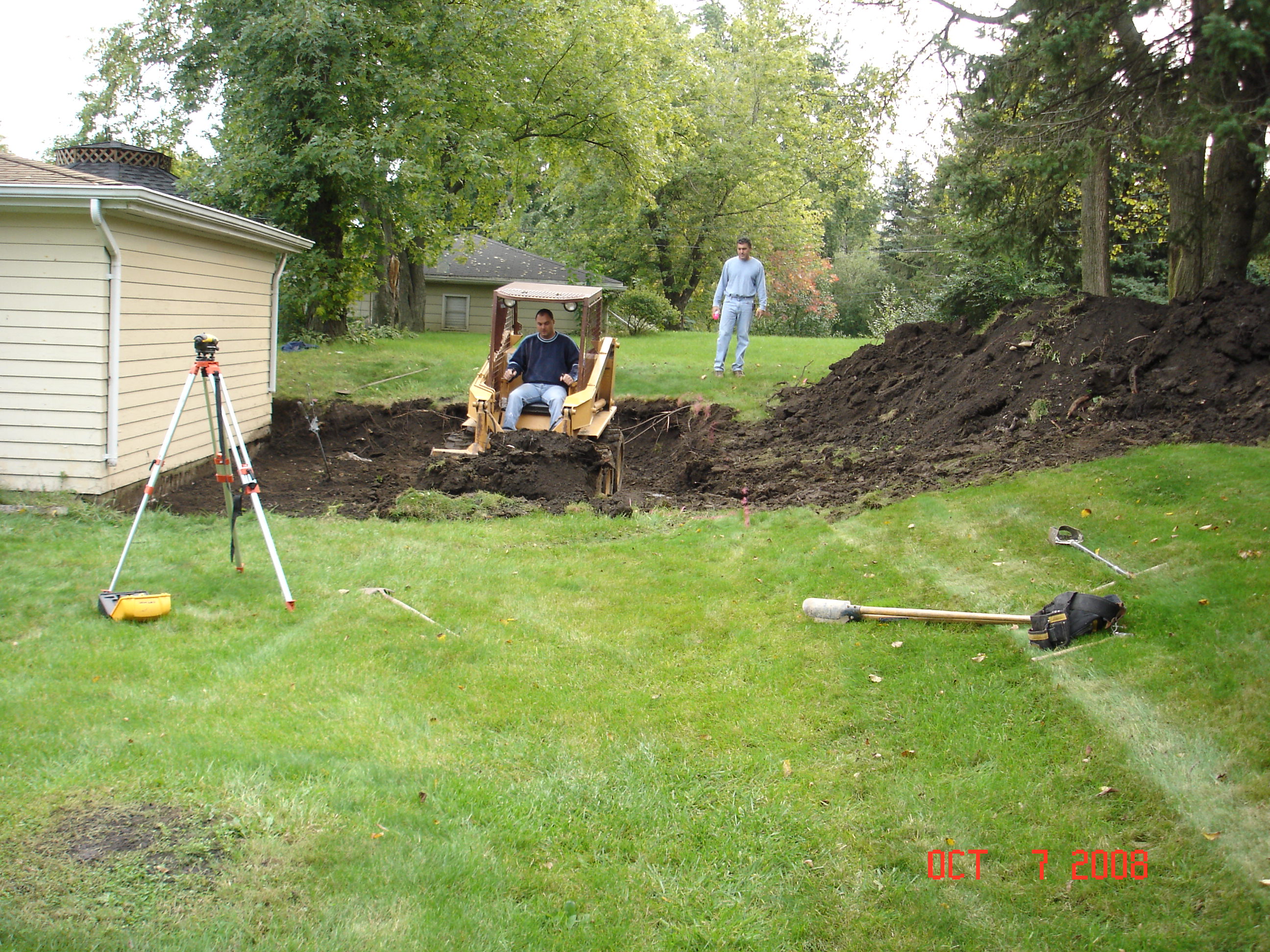

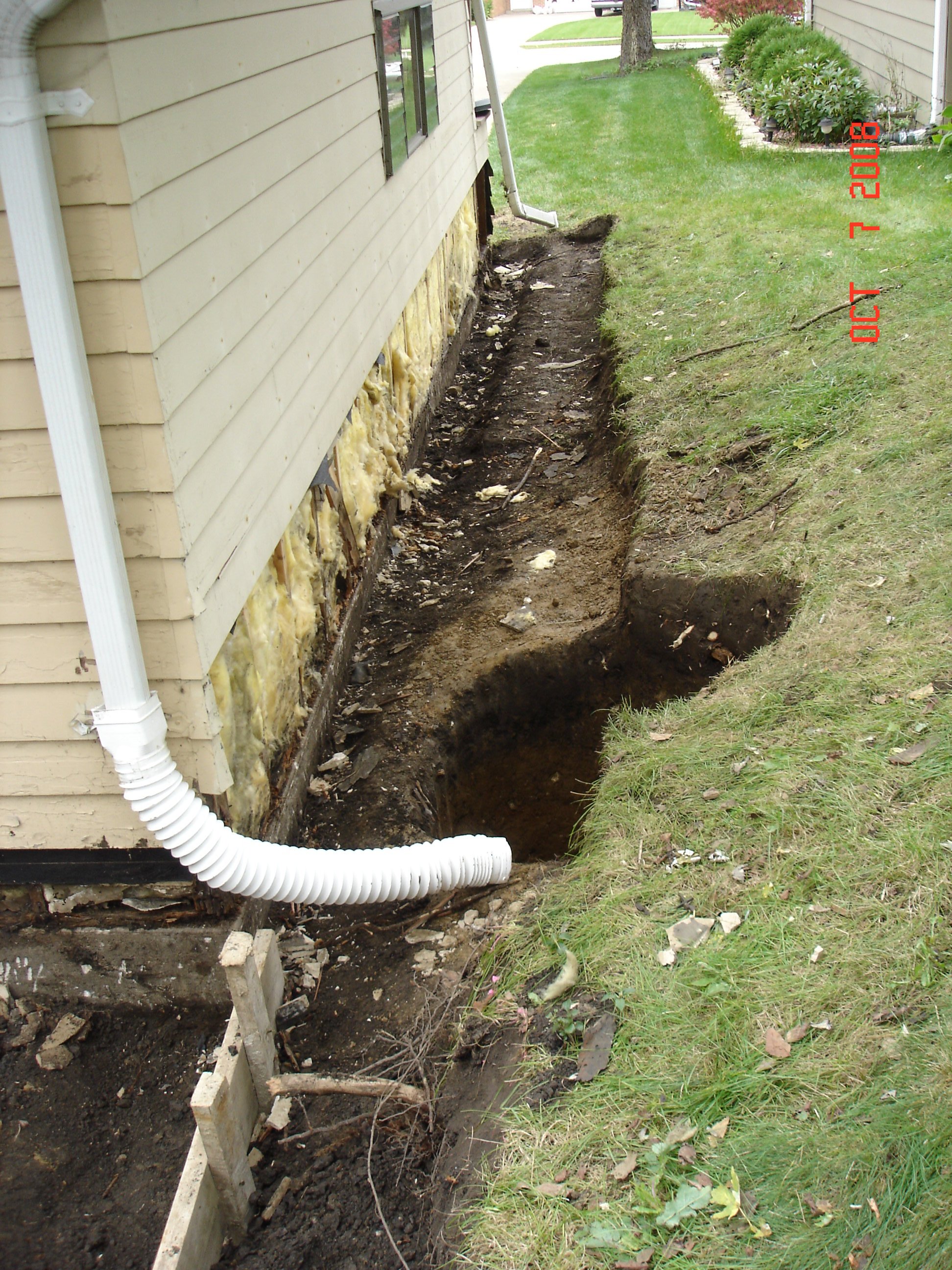

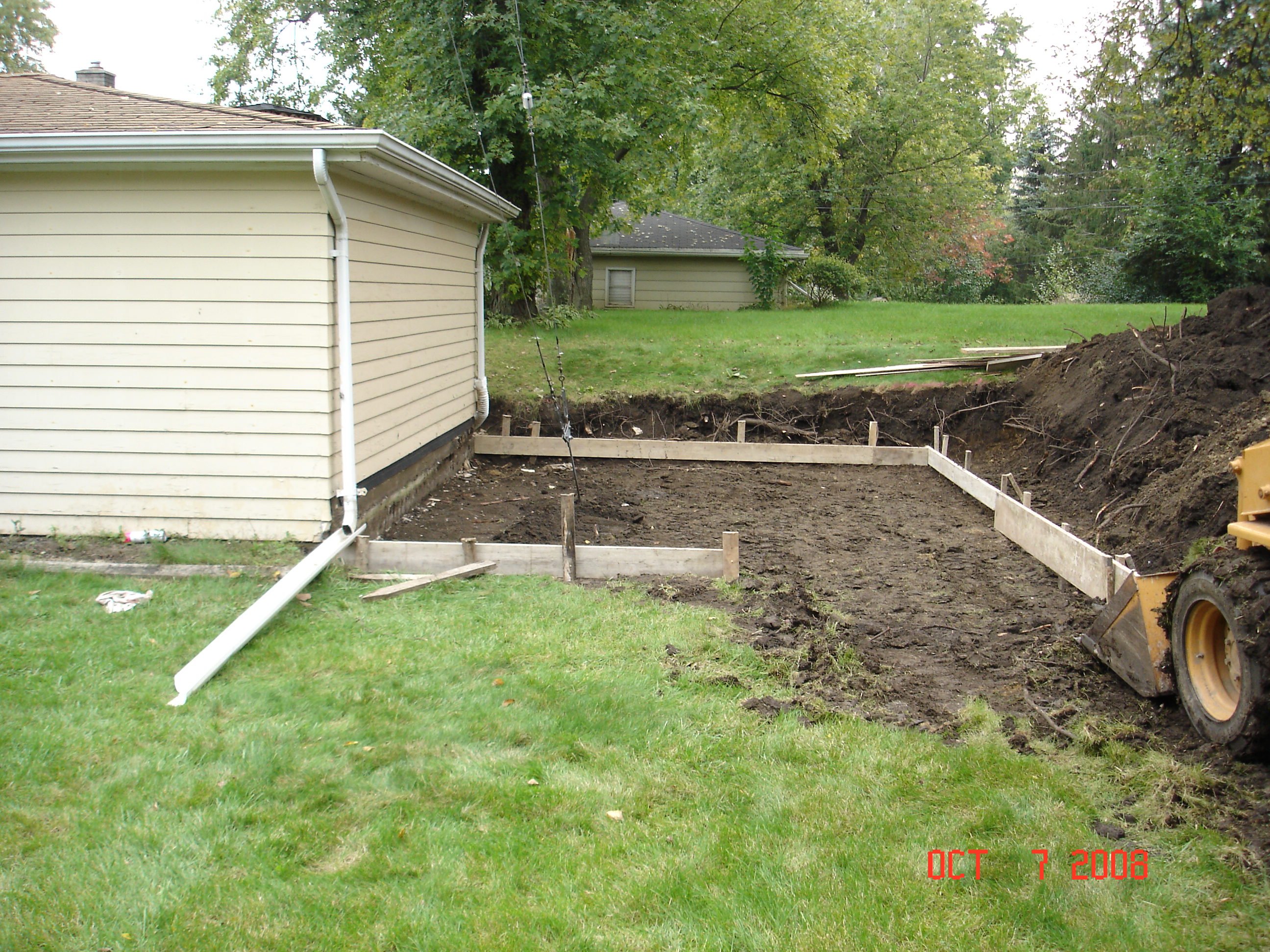

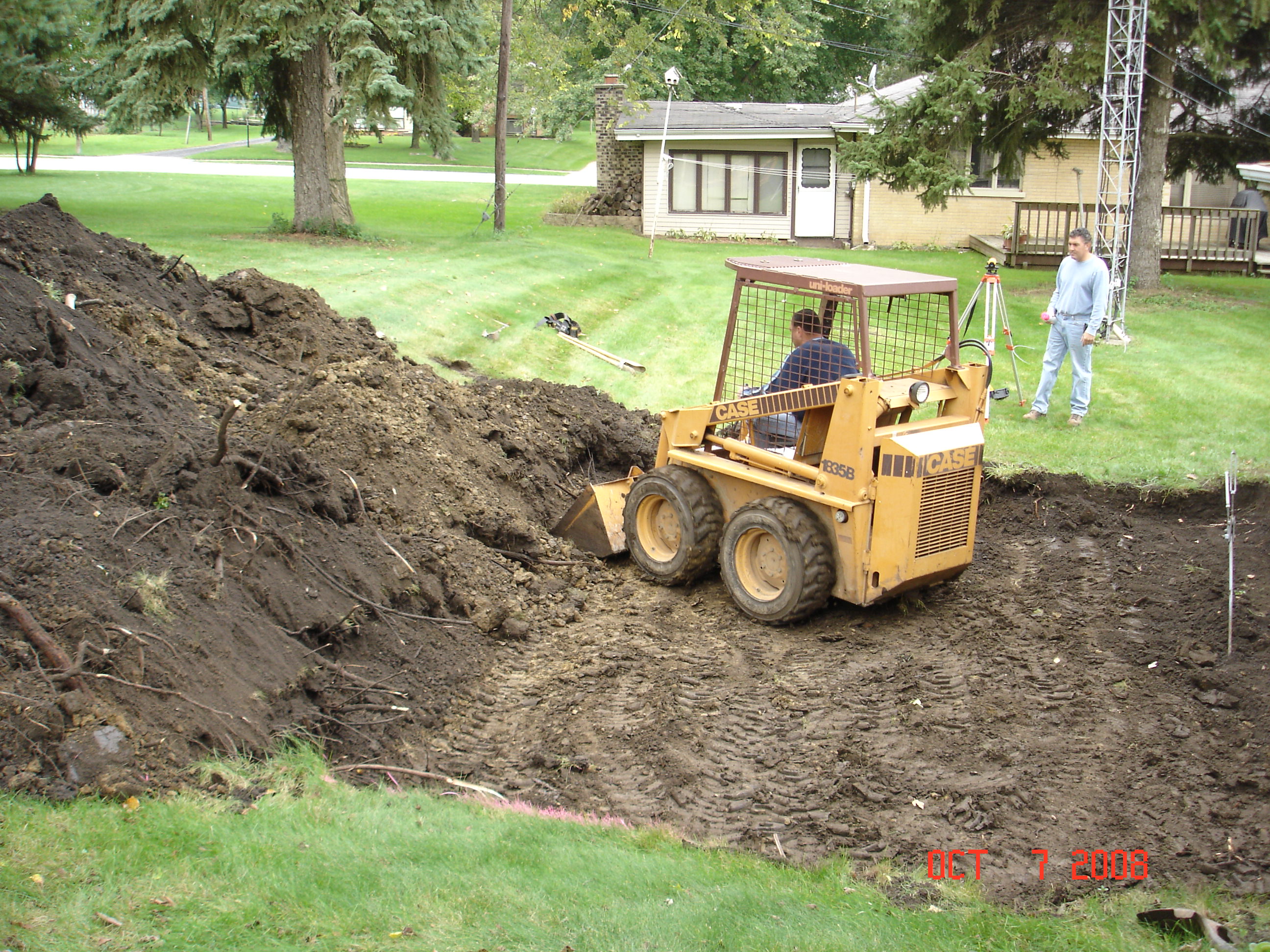

Day 1 (Tuesday 7 Oct 08): Digging and Forming Floor, Preparing wall and
drainage east side, Guy support I-Beam hole
(yes I disconnected the east guys down during the
'earth moving') (moisture damaged wood along the bottom of the existing
garage east wall will be replaced).

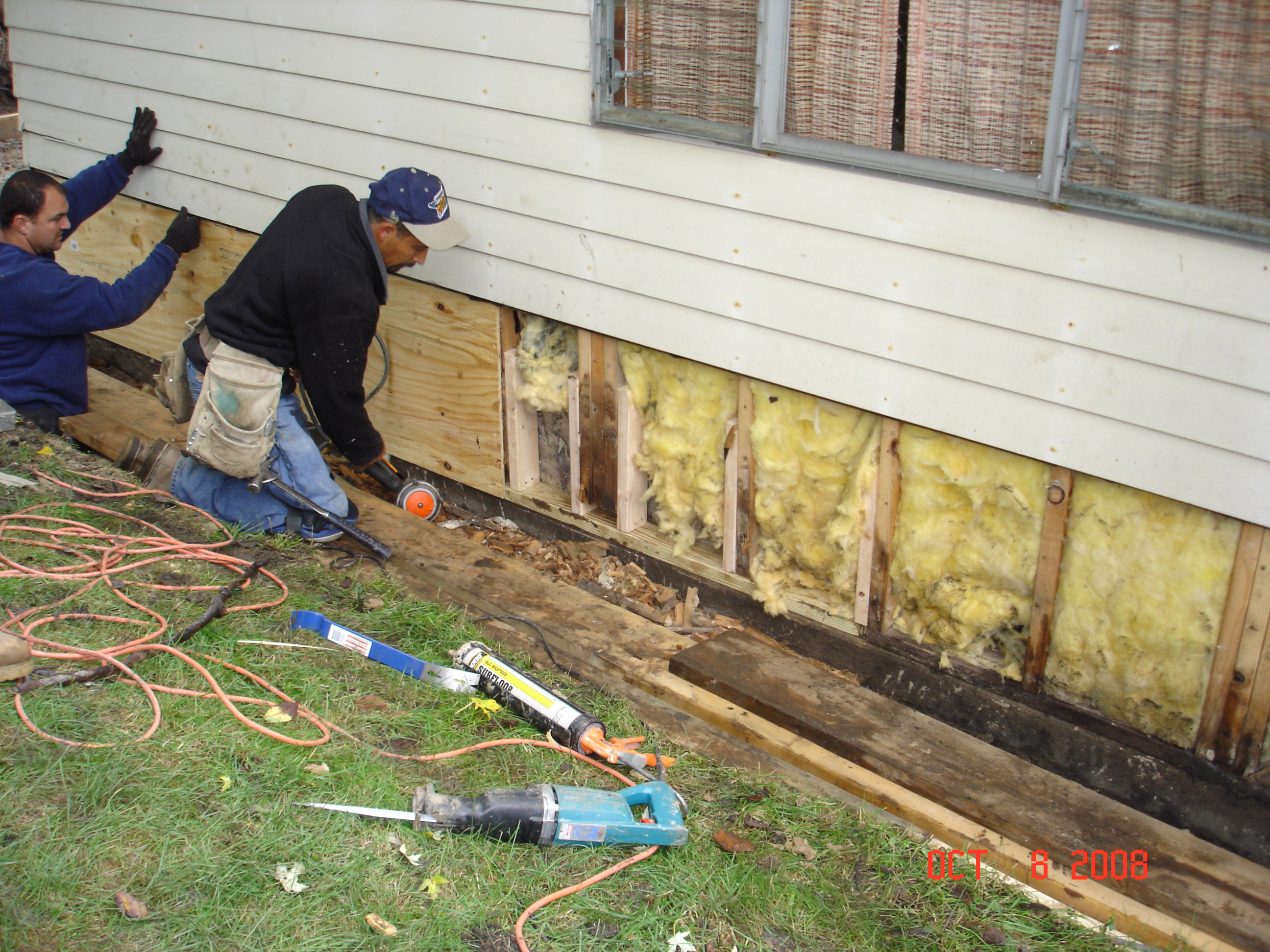

Day 2 (Wednesday 8 Oct 08): Repaired years of water damage on east wall of

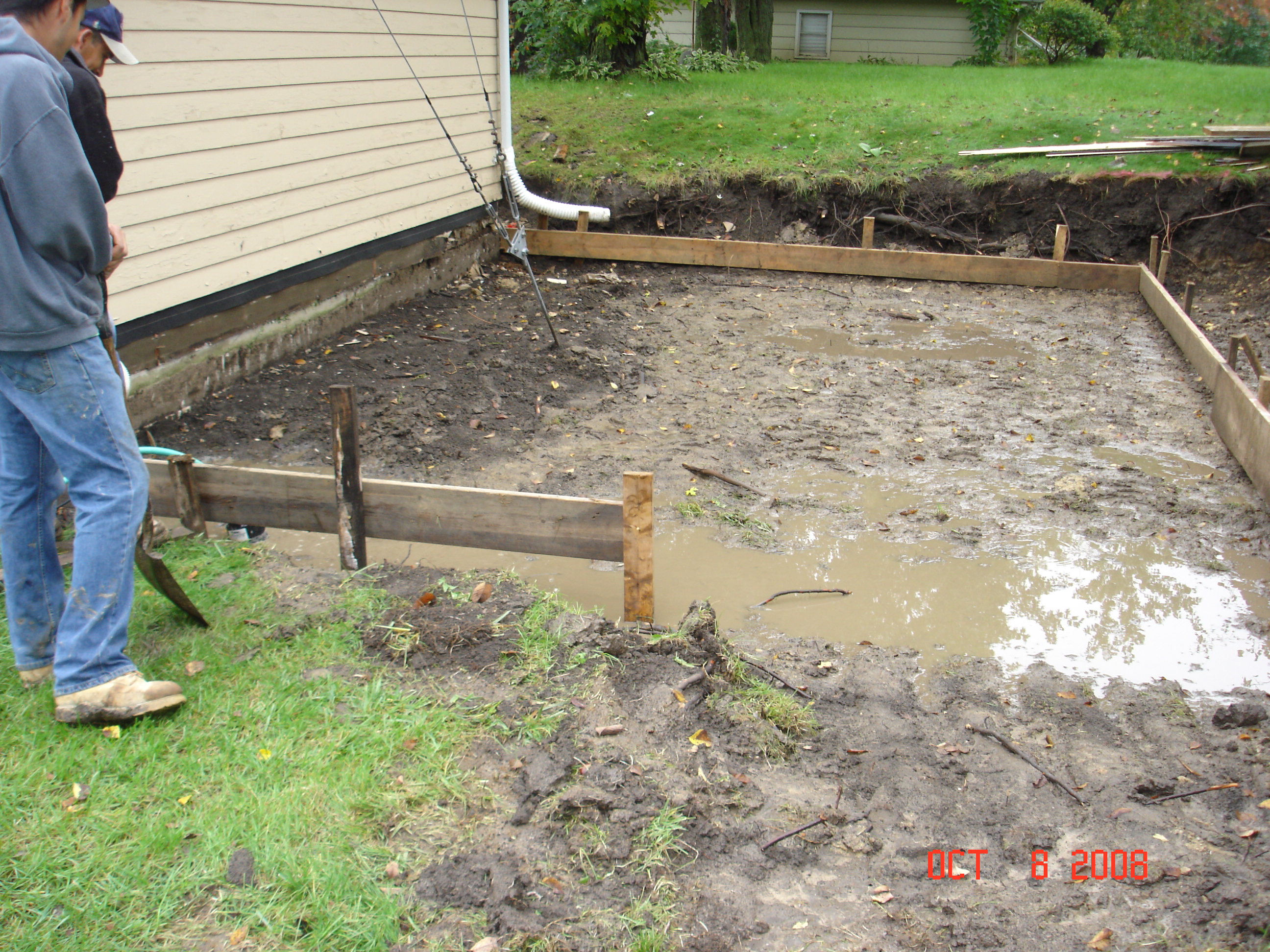

Garage. Previous day's rain has delayed putting
gravel foundation for the concrete floor.

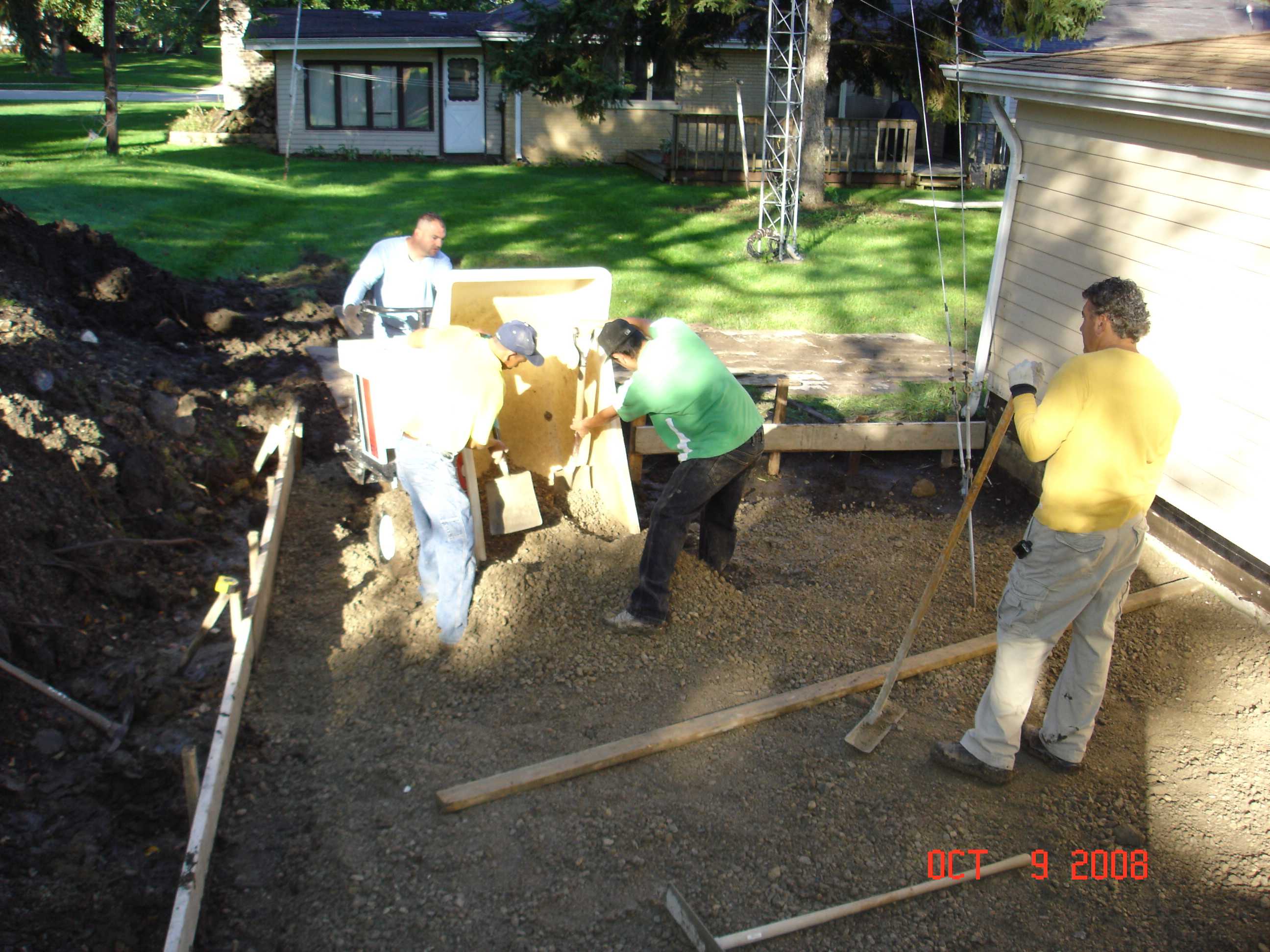

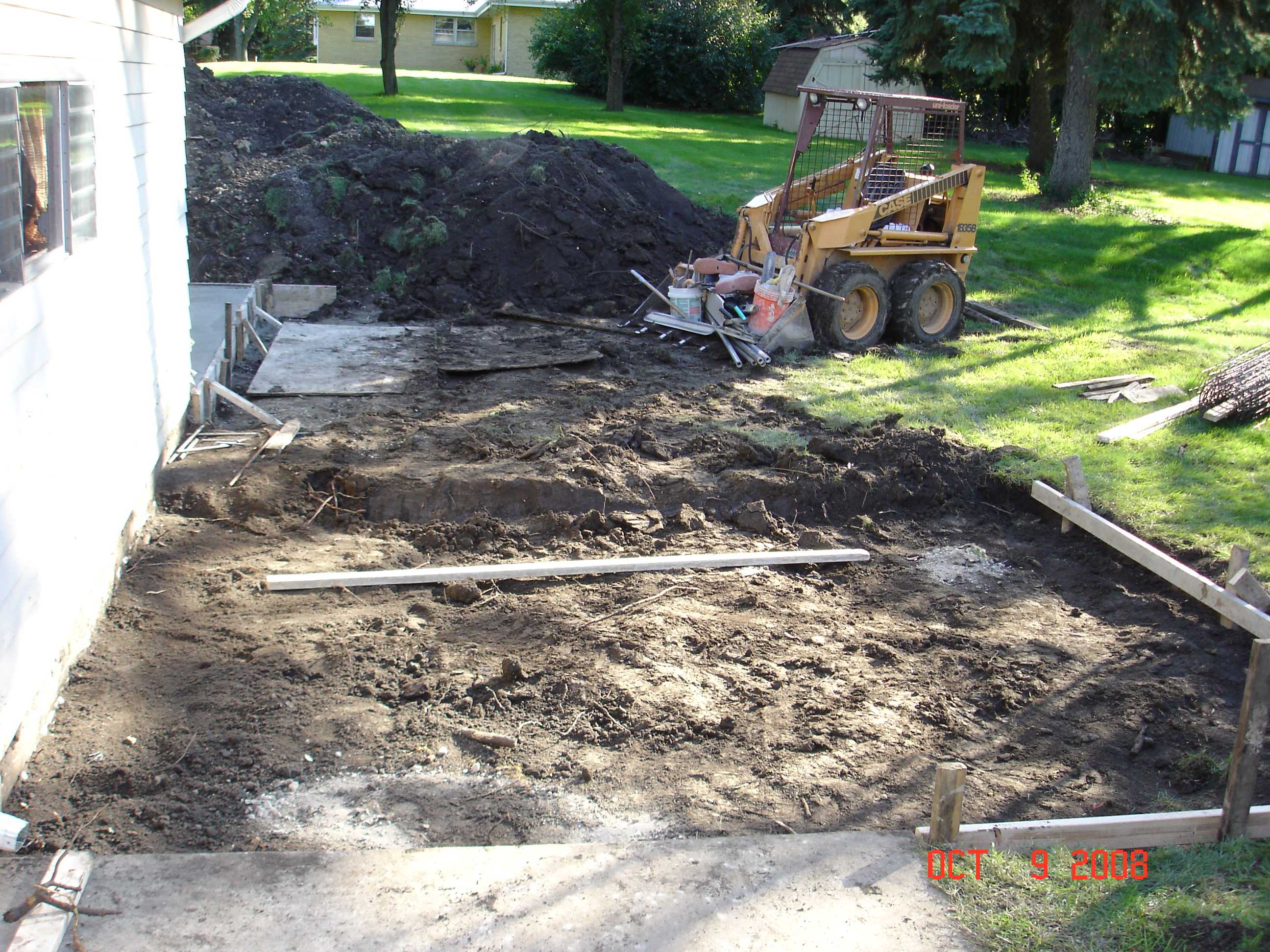

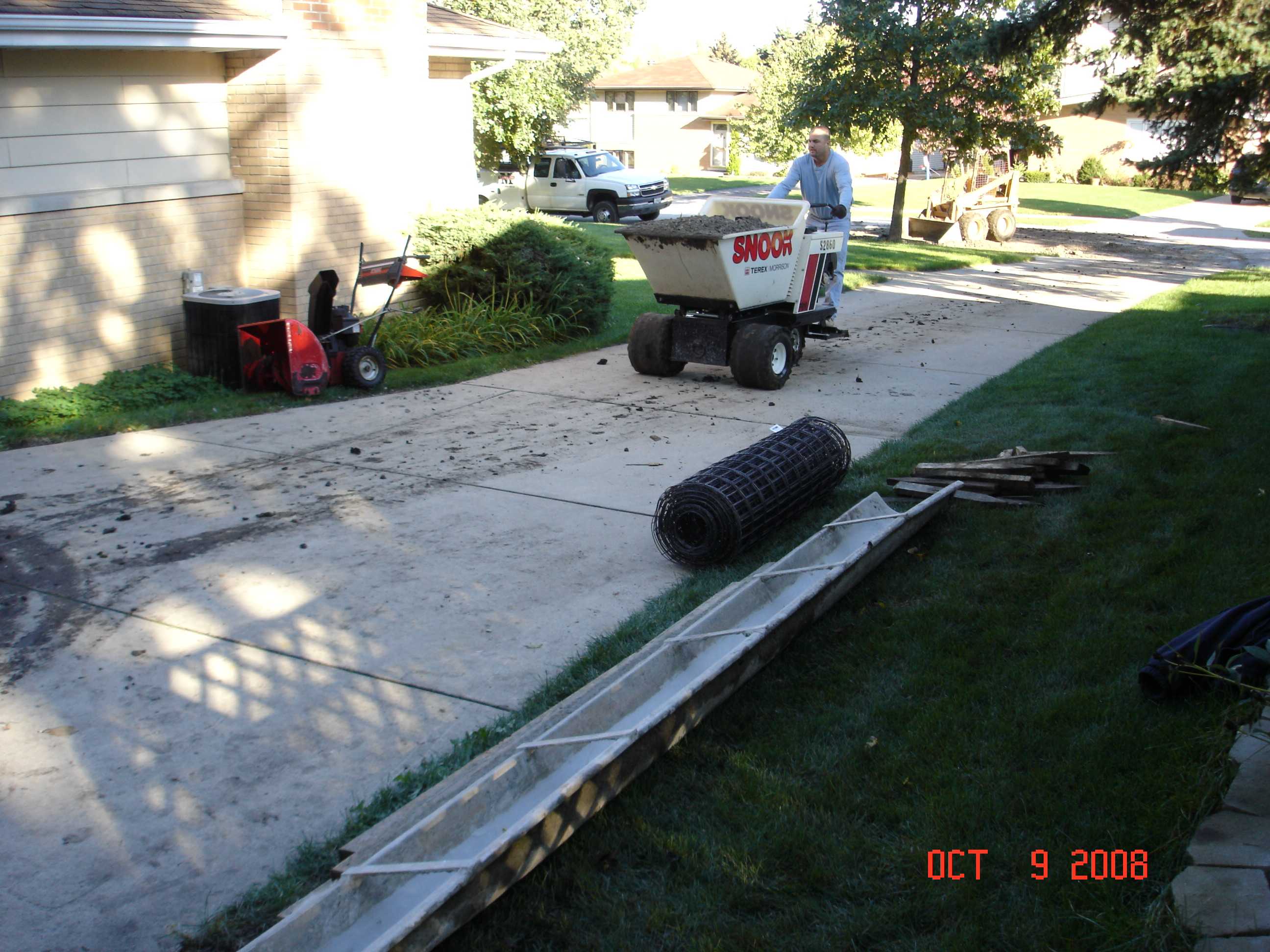

Day 3 (Thursday 9 Oct 08): Gravel 'trucked' up the driveway, gravel added,

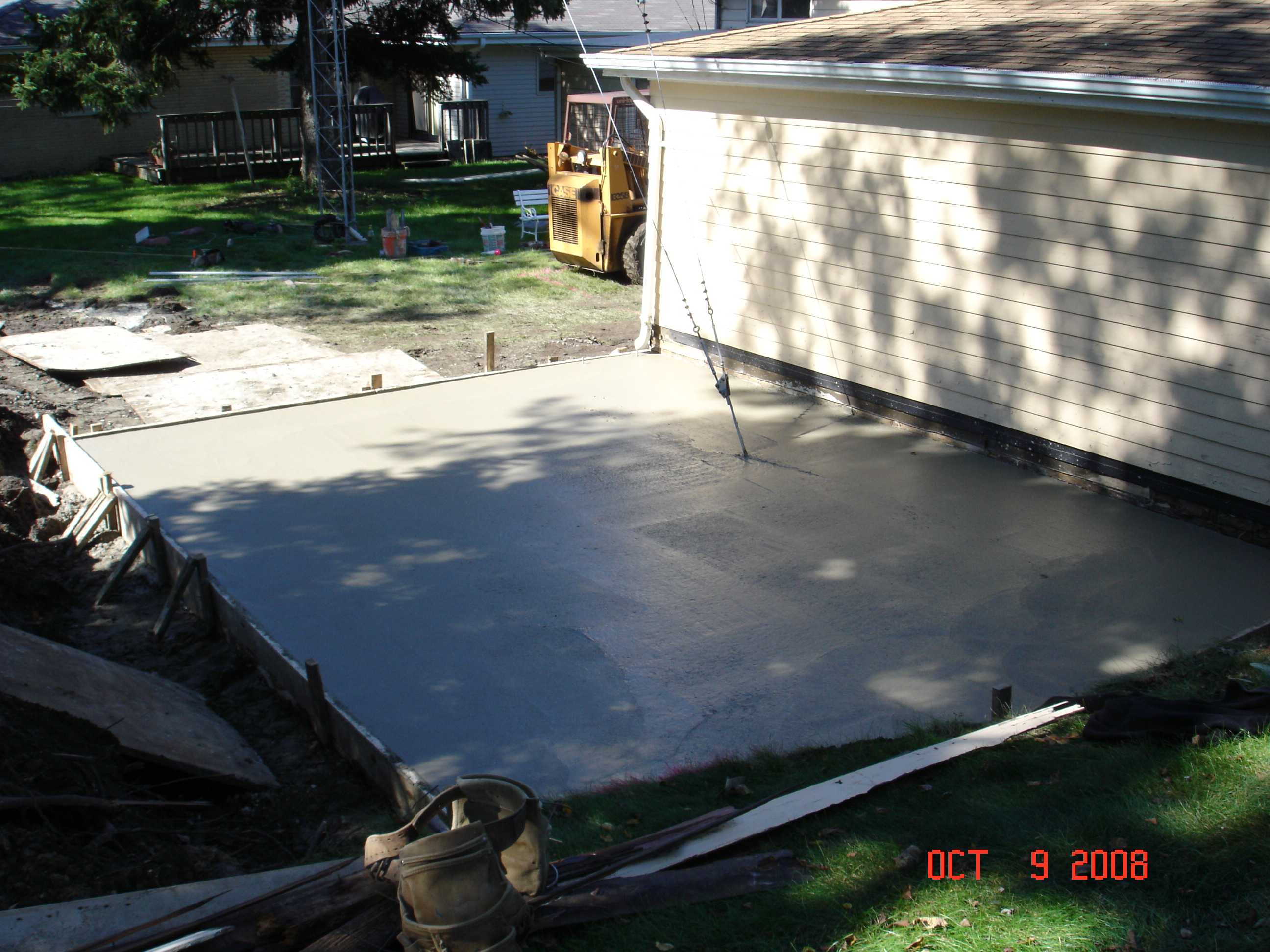

NEW concrete #1 floor, new patio being formed.

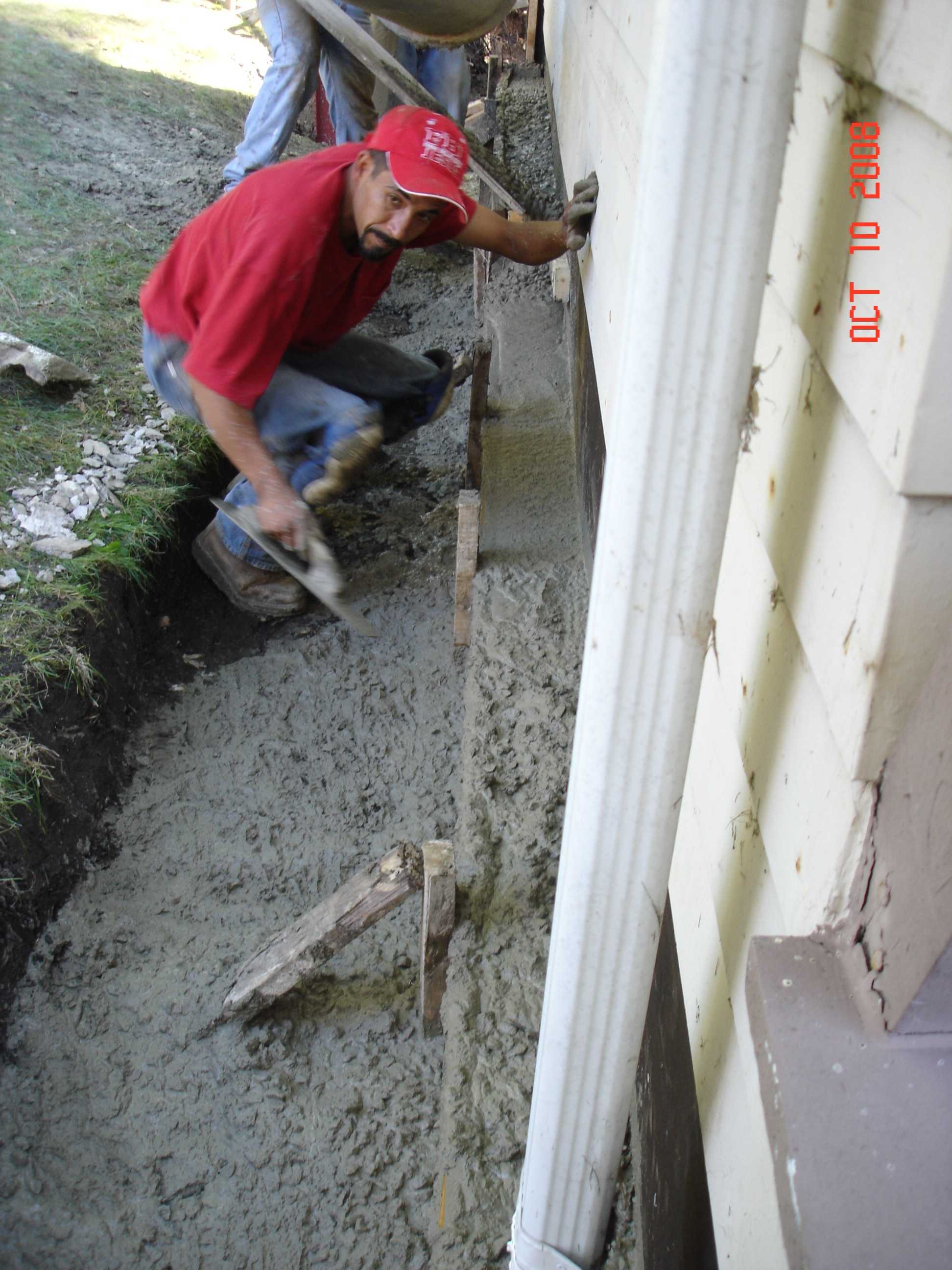

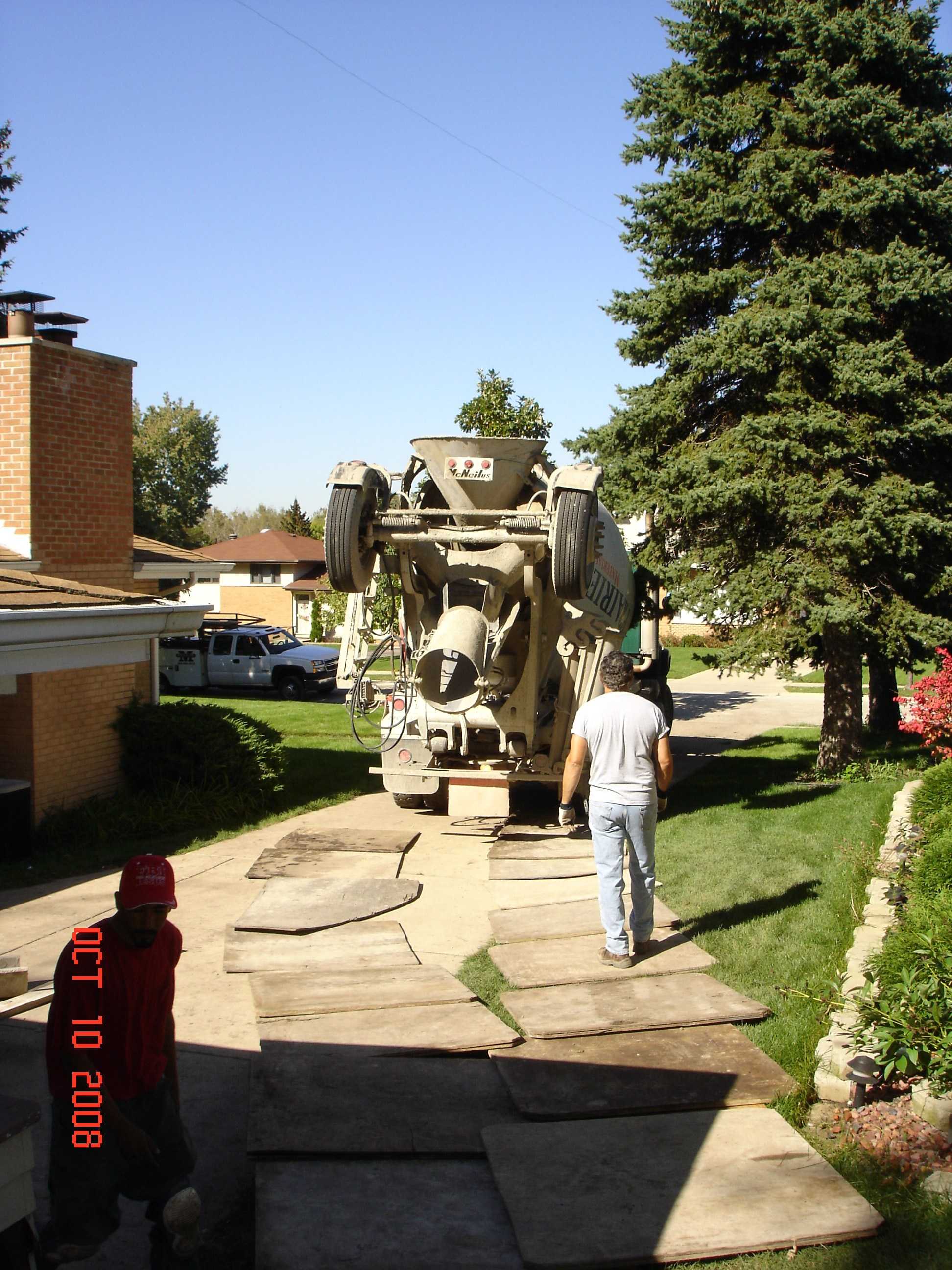

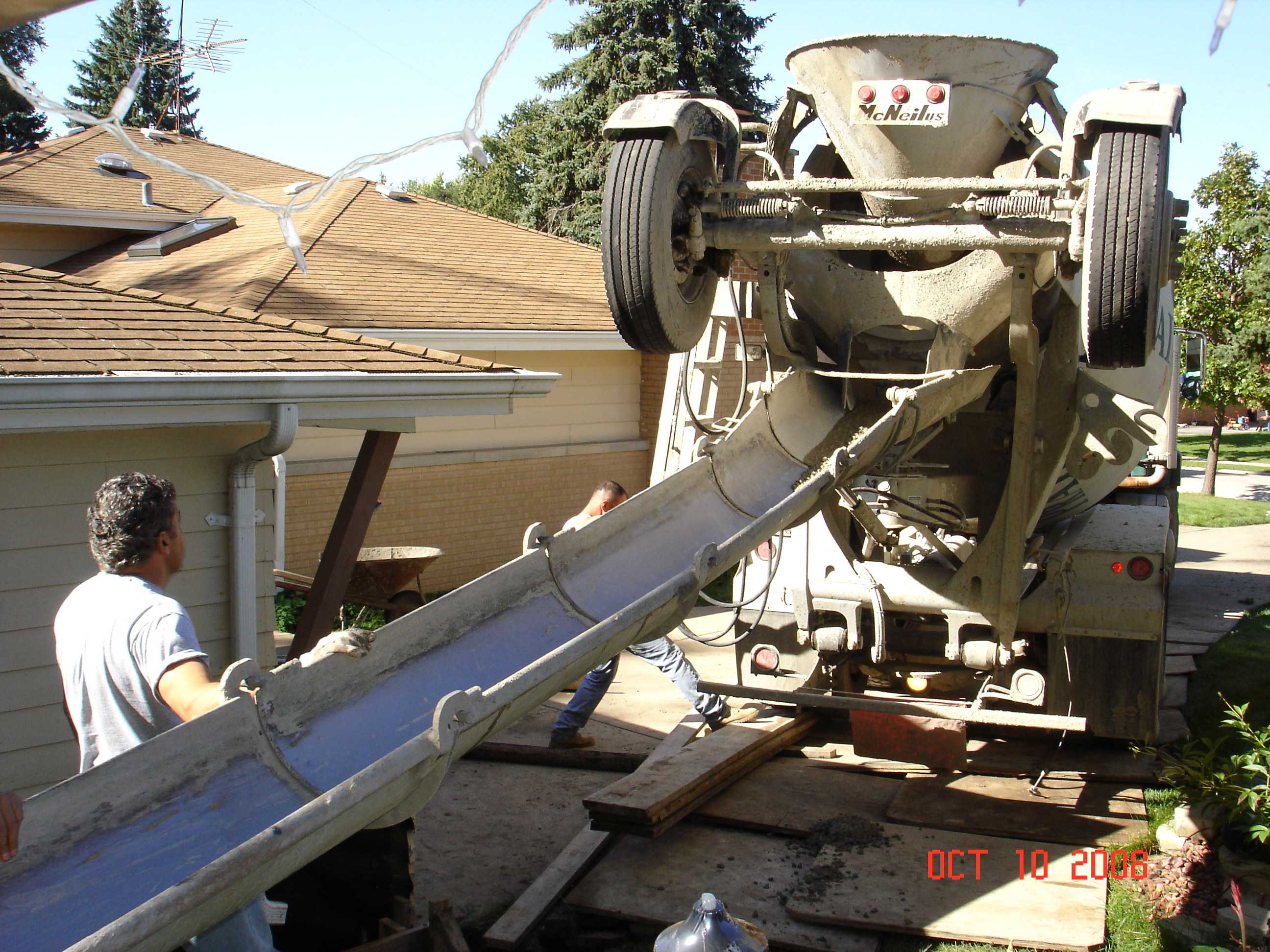

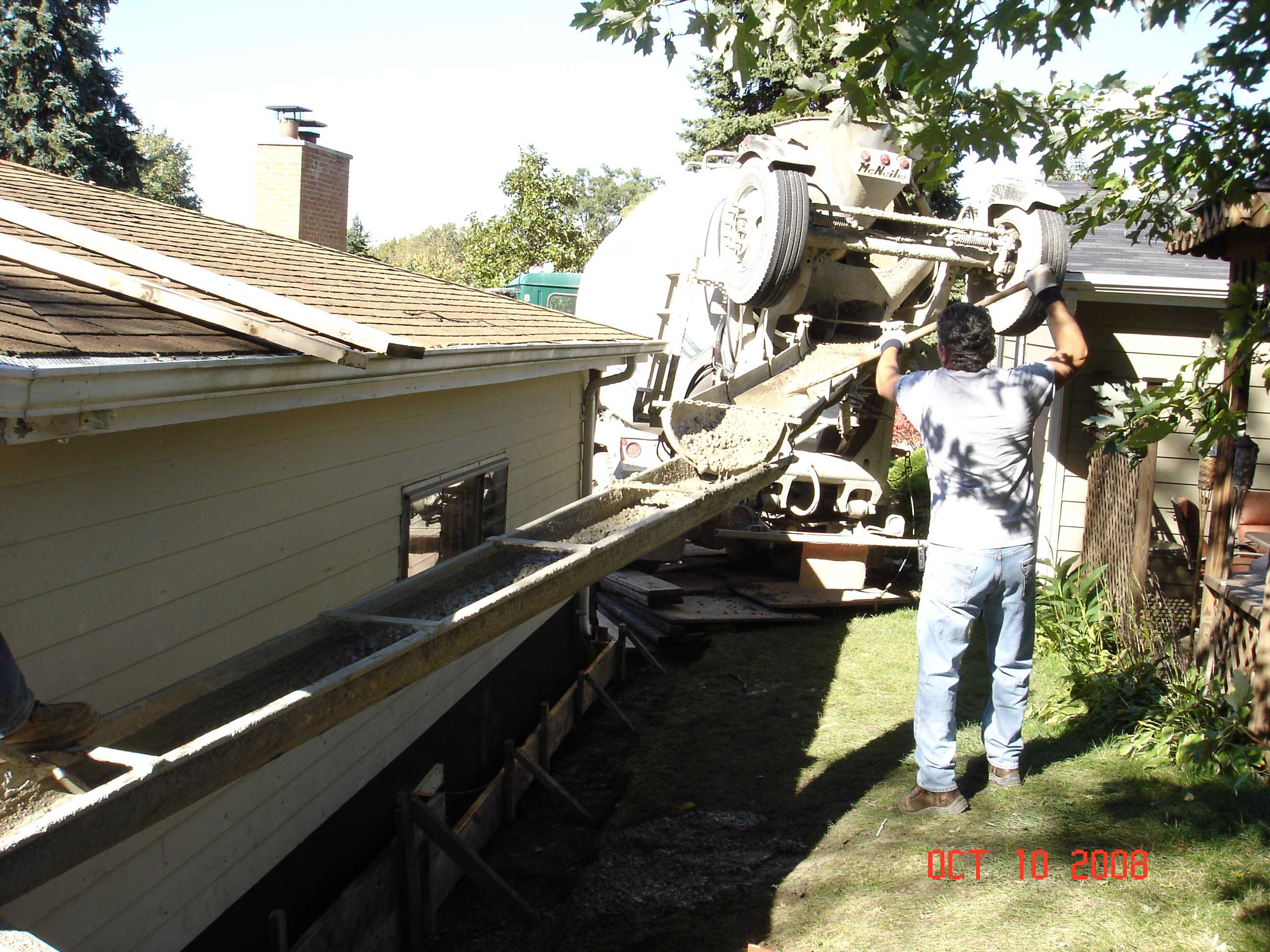

Day 4 (Friday 10 Oct 08): How do you get concrete #2 back to the retaining wall in the rear? You use gravity & push it.

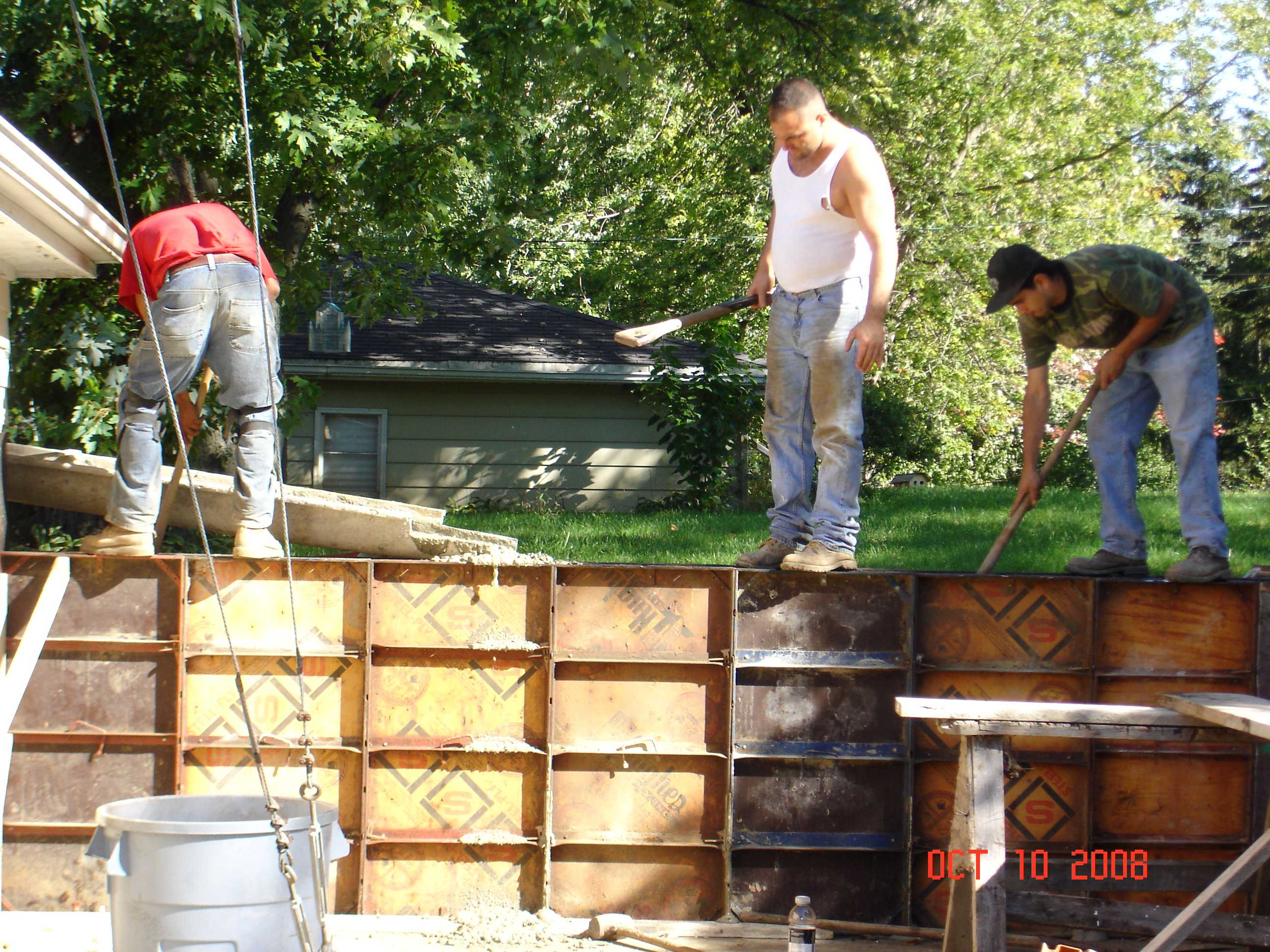

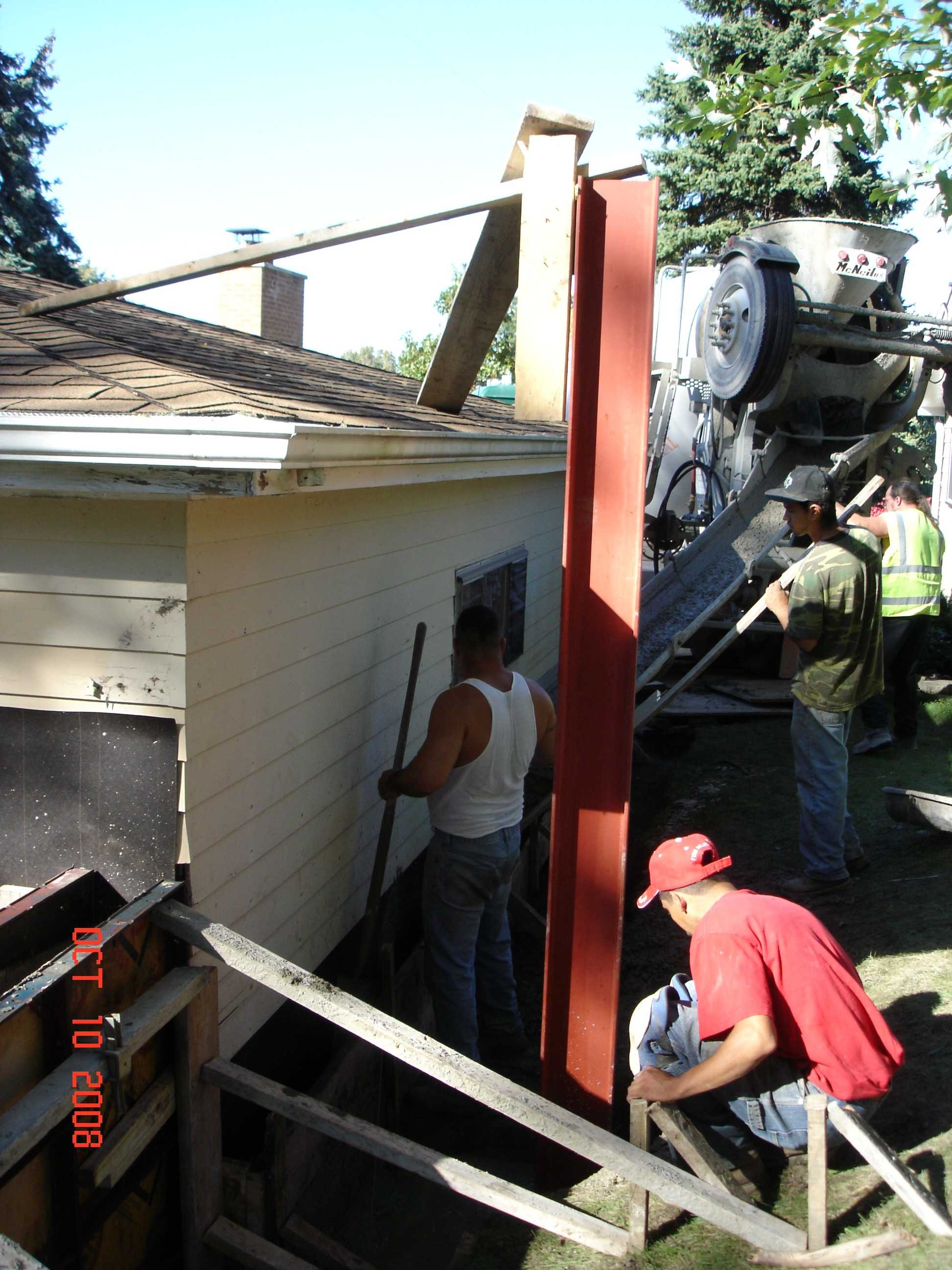

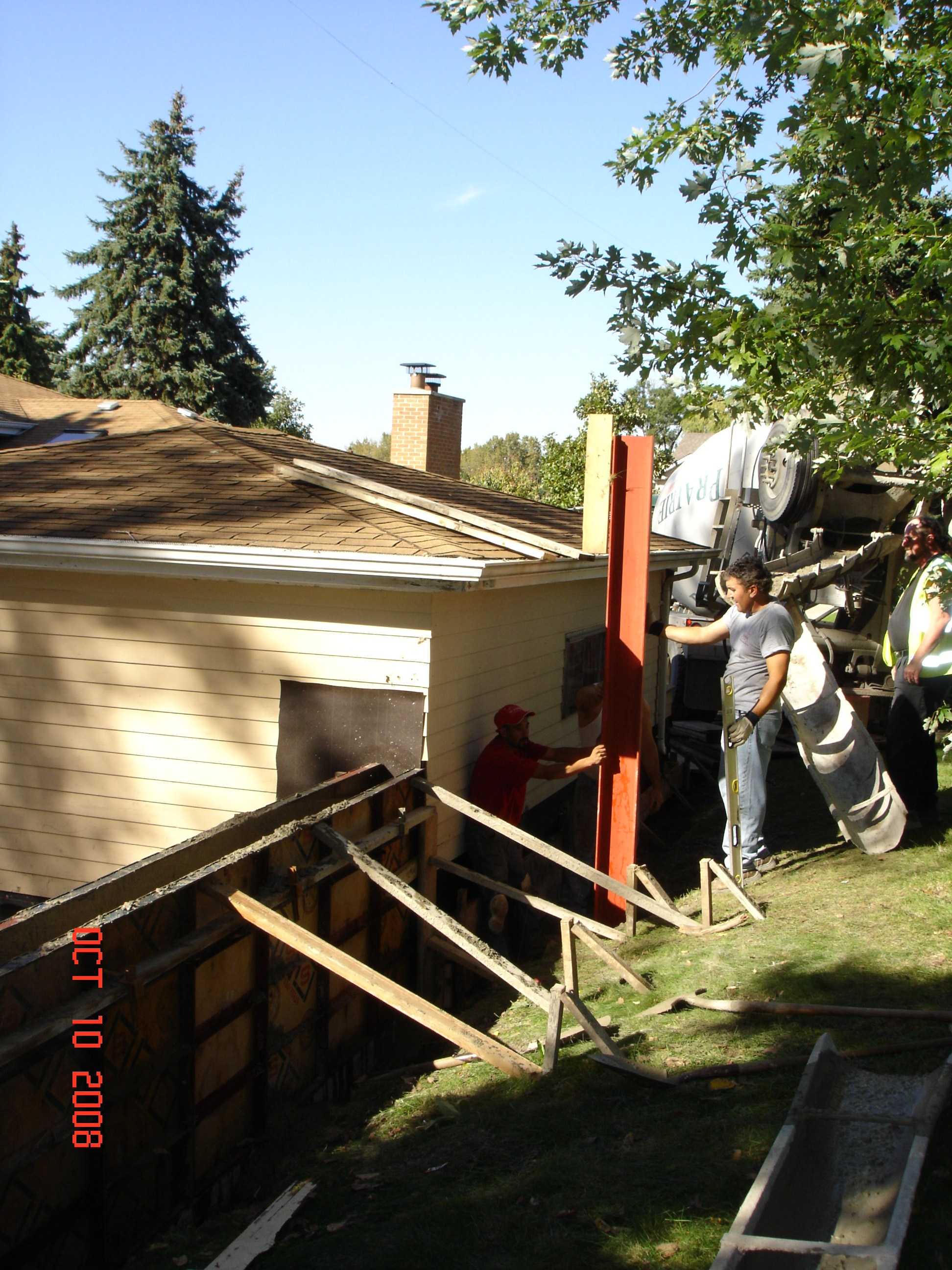

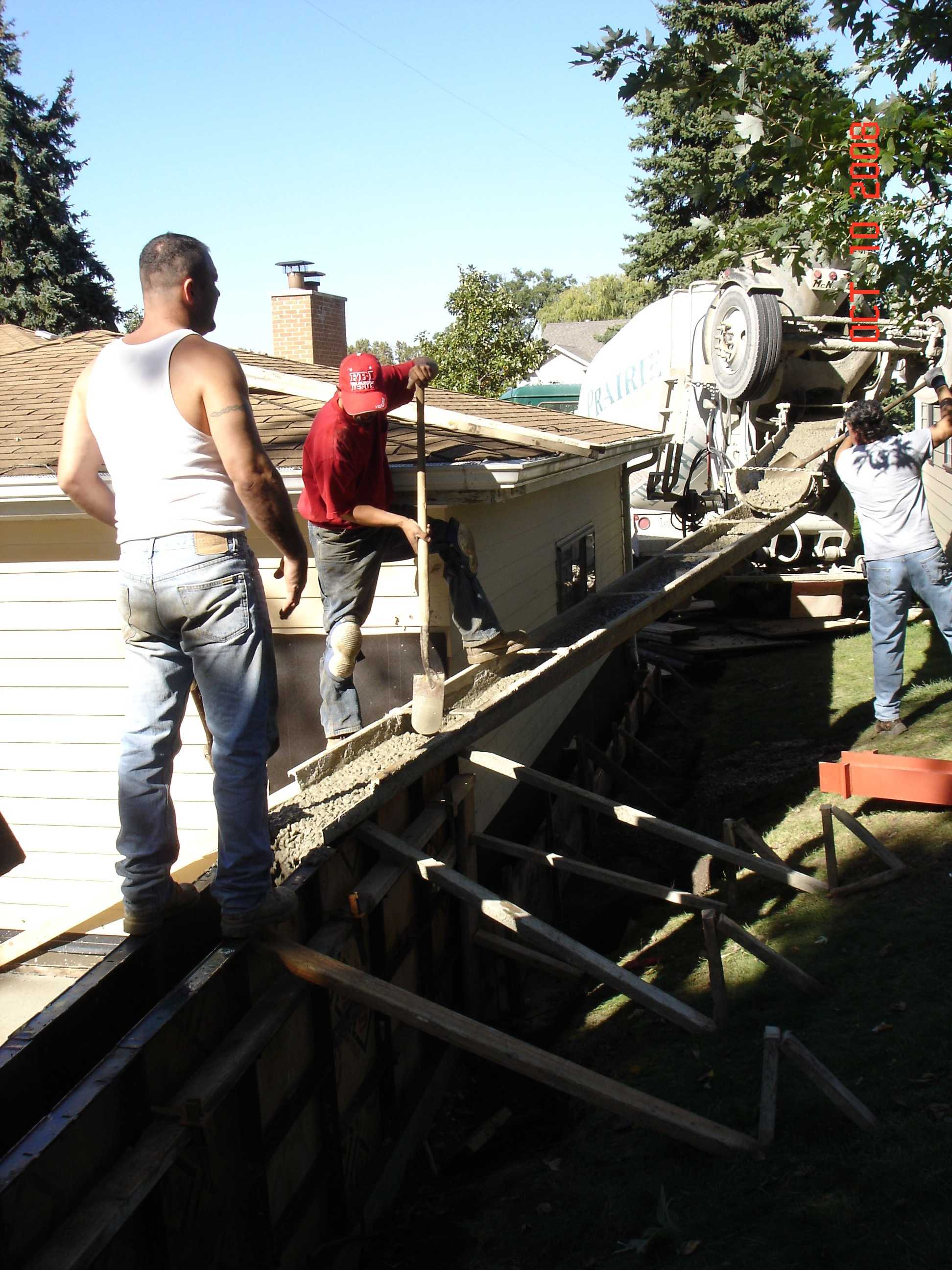

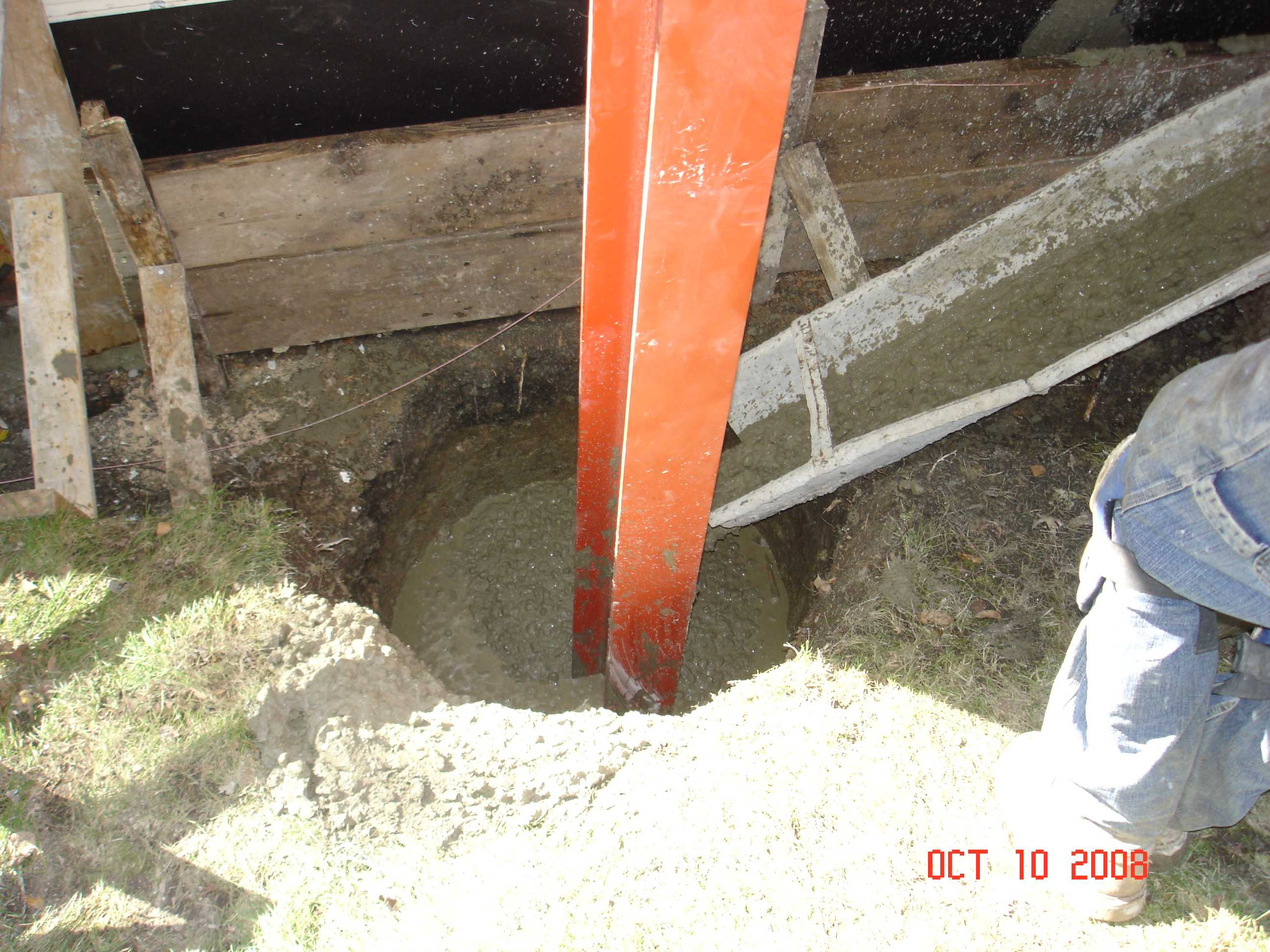

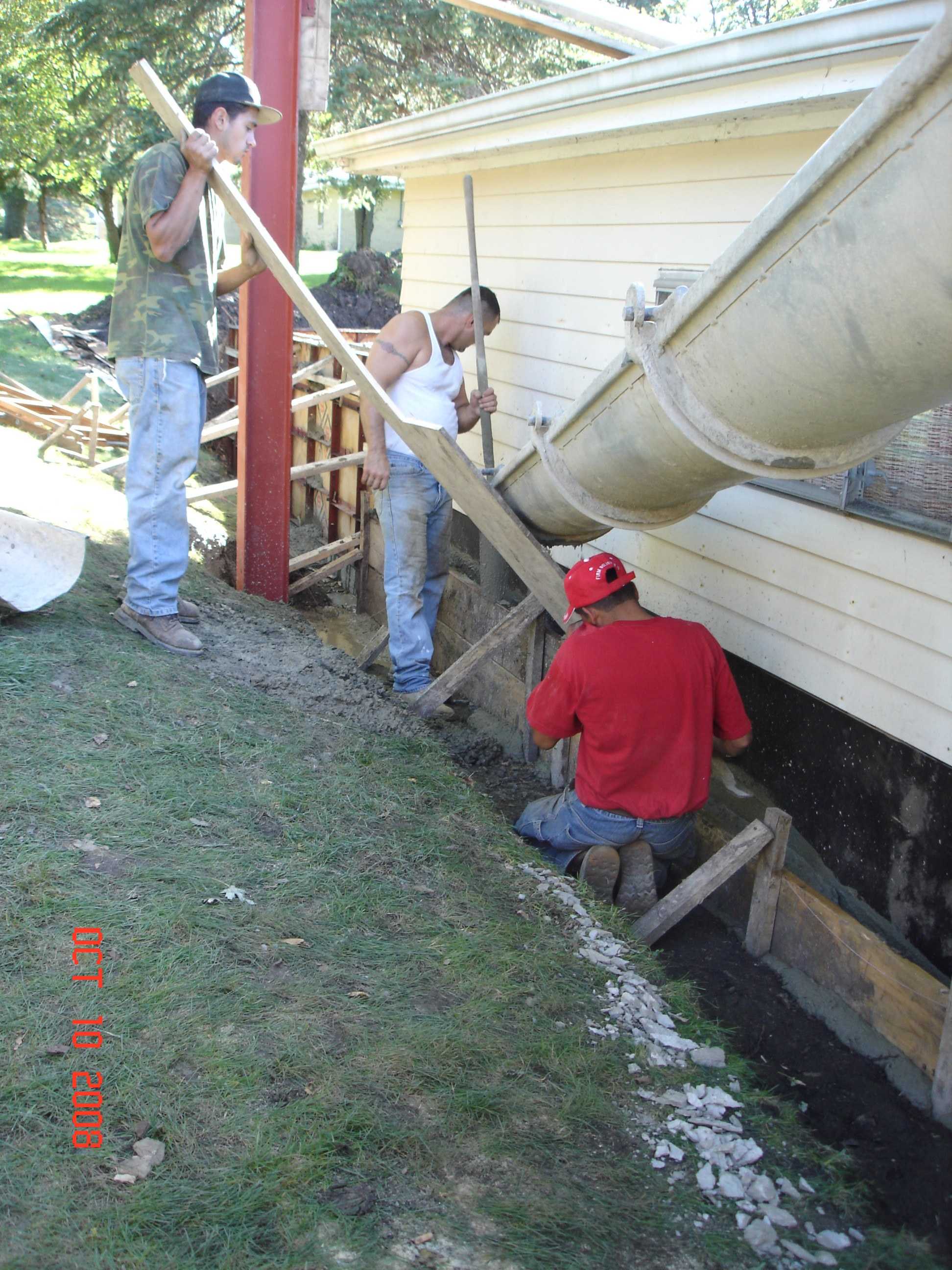

Day 4 Continued (Friday 10 Oct 08): Erecting and concreting #2 the I-Beam & the
pouring the existing garage's retaining wall

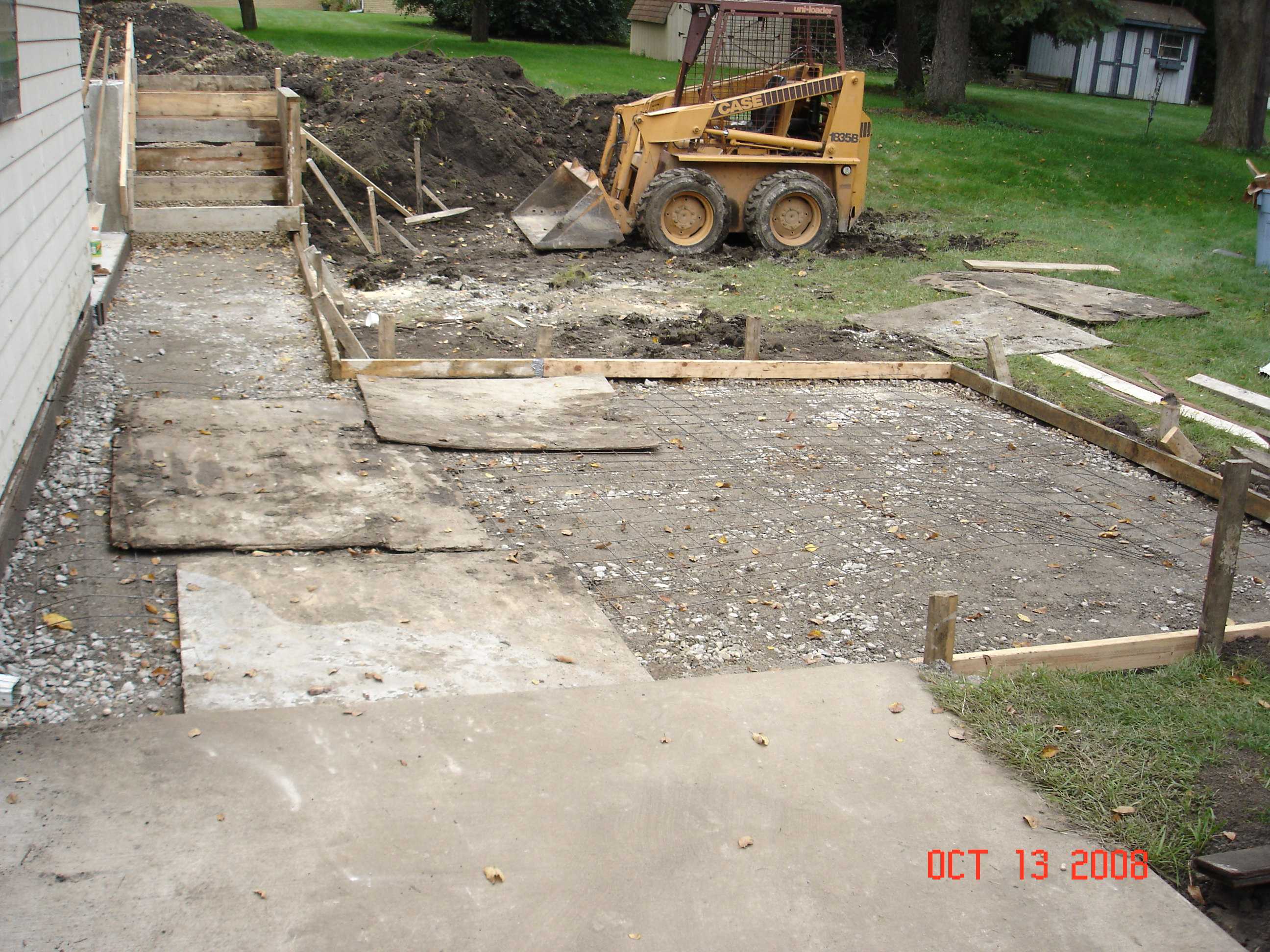

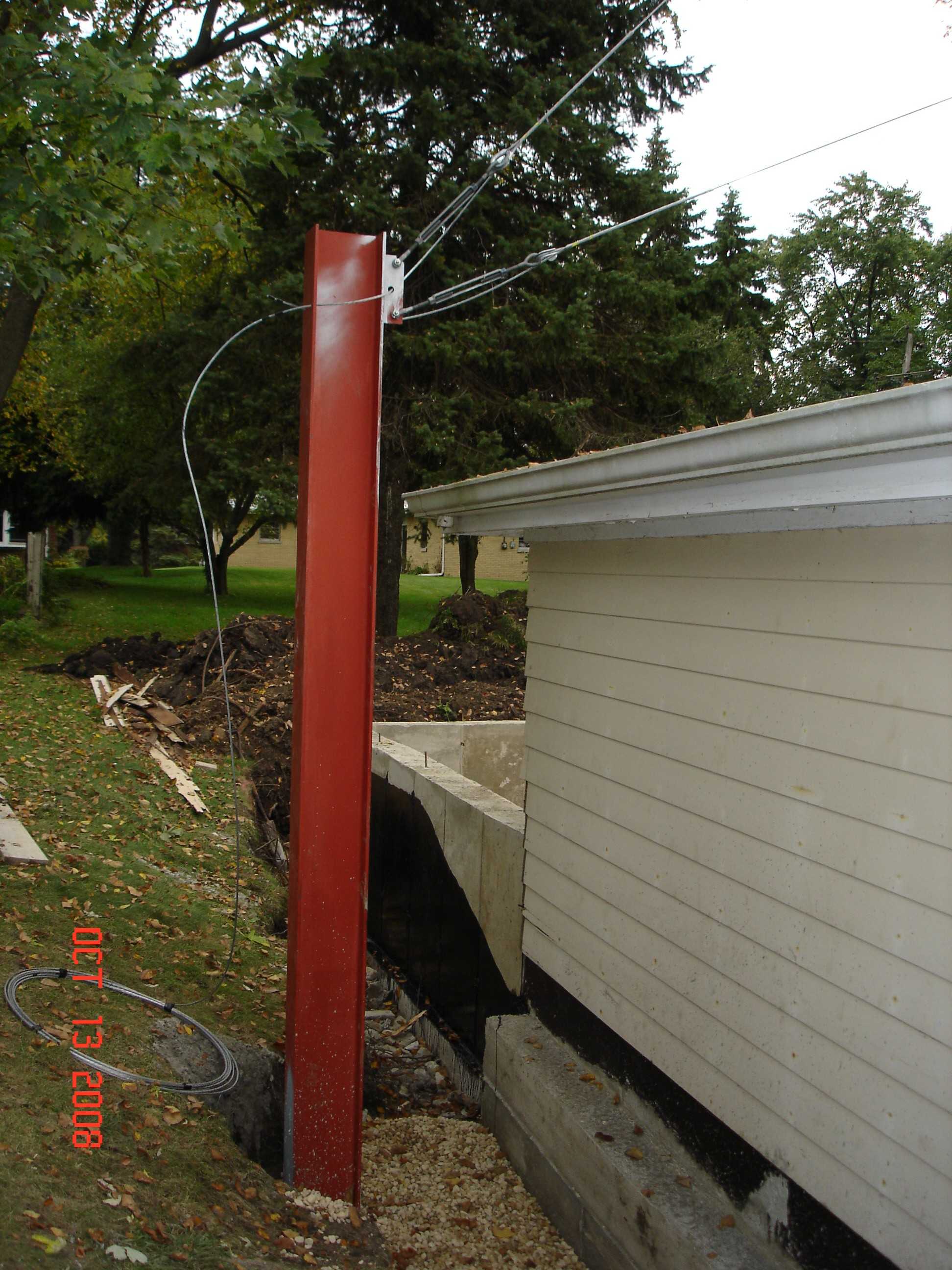

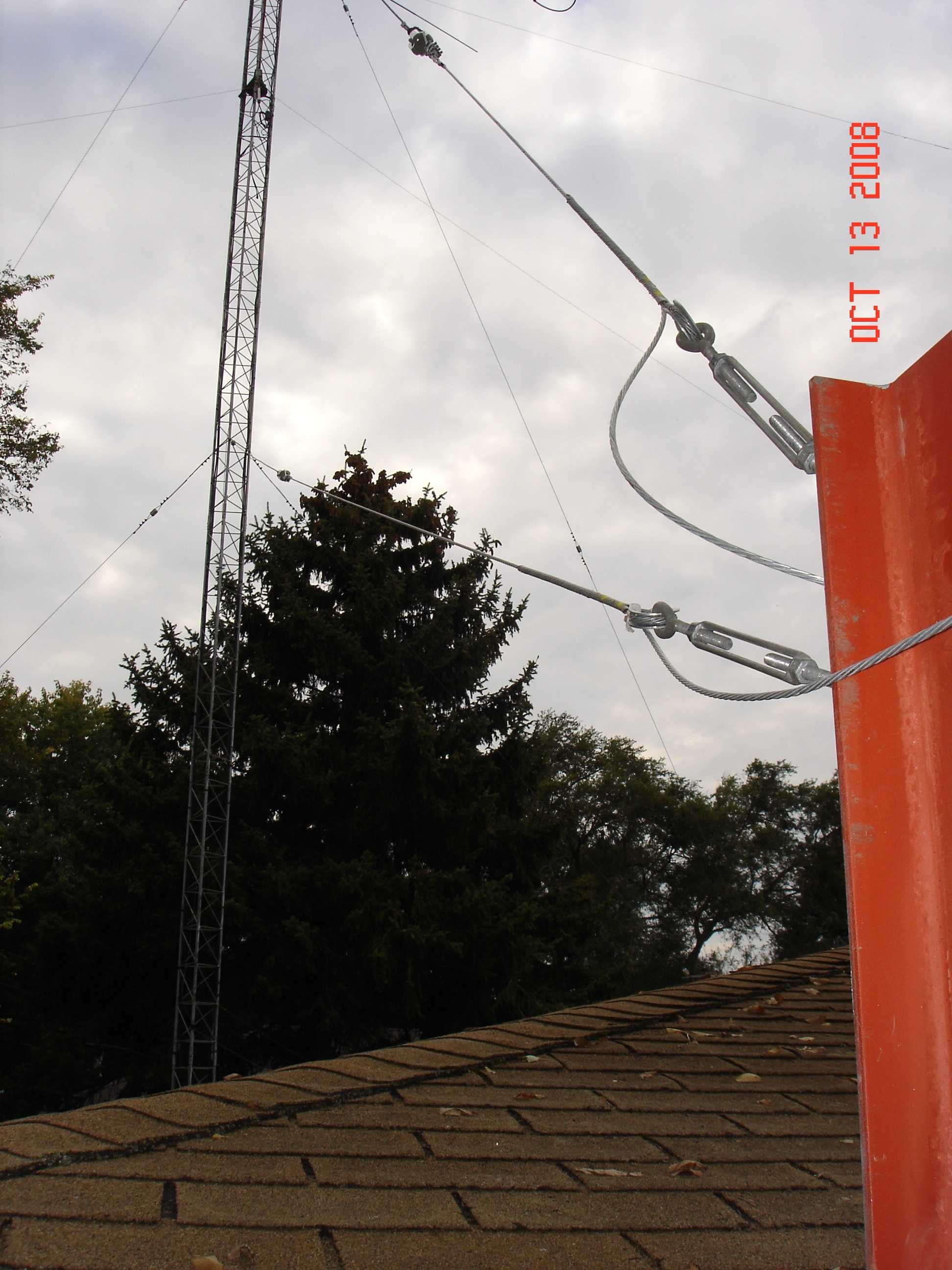

Day 5 (Monday 13 Oct 08): Guy Cables attached to new I-Beam support,

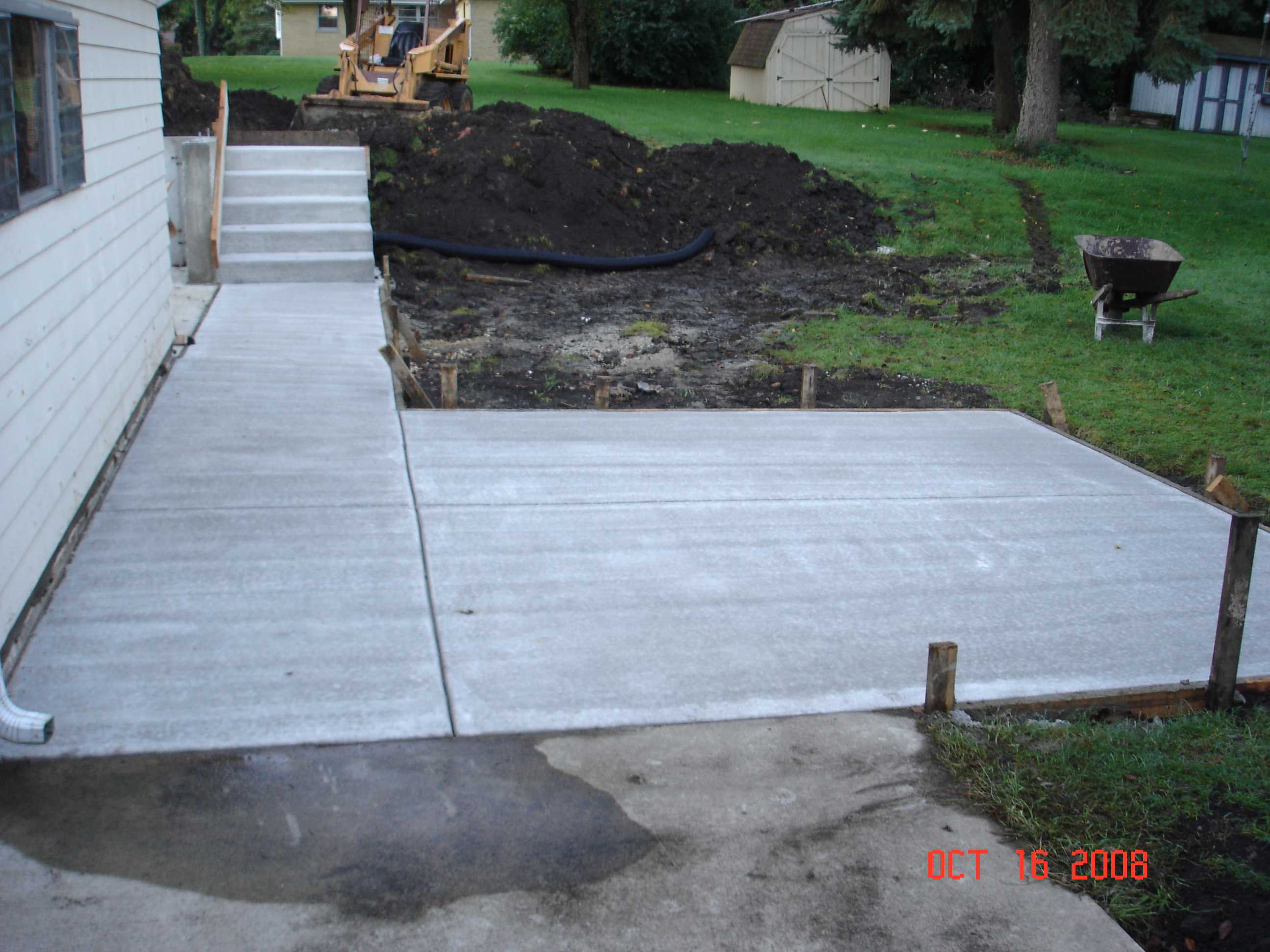

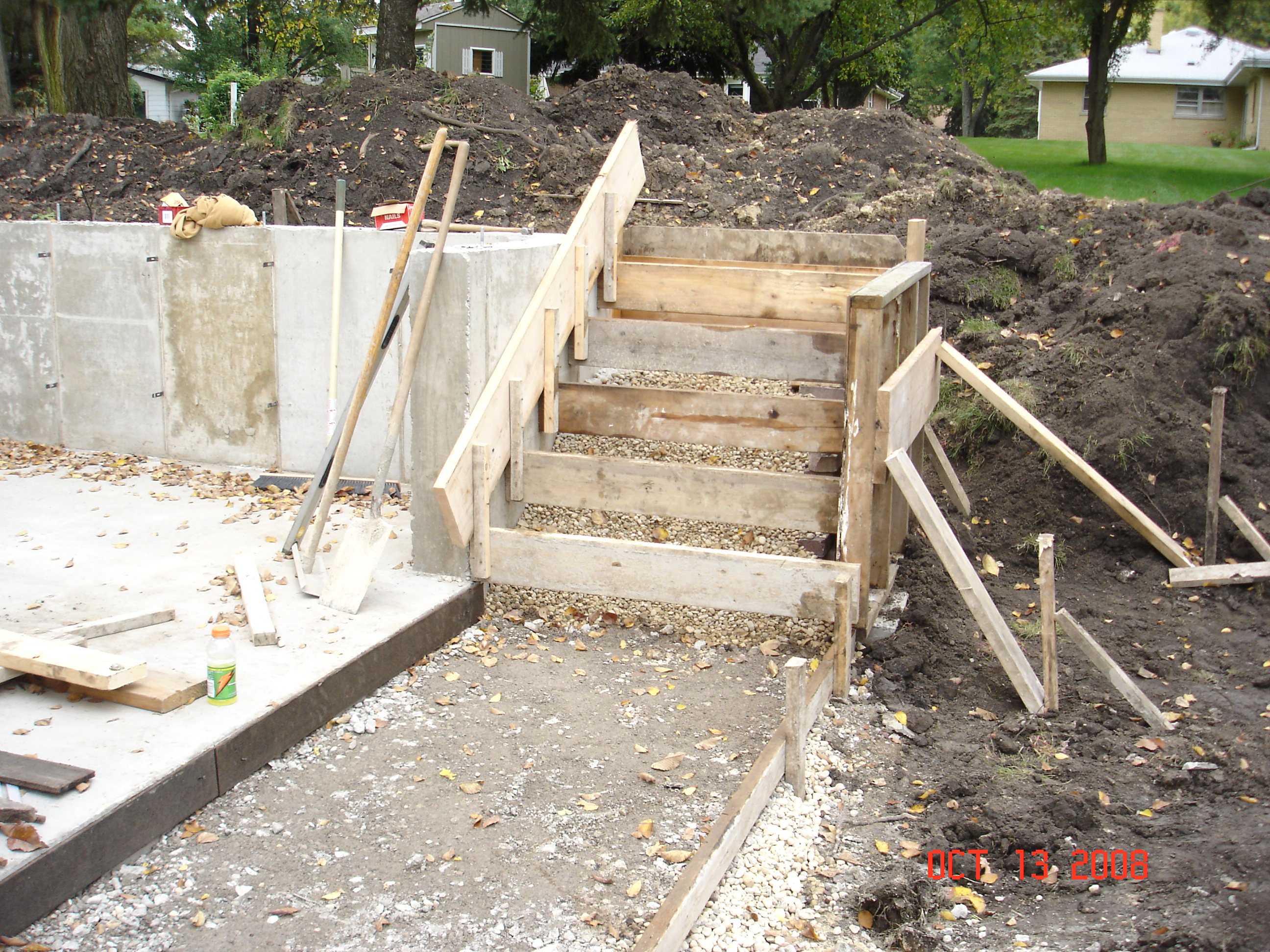

Preparation for Concrete #3: Patio, sidewalk
to stairs, stairs to rear on new garage.

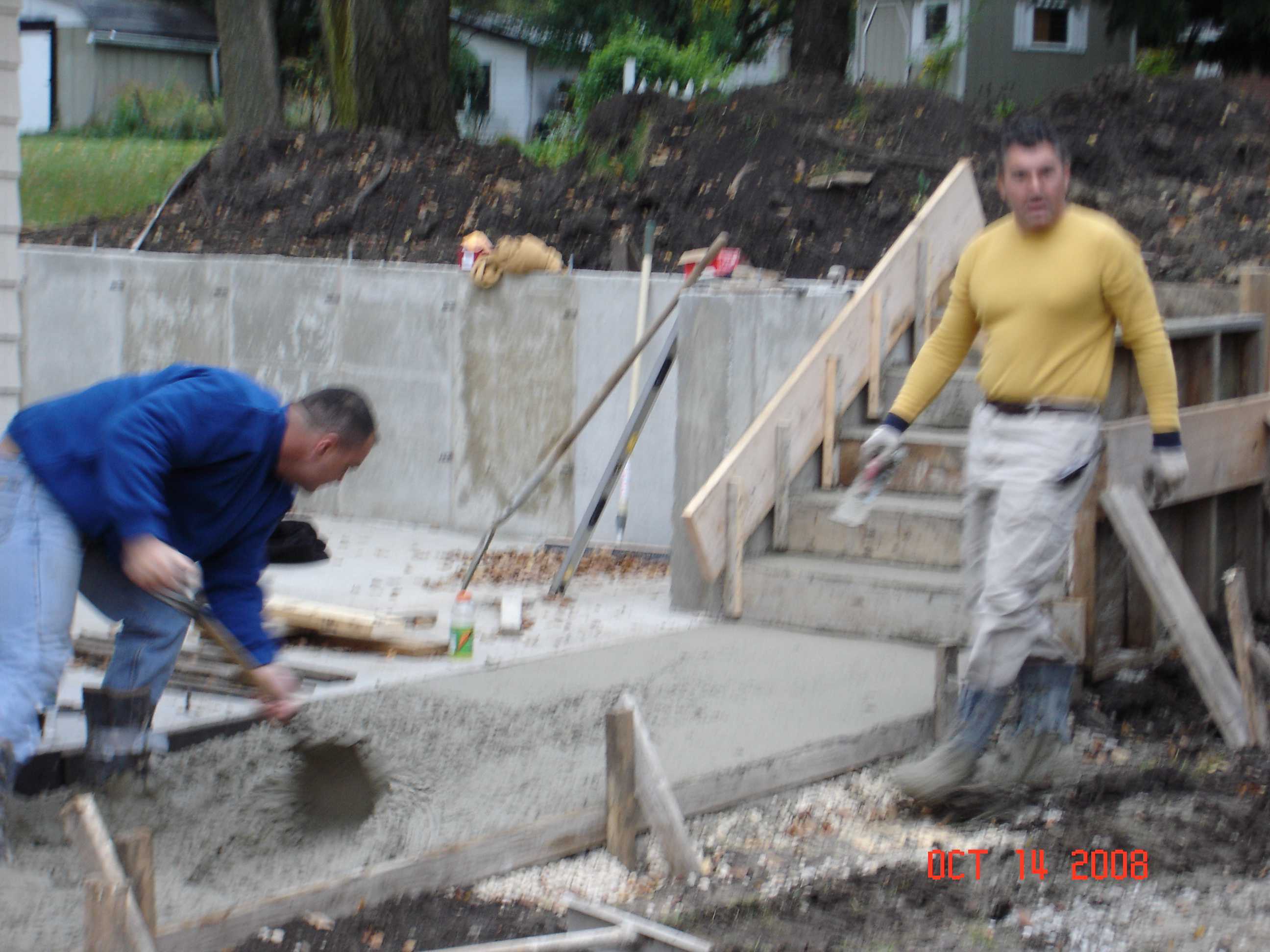

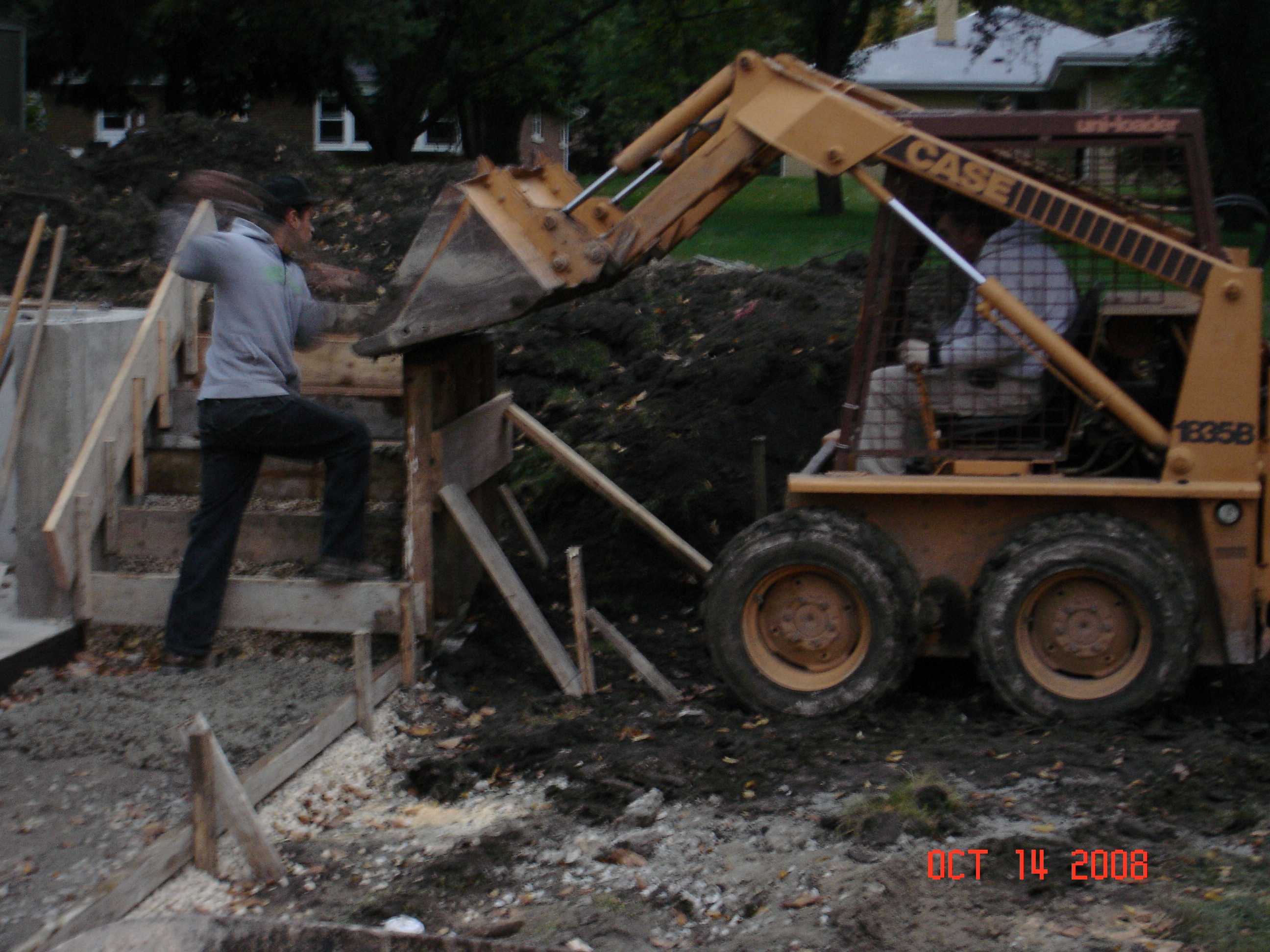

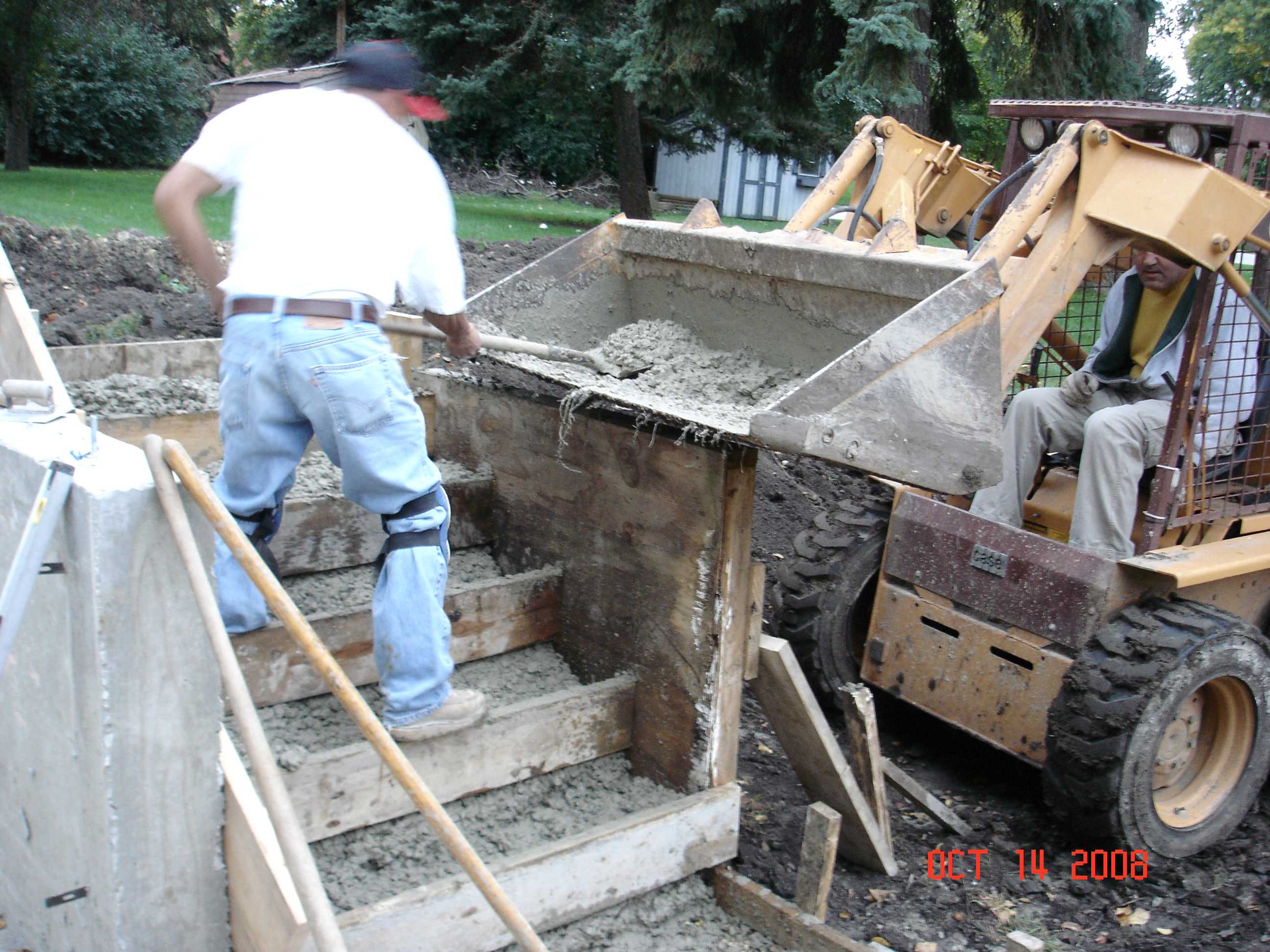

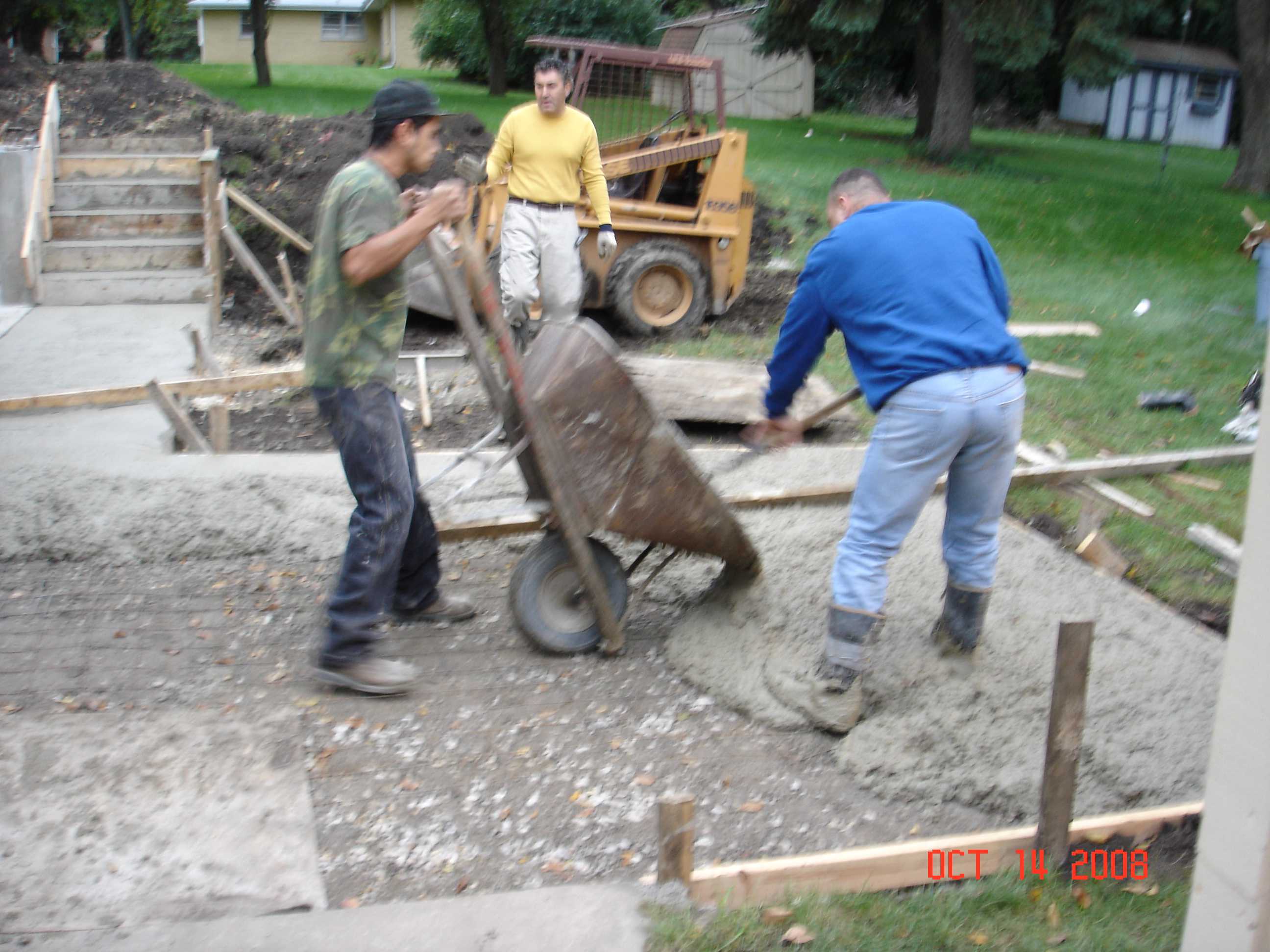

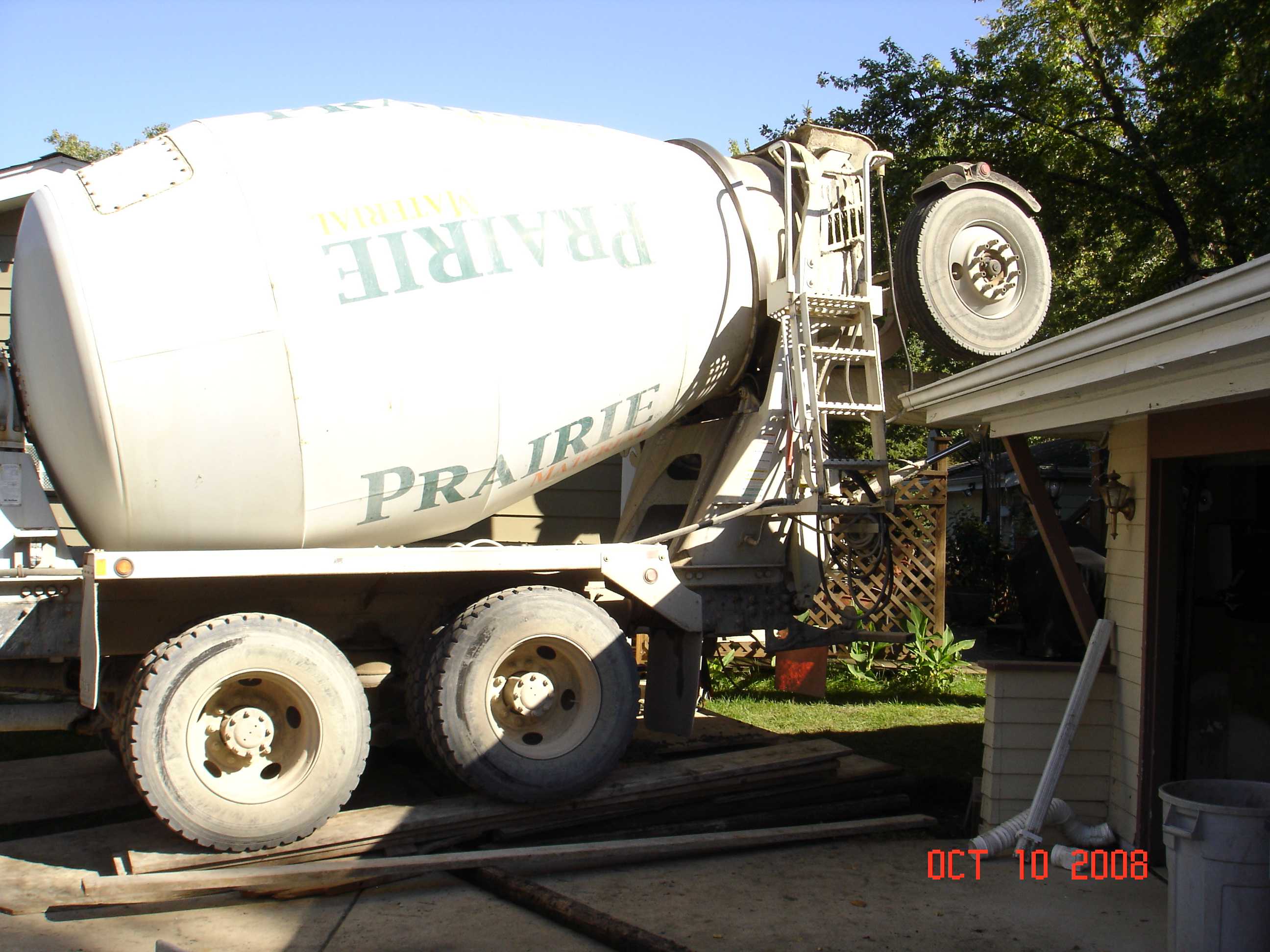

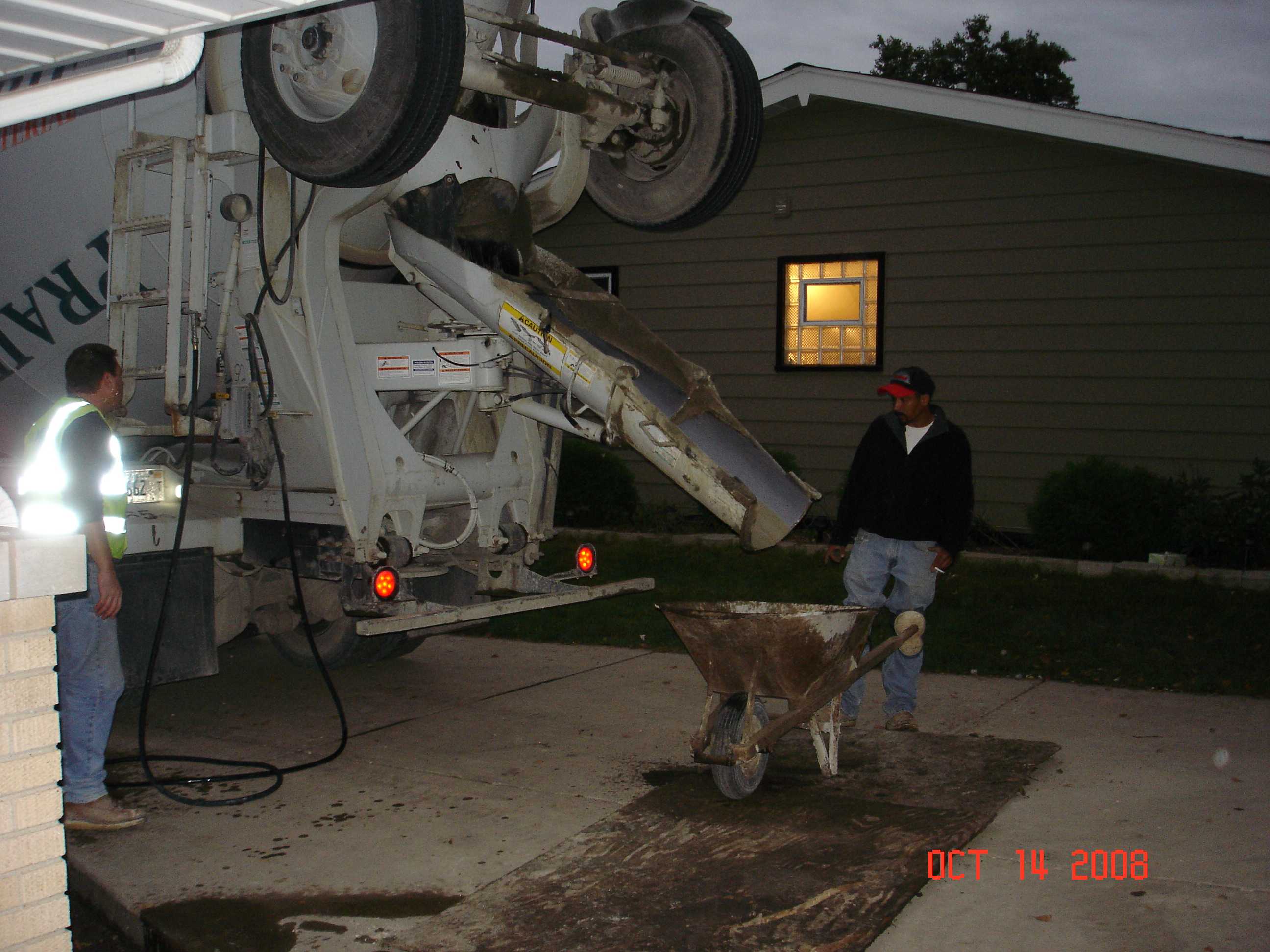

Day 6 (Tuesday 14 Oct 08): Final Concrete pouring #3 at Dawn

Day 7 (Wednesday 15 Oct 08): RAIN DAY - no work

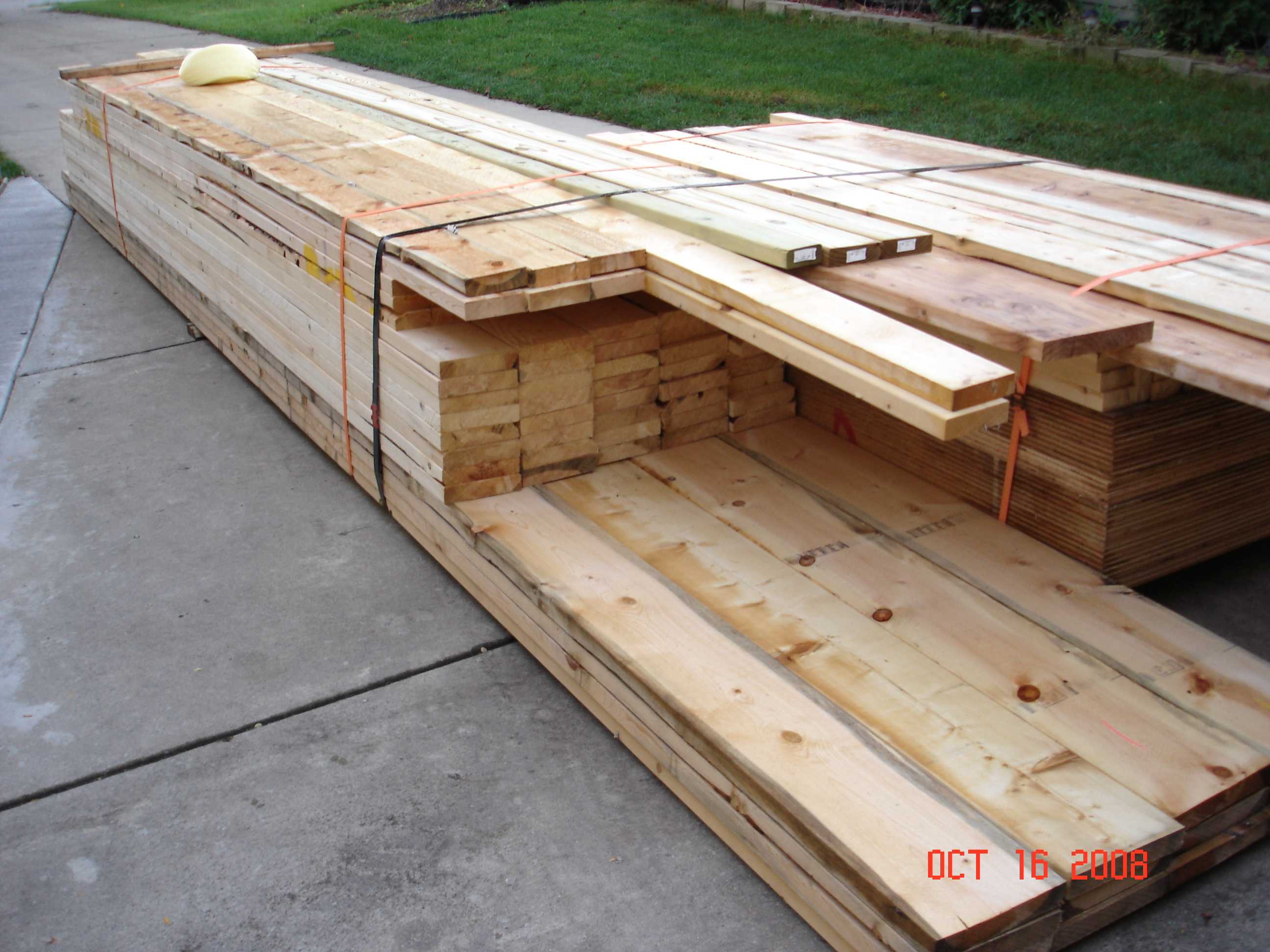

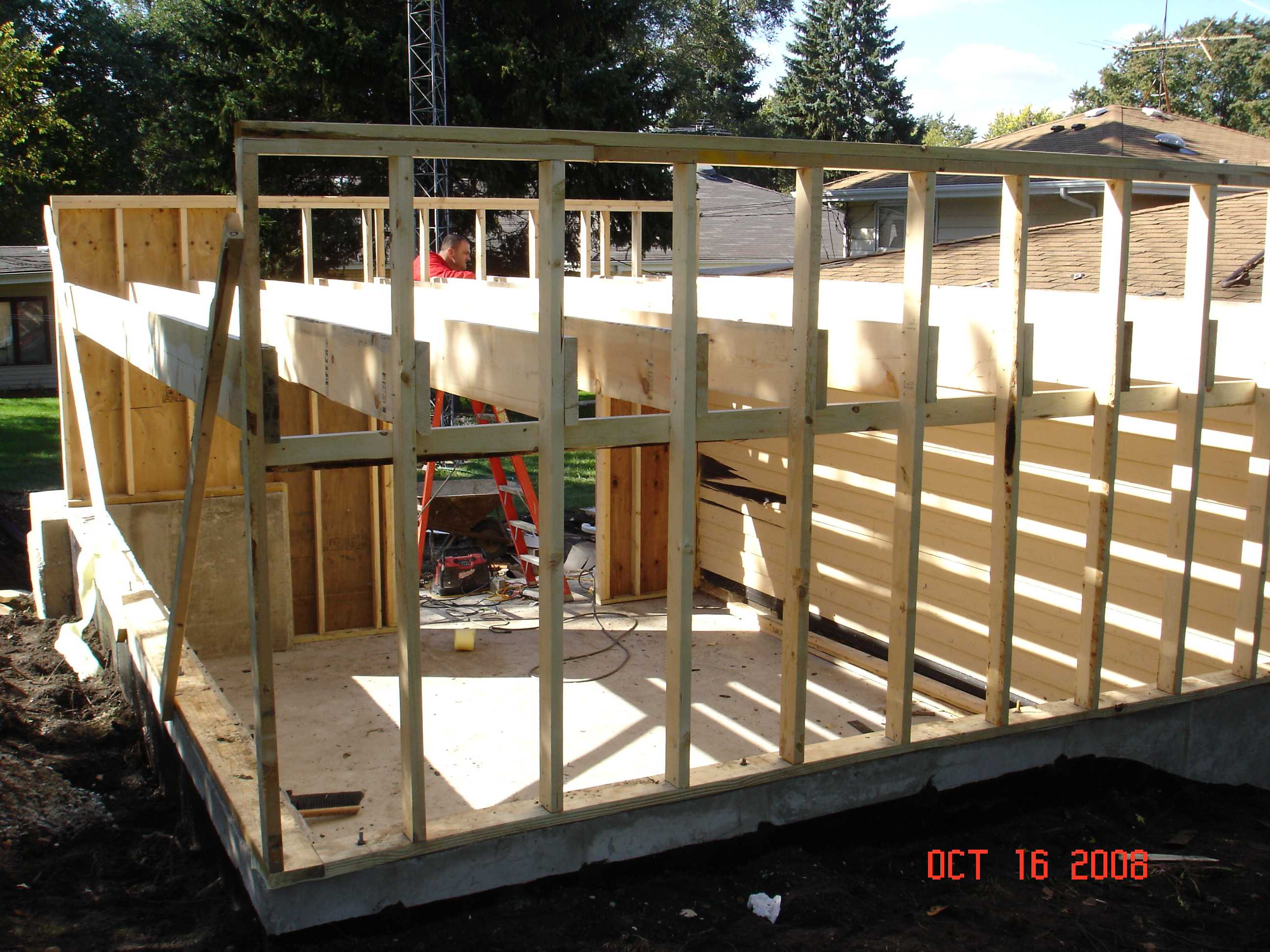

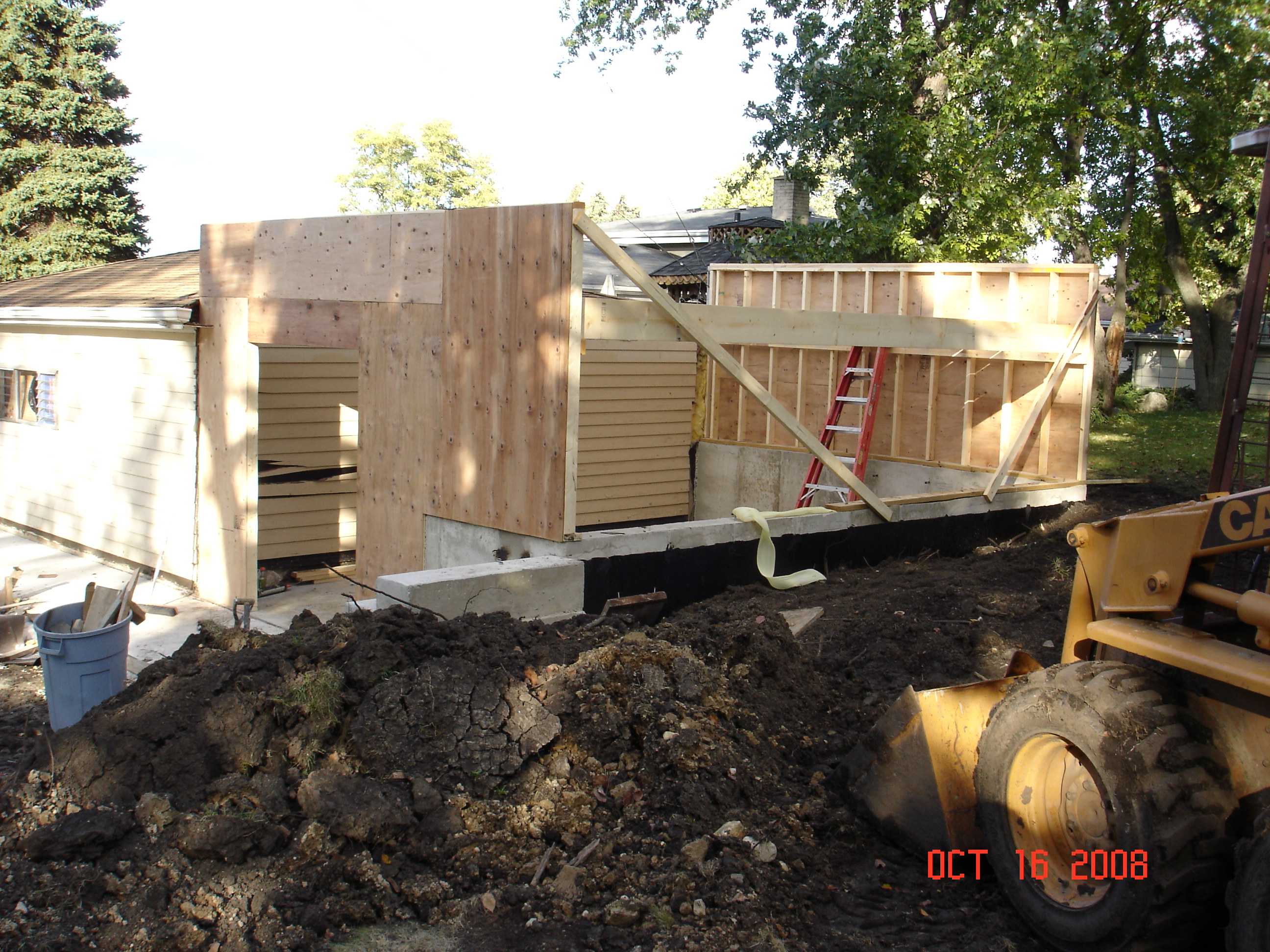

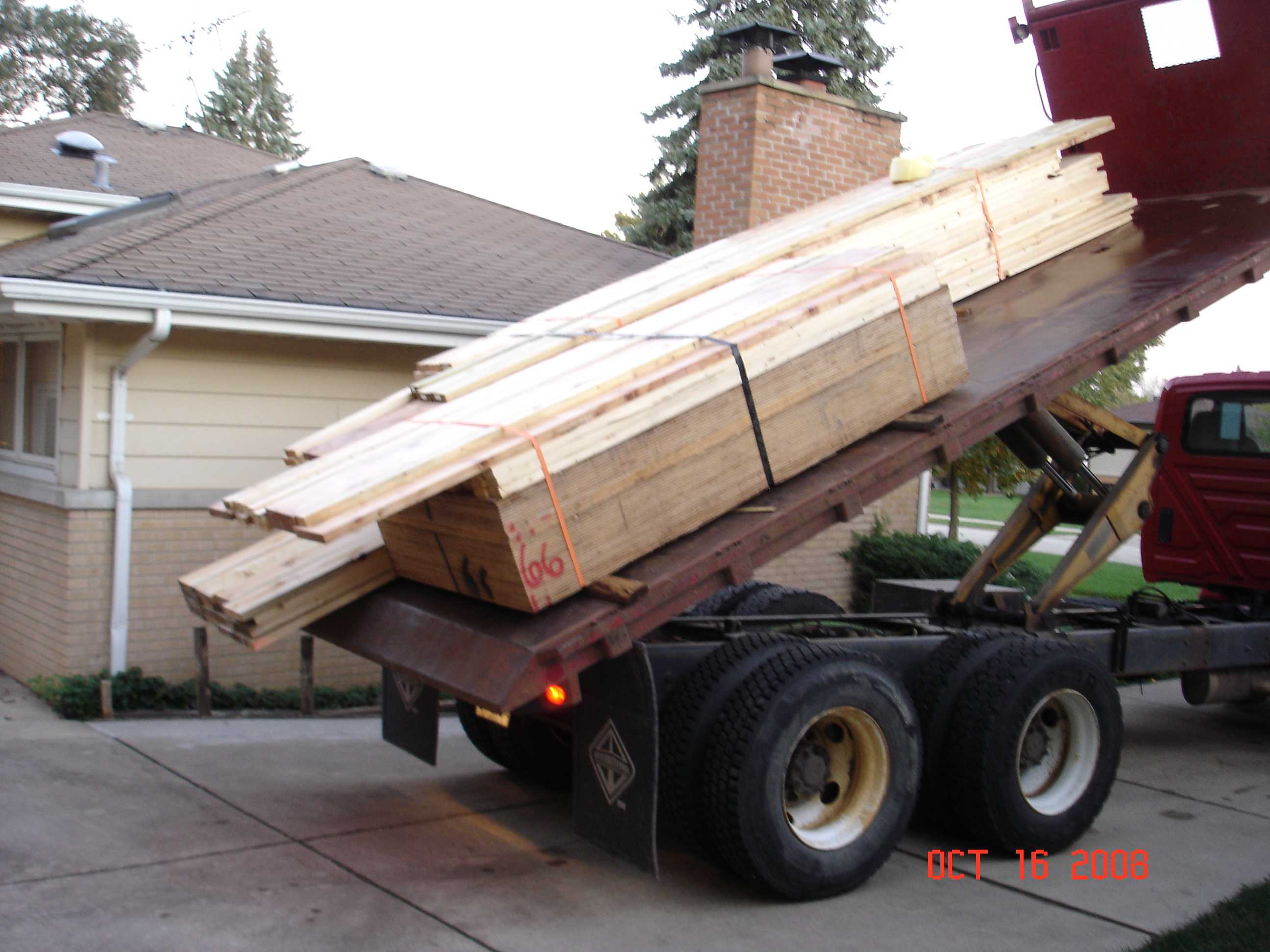

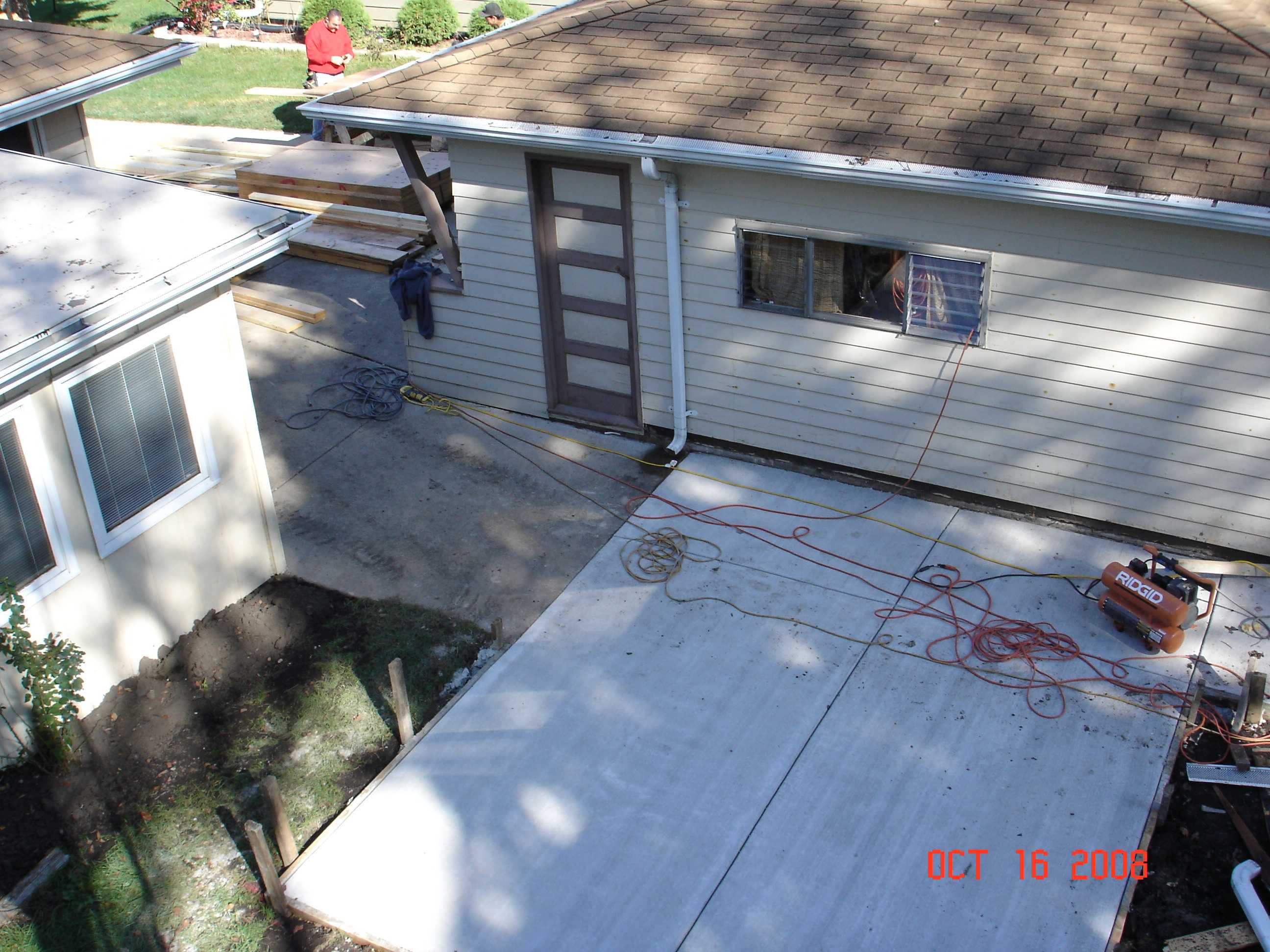

Day 8 (Thursday 16 Oct 08): Wood Delivered. Construction
begins. Stairway to nowhere.

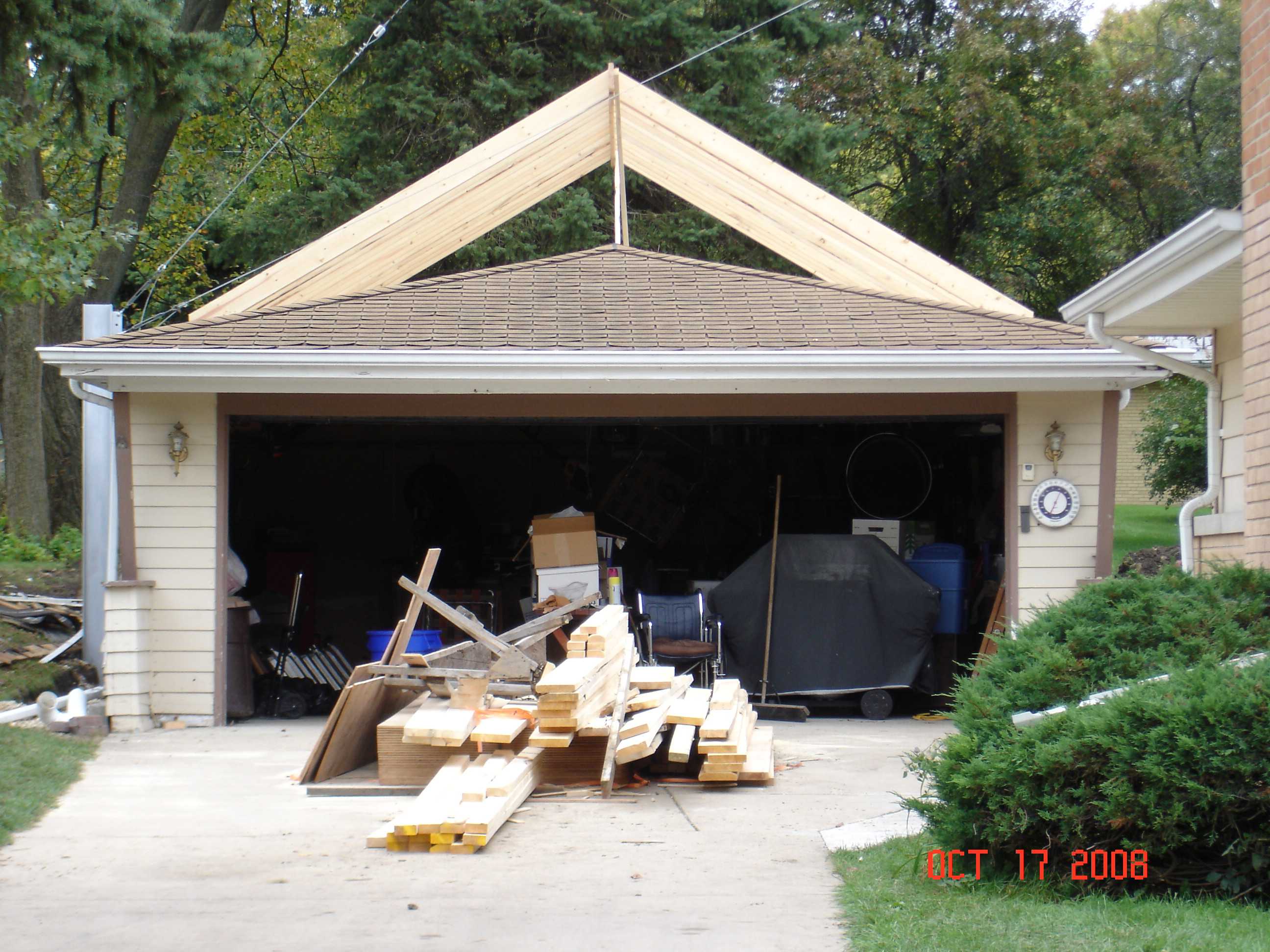

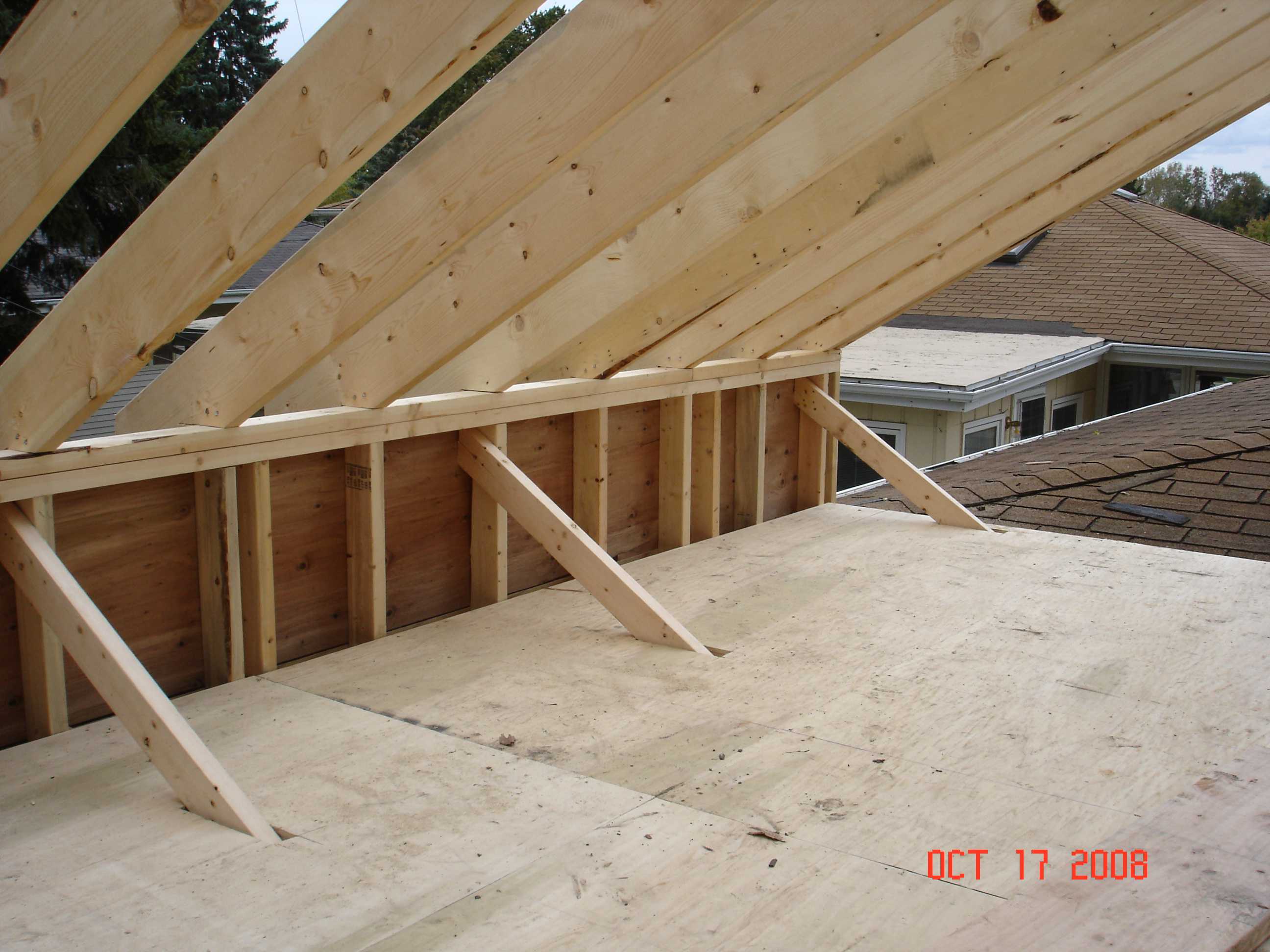

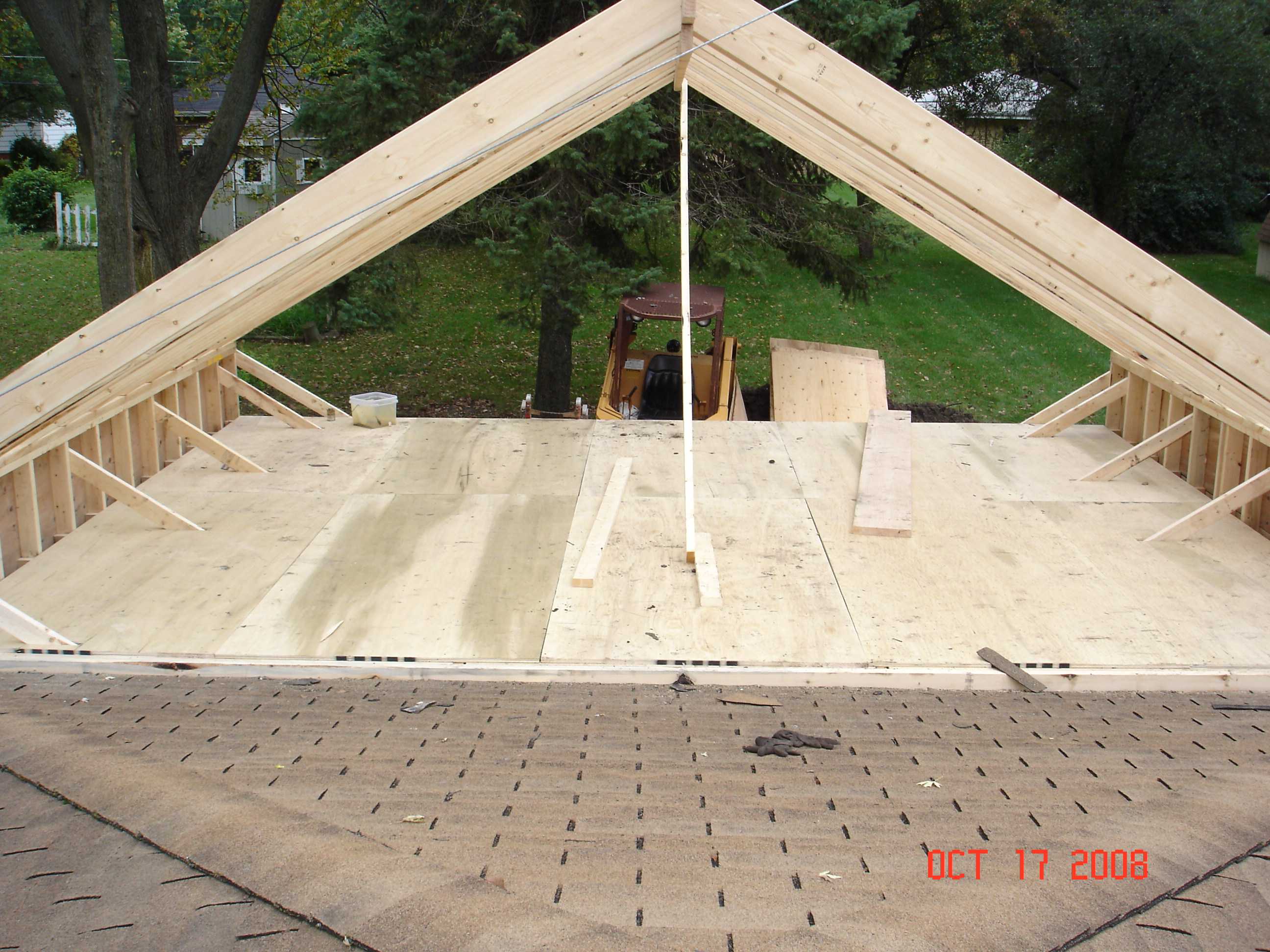

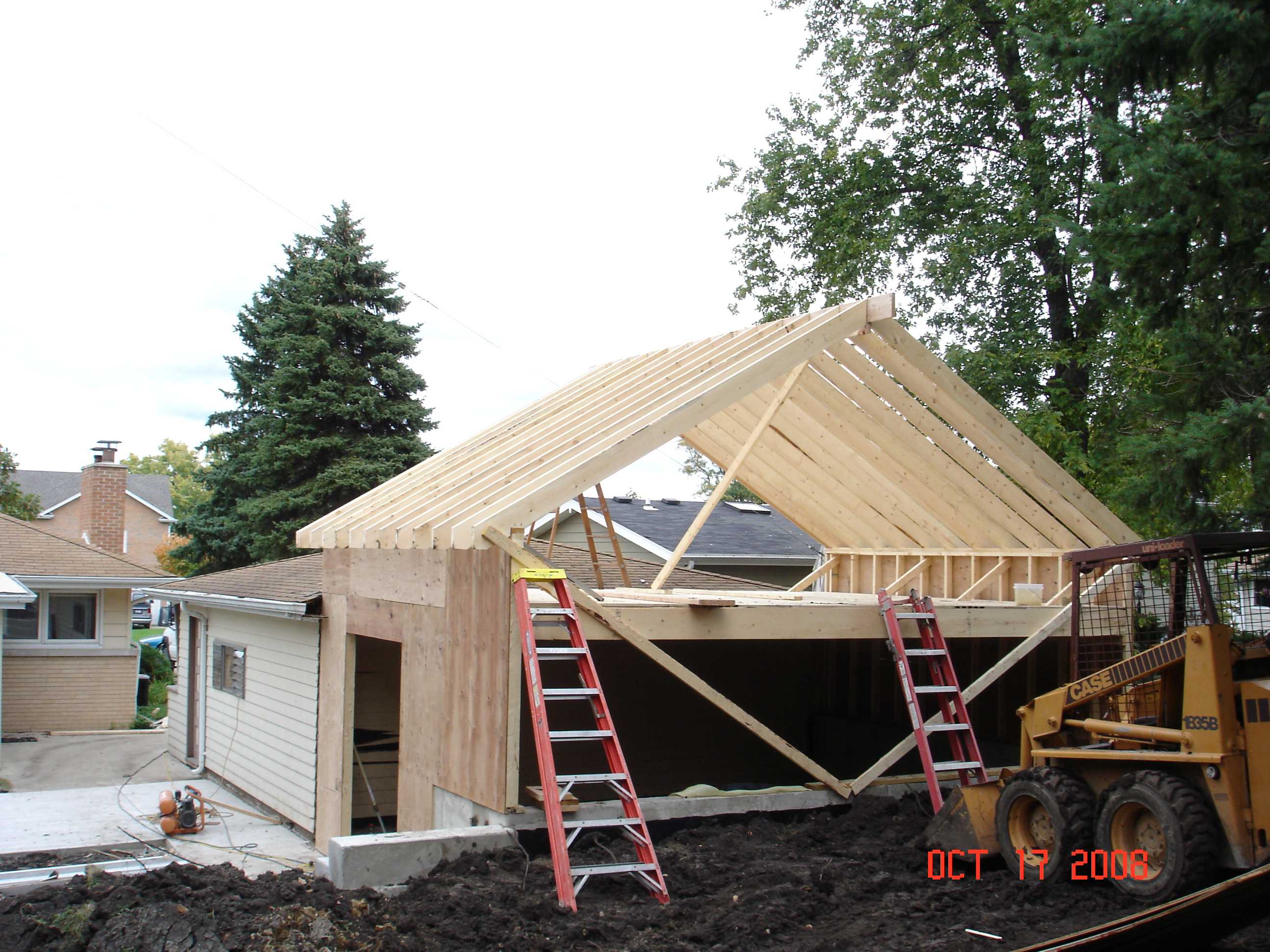

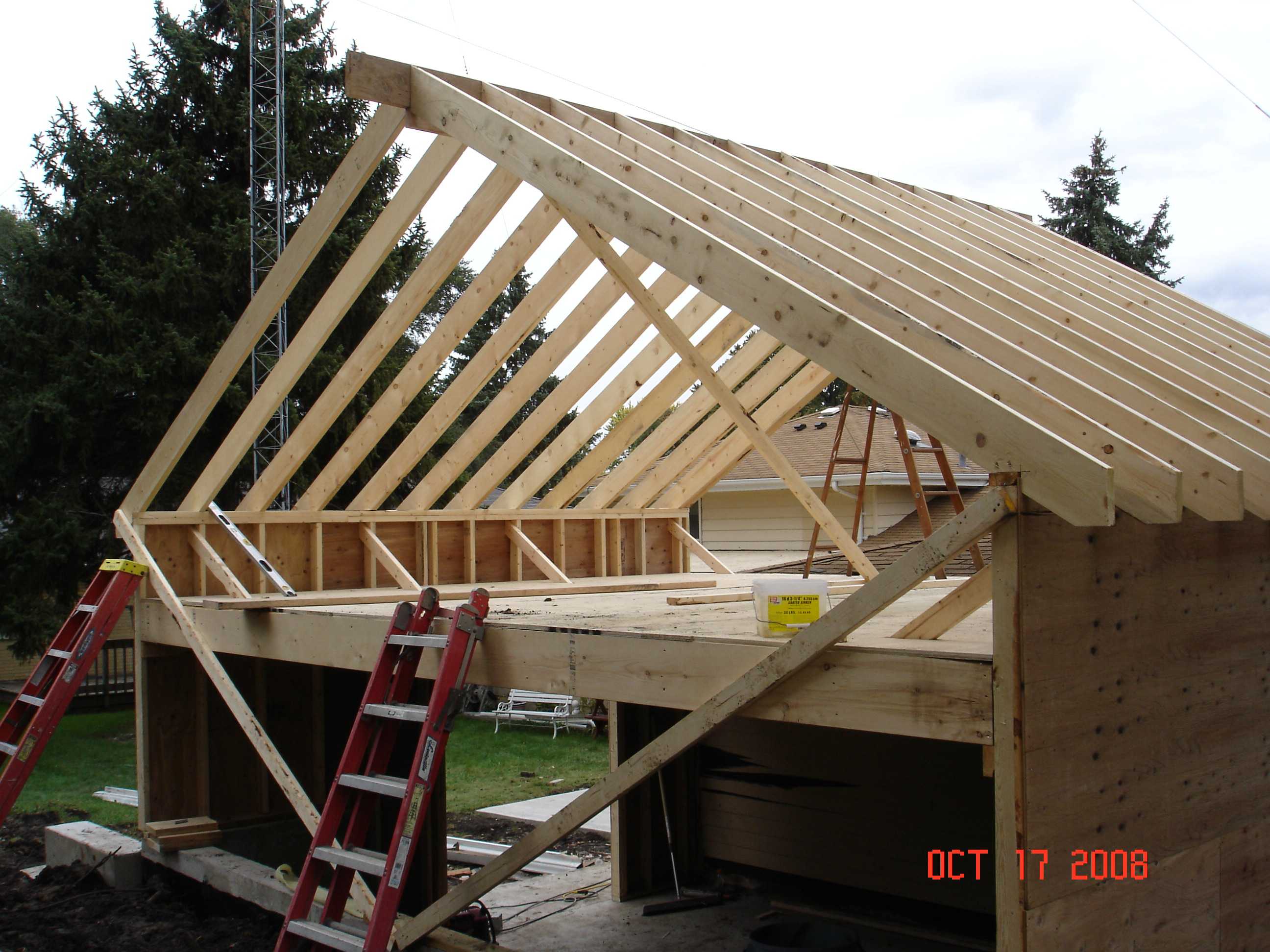

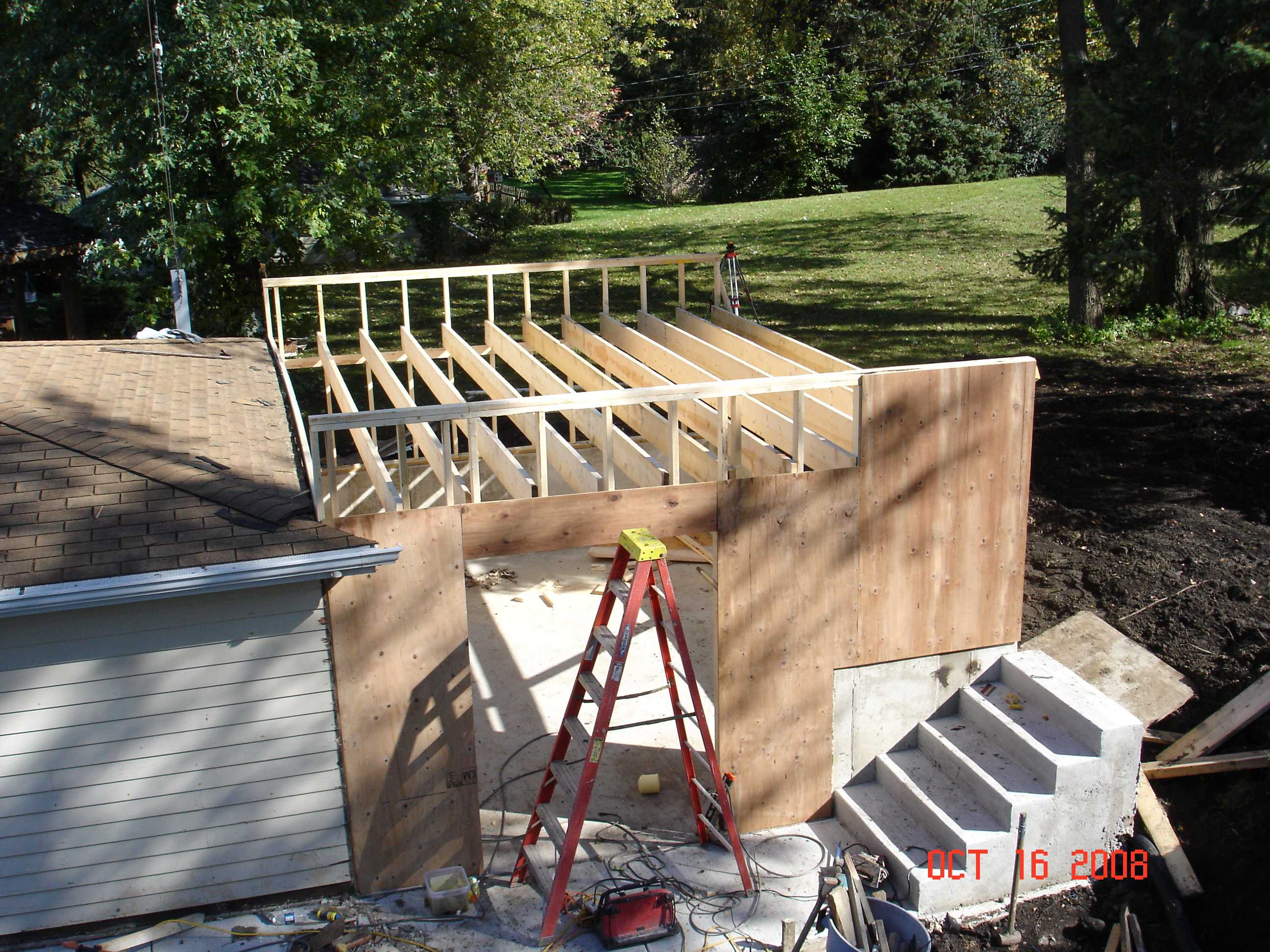

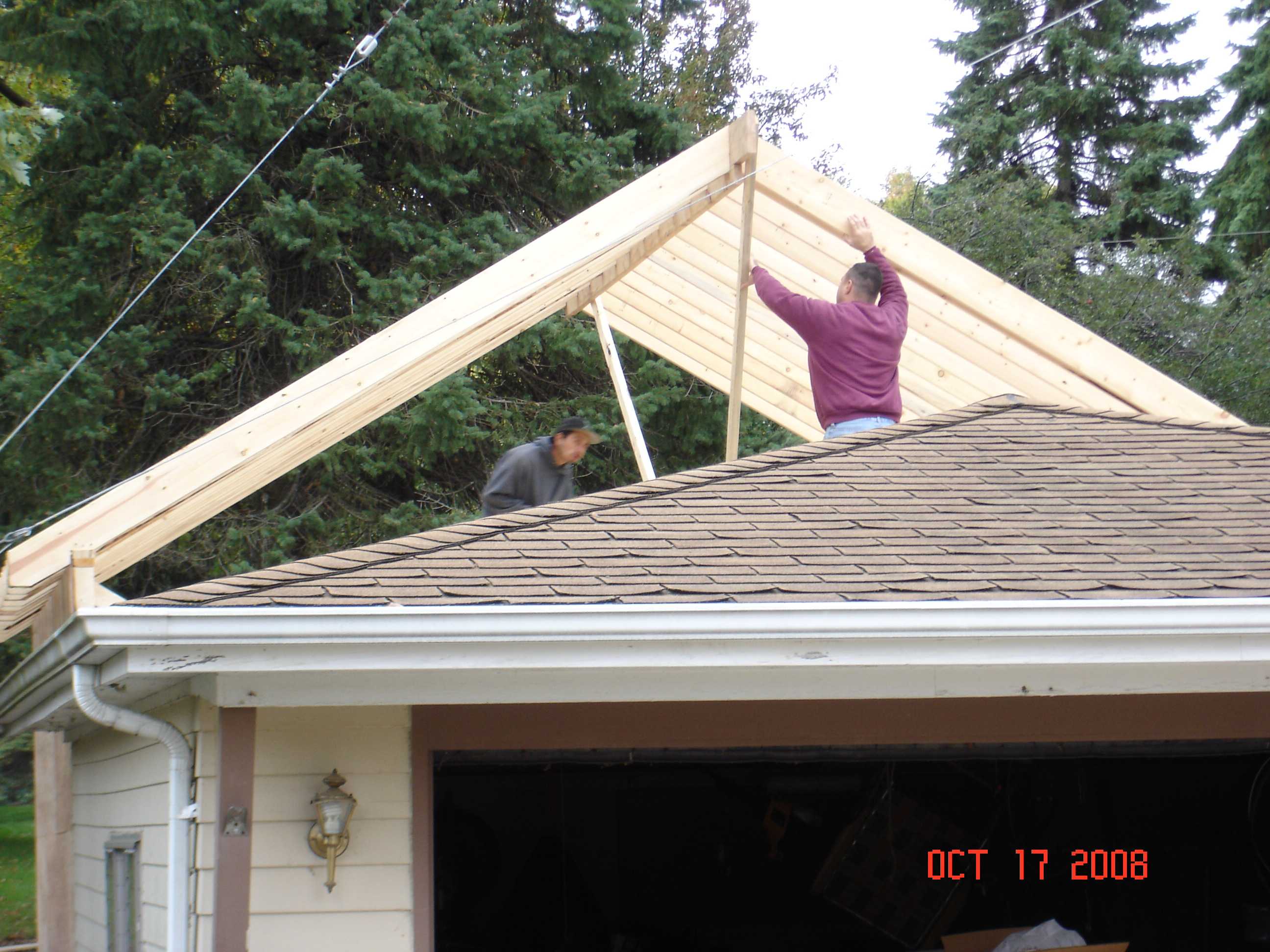

Day 9 (Friday 17 Oct 08): Construction continues - Attic floor and roof rafters added
Day 10 (Monday 20 Oct 08): Rain Day

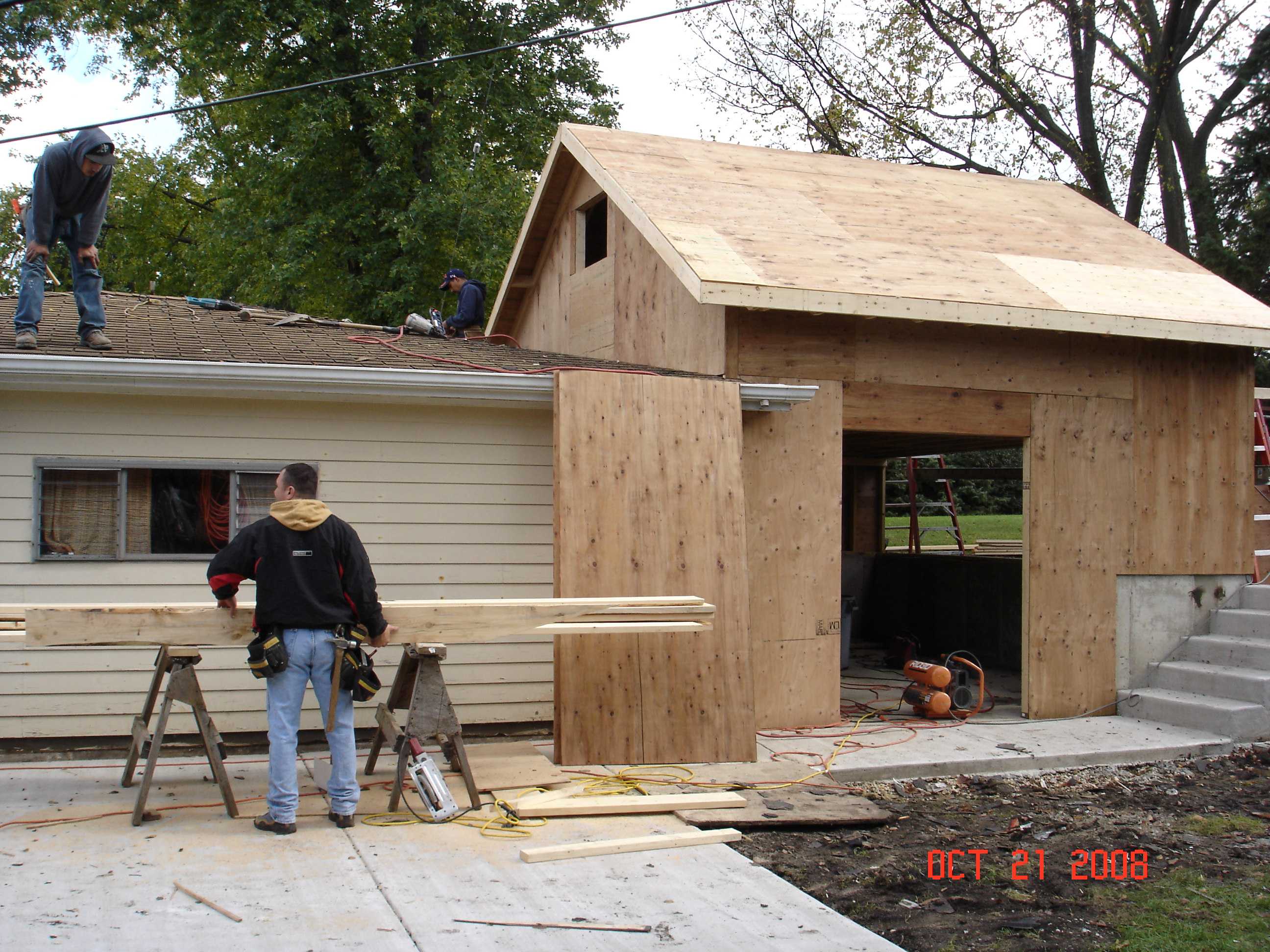

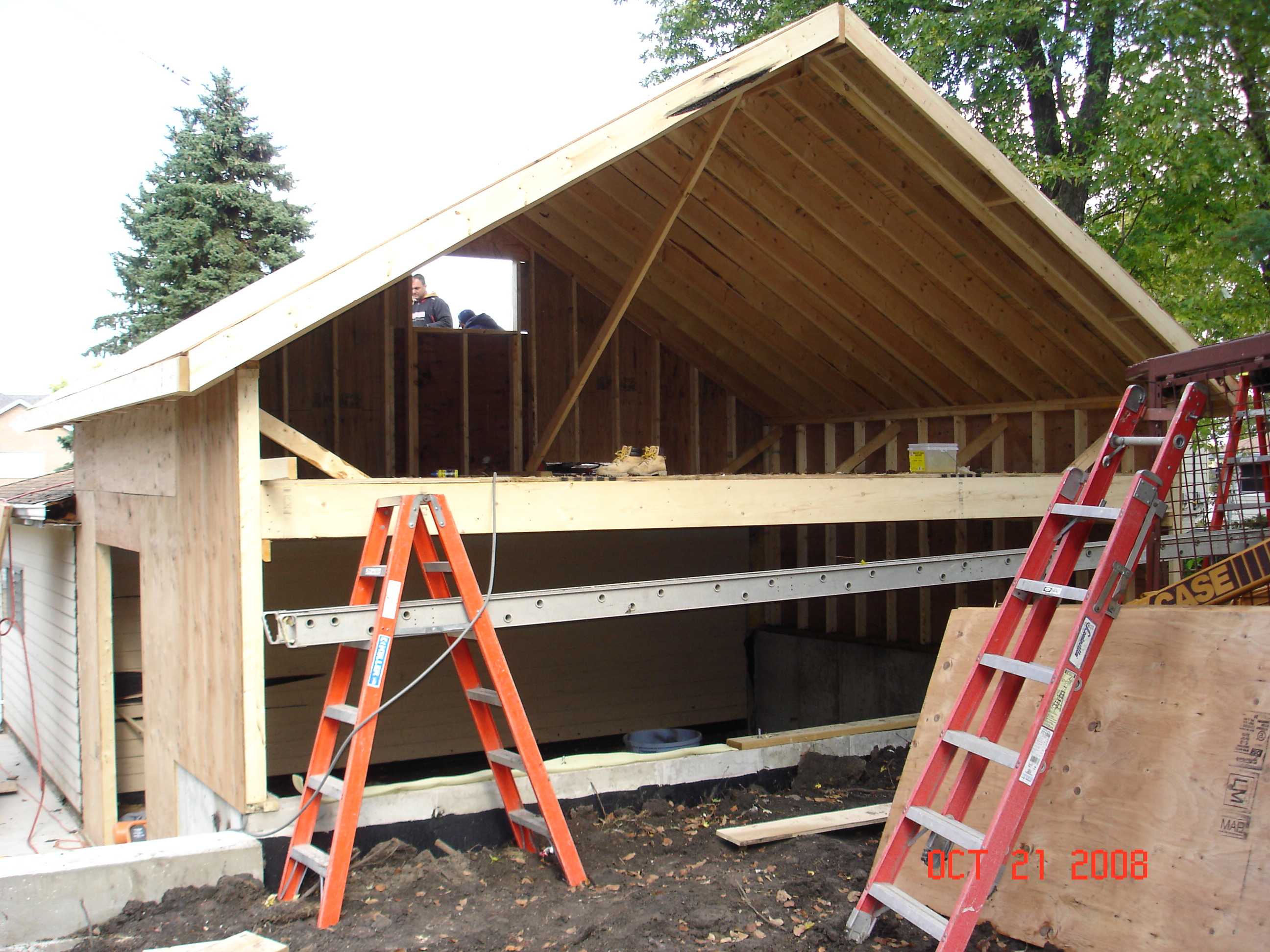

Day 11 (Tuesday 21 Oct 08): Roof plywood added, Attic front
framing completed and rear framing started

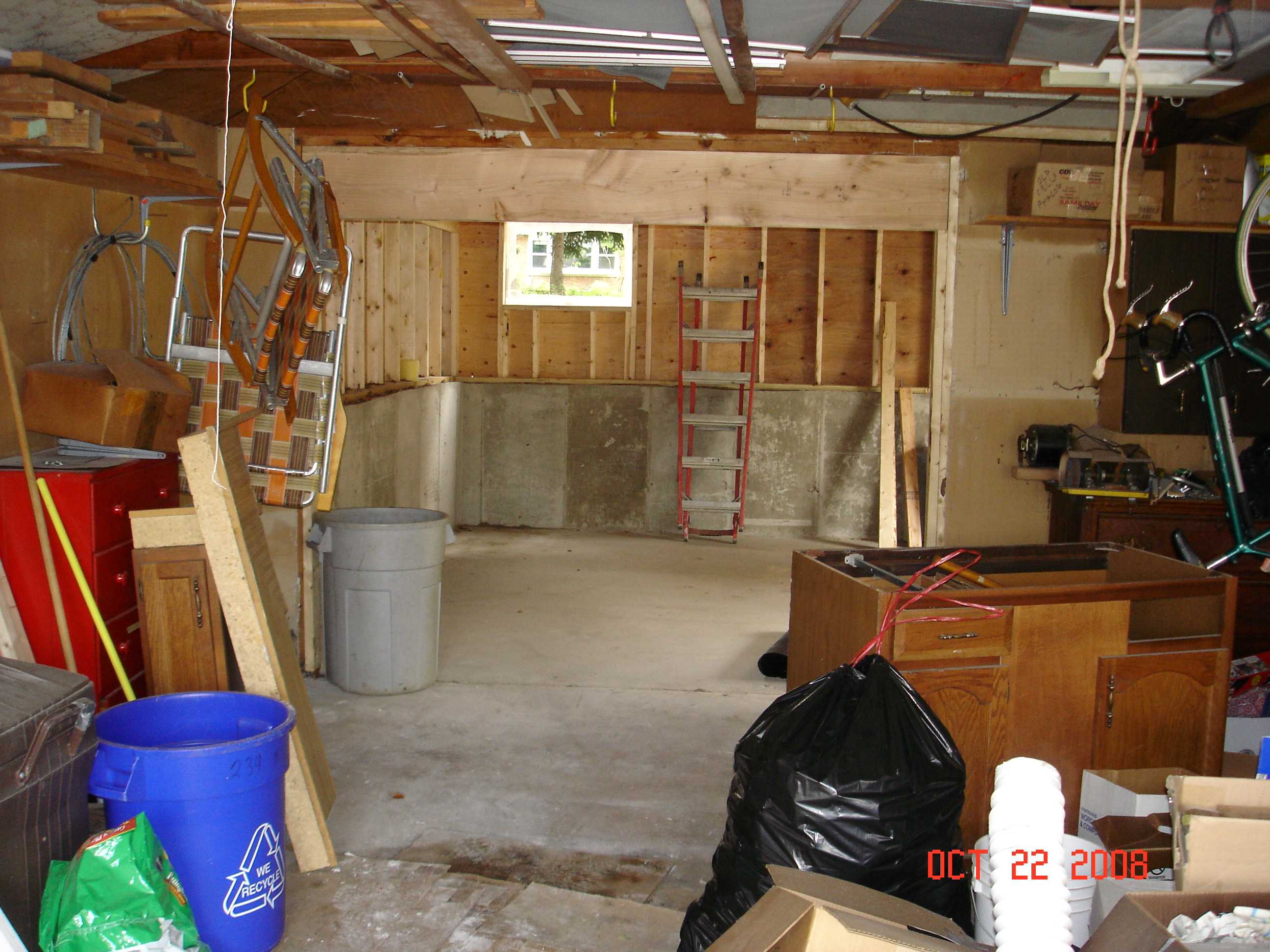

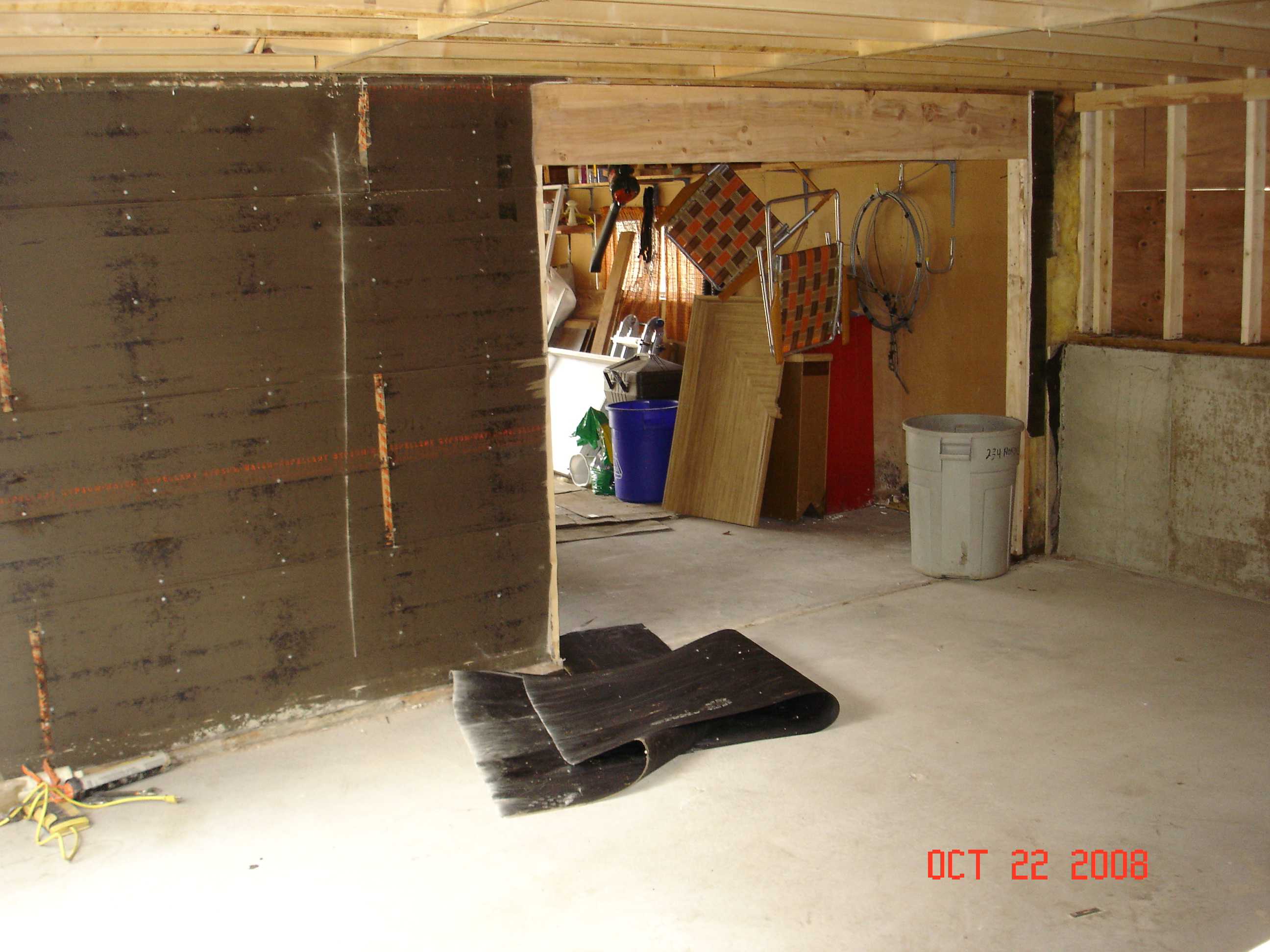

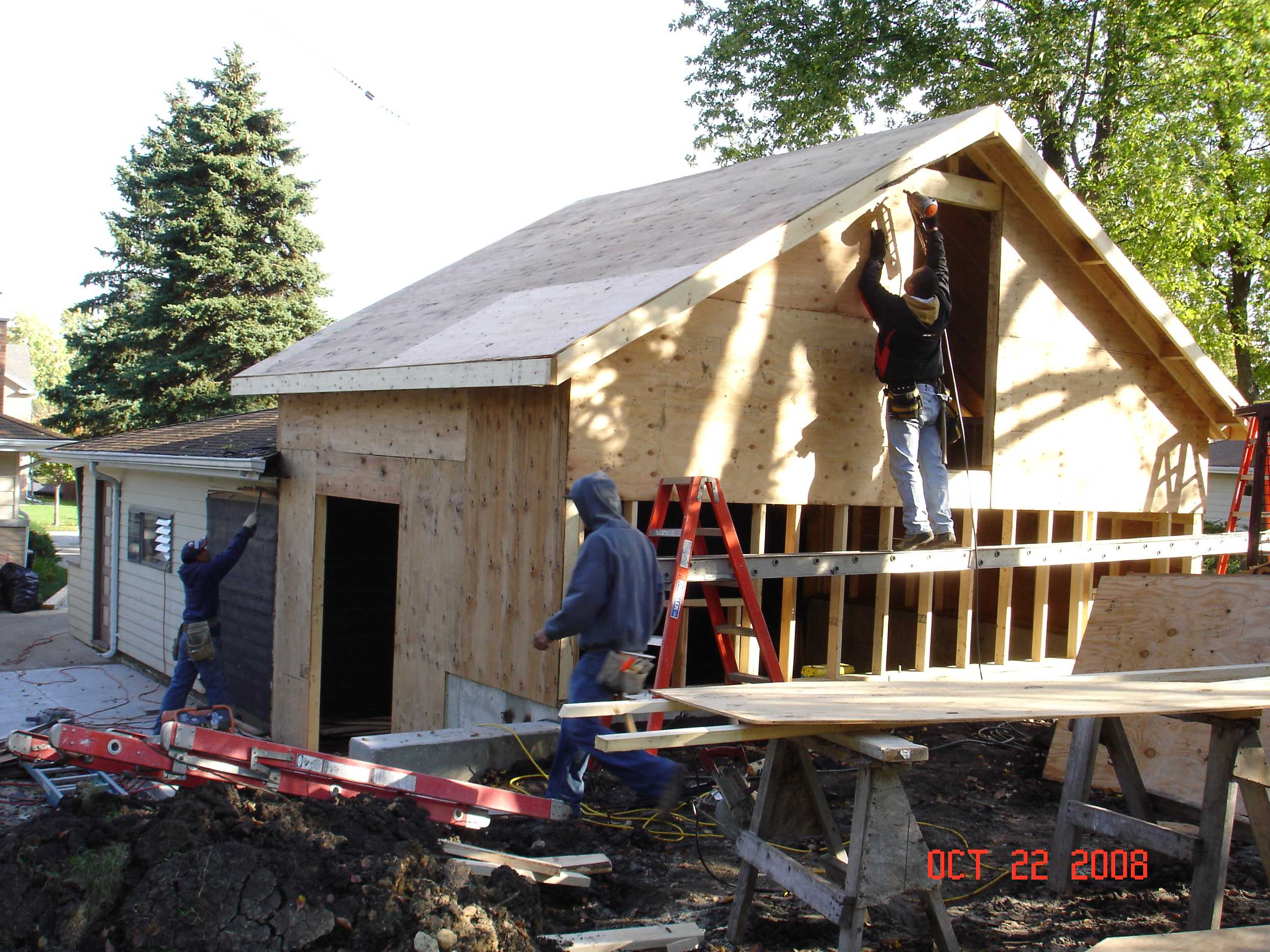

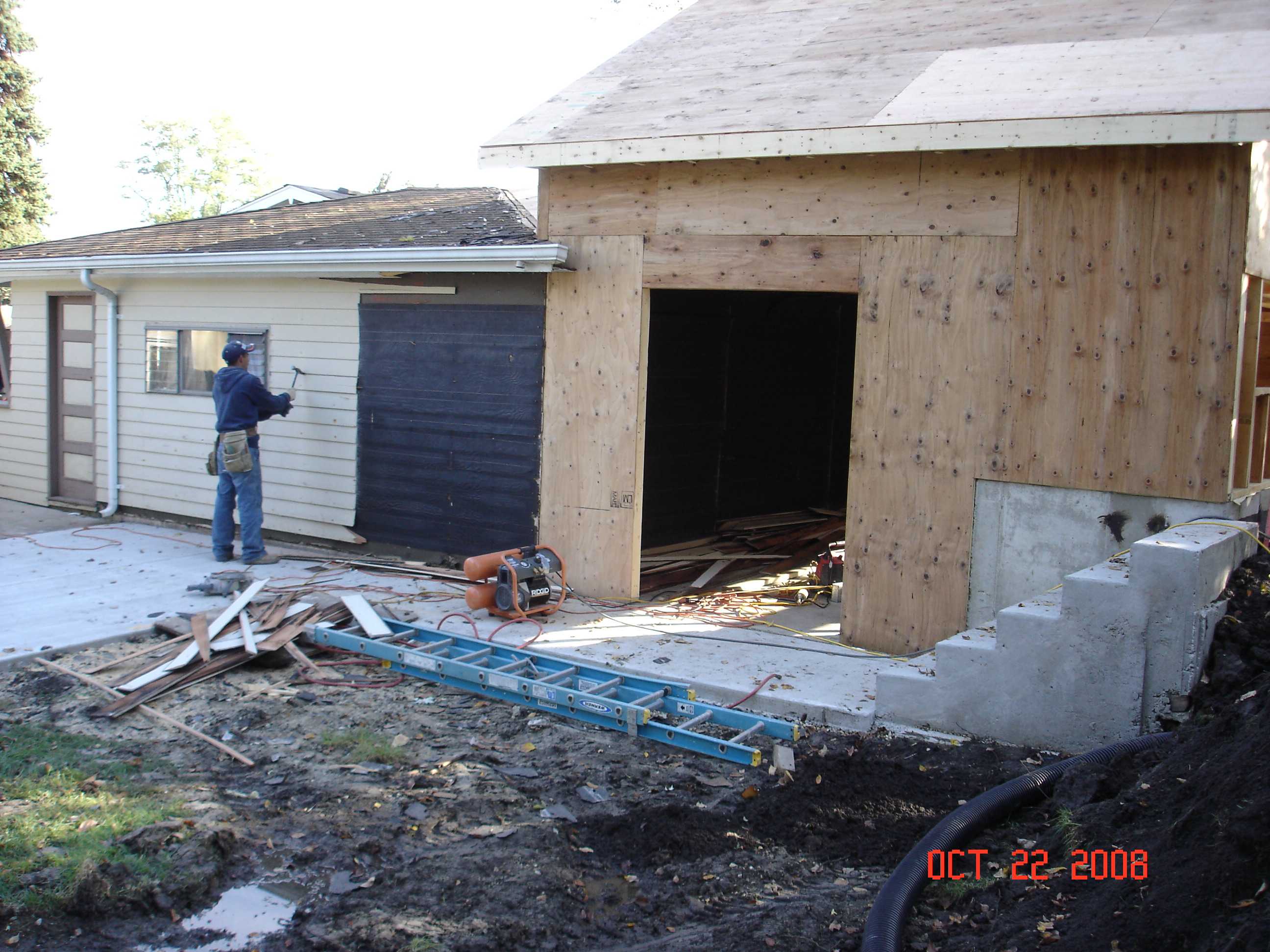

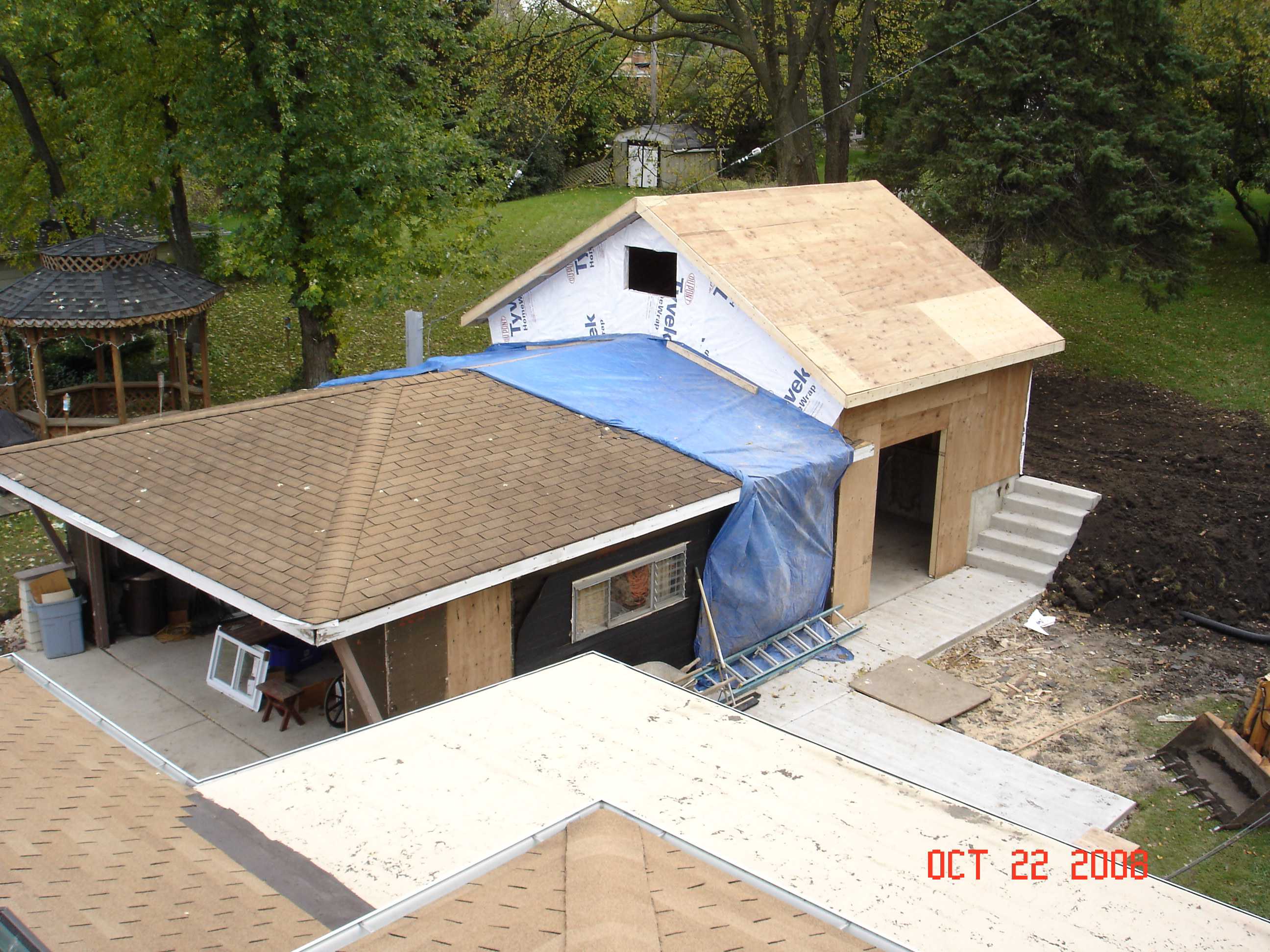

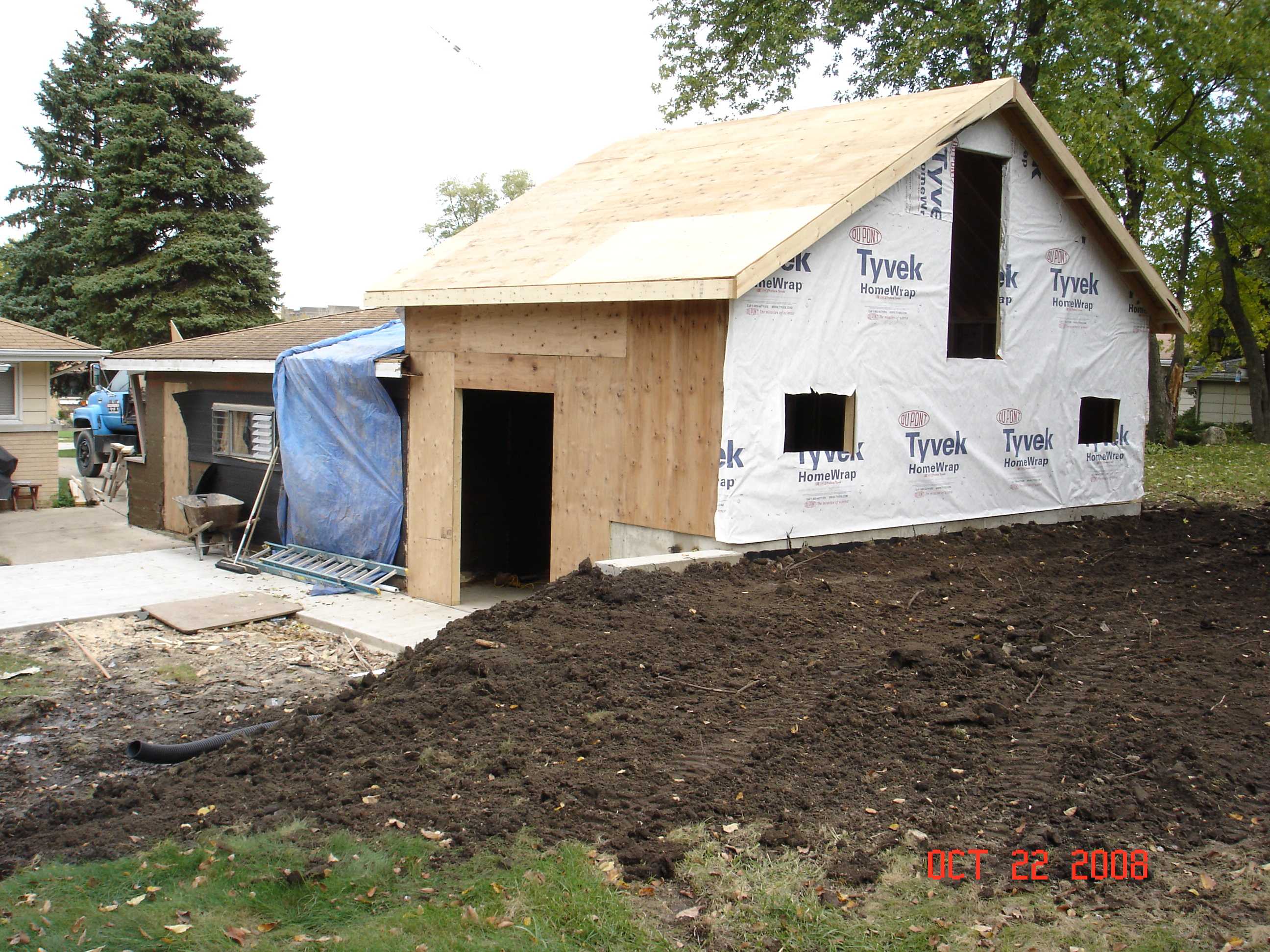

Day 12 (Wednesday 22 Oct 08): Finishing framing rear, removing
siding on original garage, opening between old and new garage, rear view, view
from roof of house.

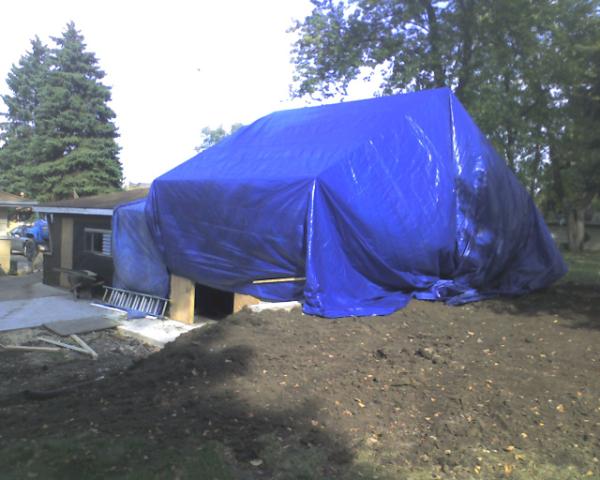

Day 13 (Thursday 23 Oct 08): Waiting for Windows, Doors, and Rain (for next 3 days). "Now that's a Tarp" ... J. Bassett
Day 14 (Friday 24 Oct 08): Rain Day

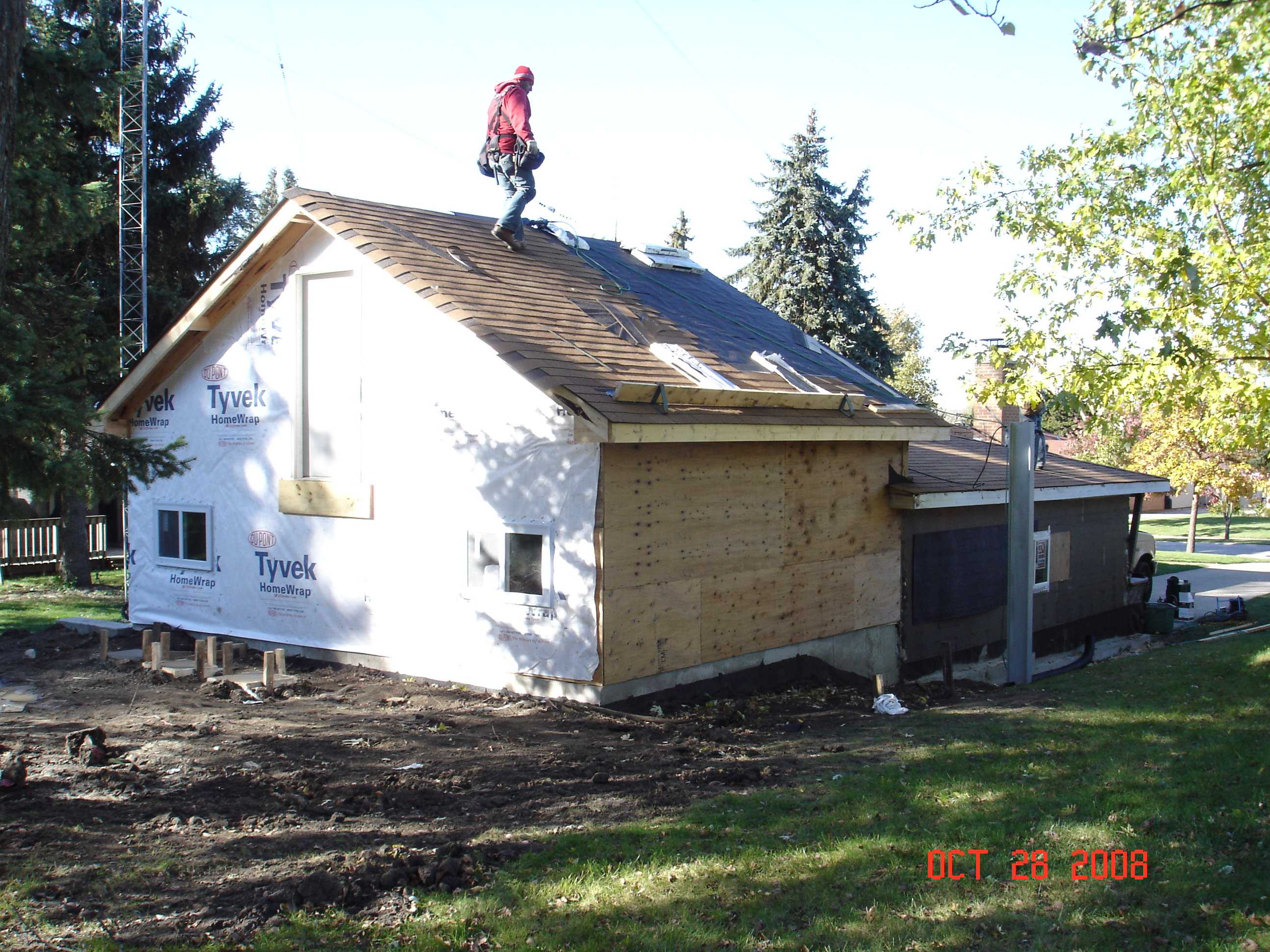

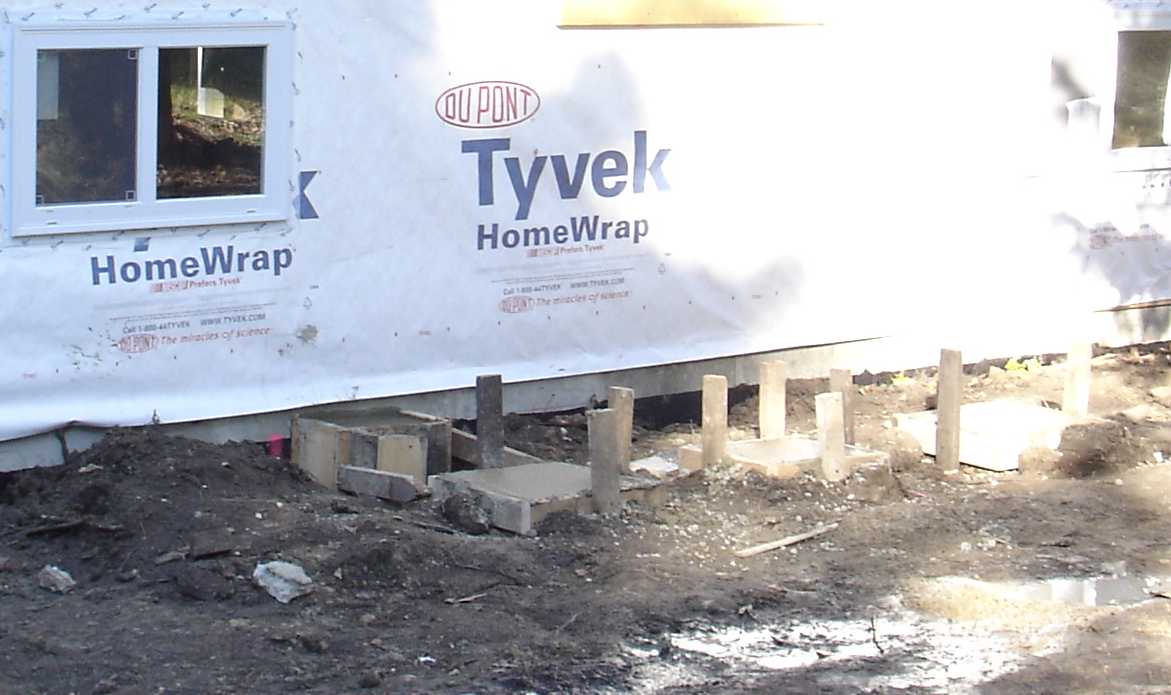

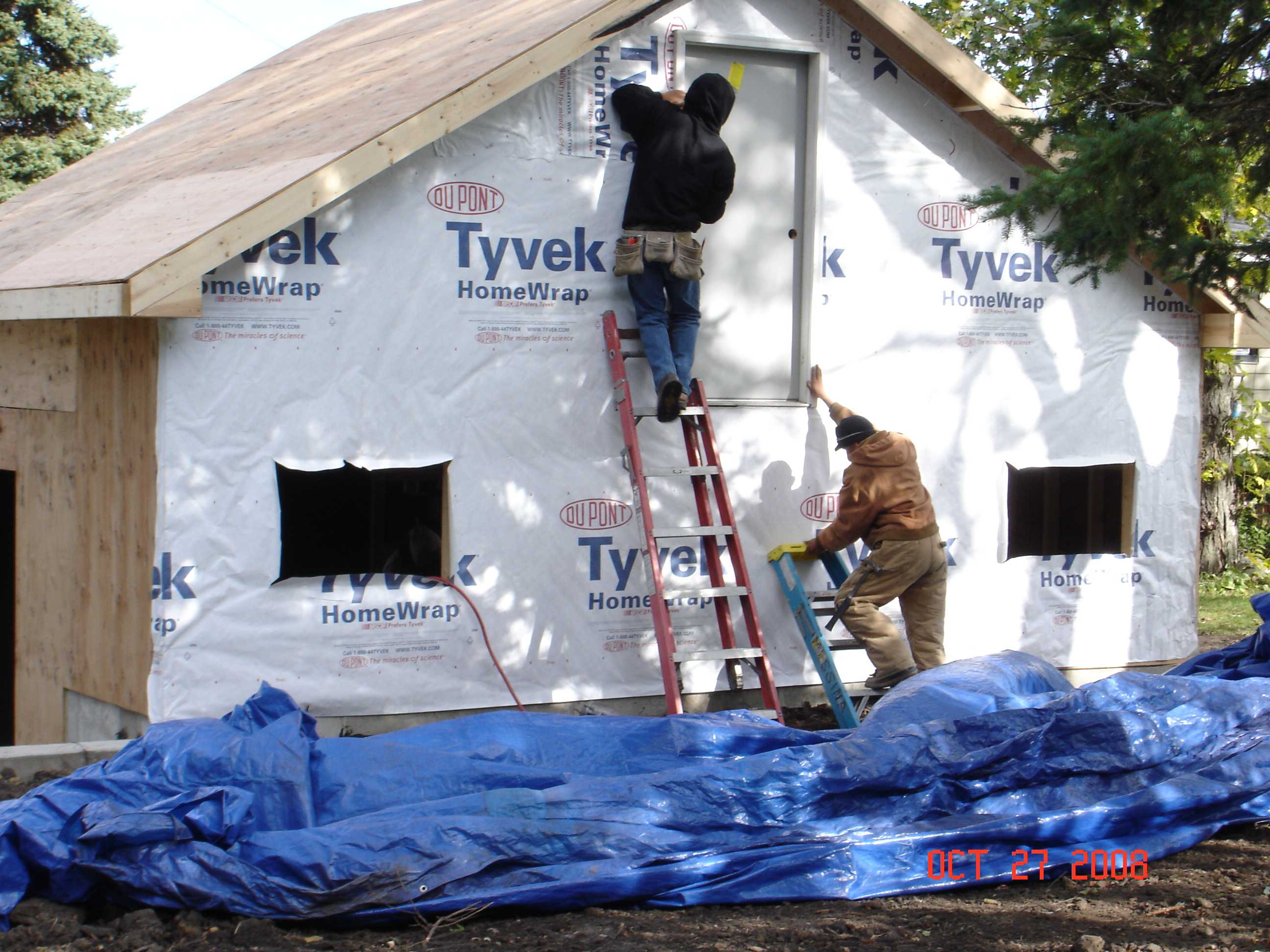

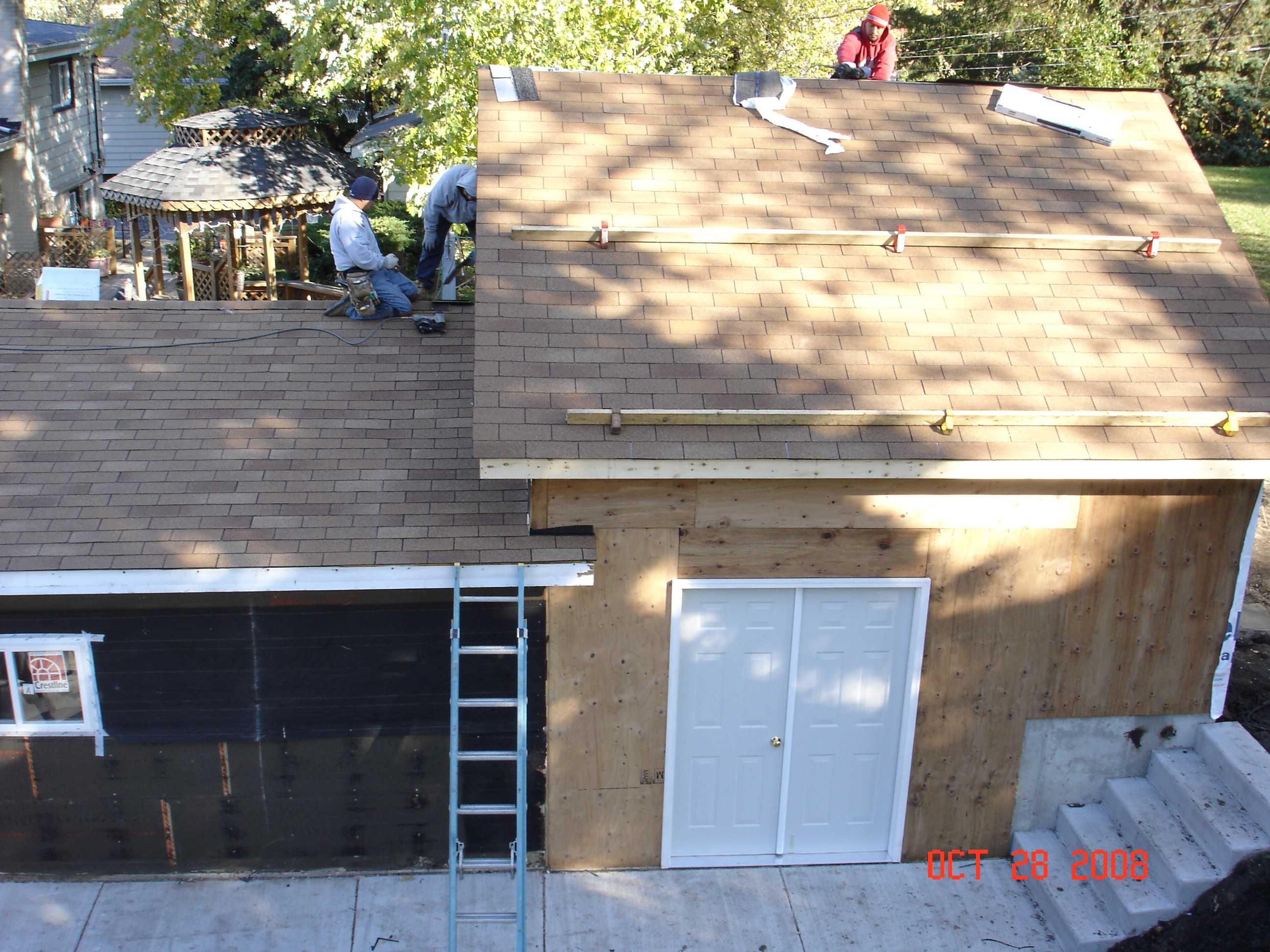

Day 15 & 16 (Monday & Tuesday 28 Oct 08): Windows and

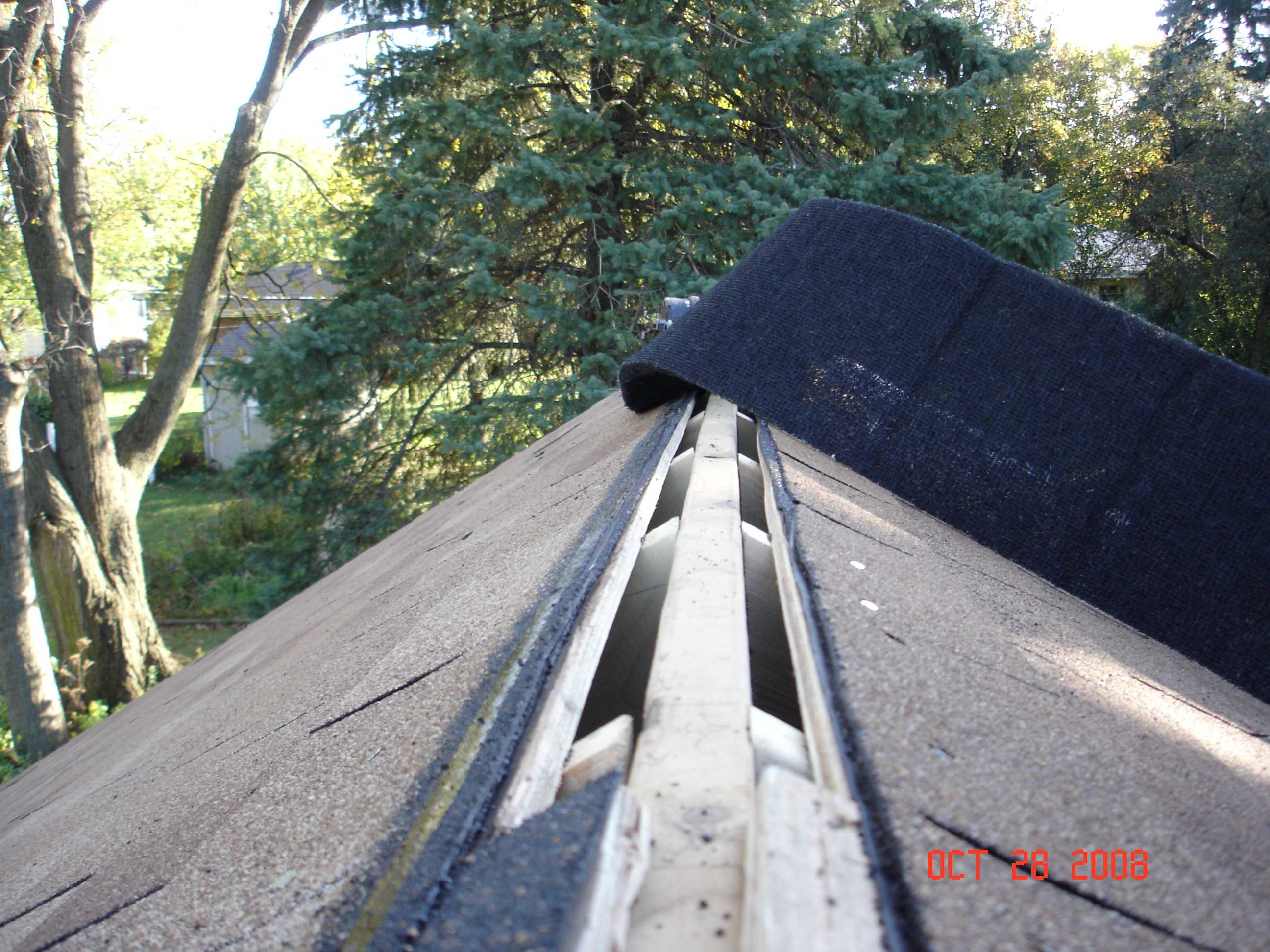

Doors installed. New Shingles and Ridge Vent completed. Rear stairs
started.
Oct 29 - Nov 2: No Work

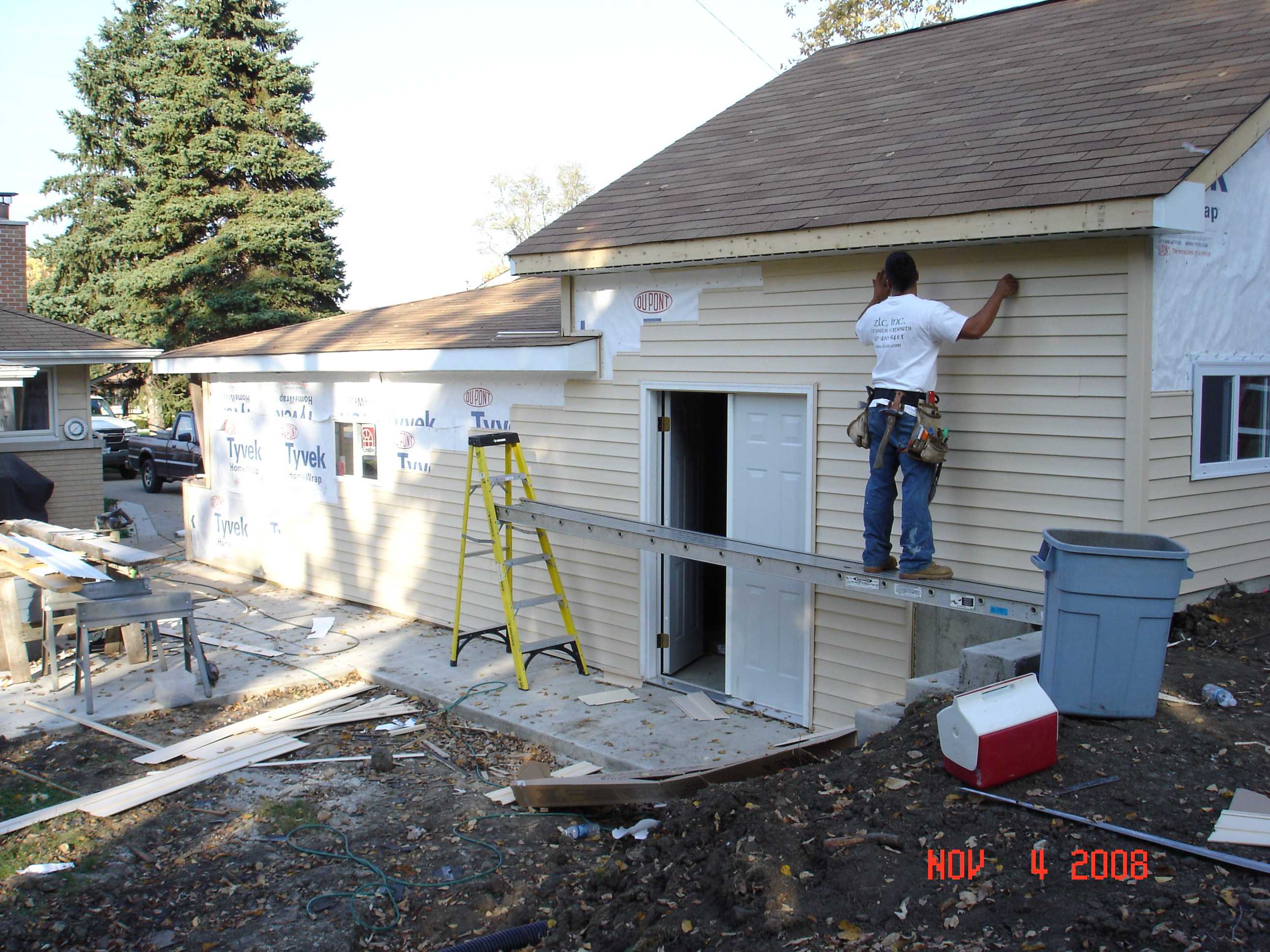

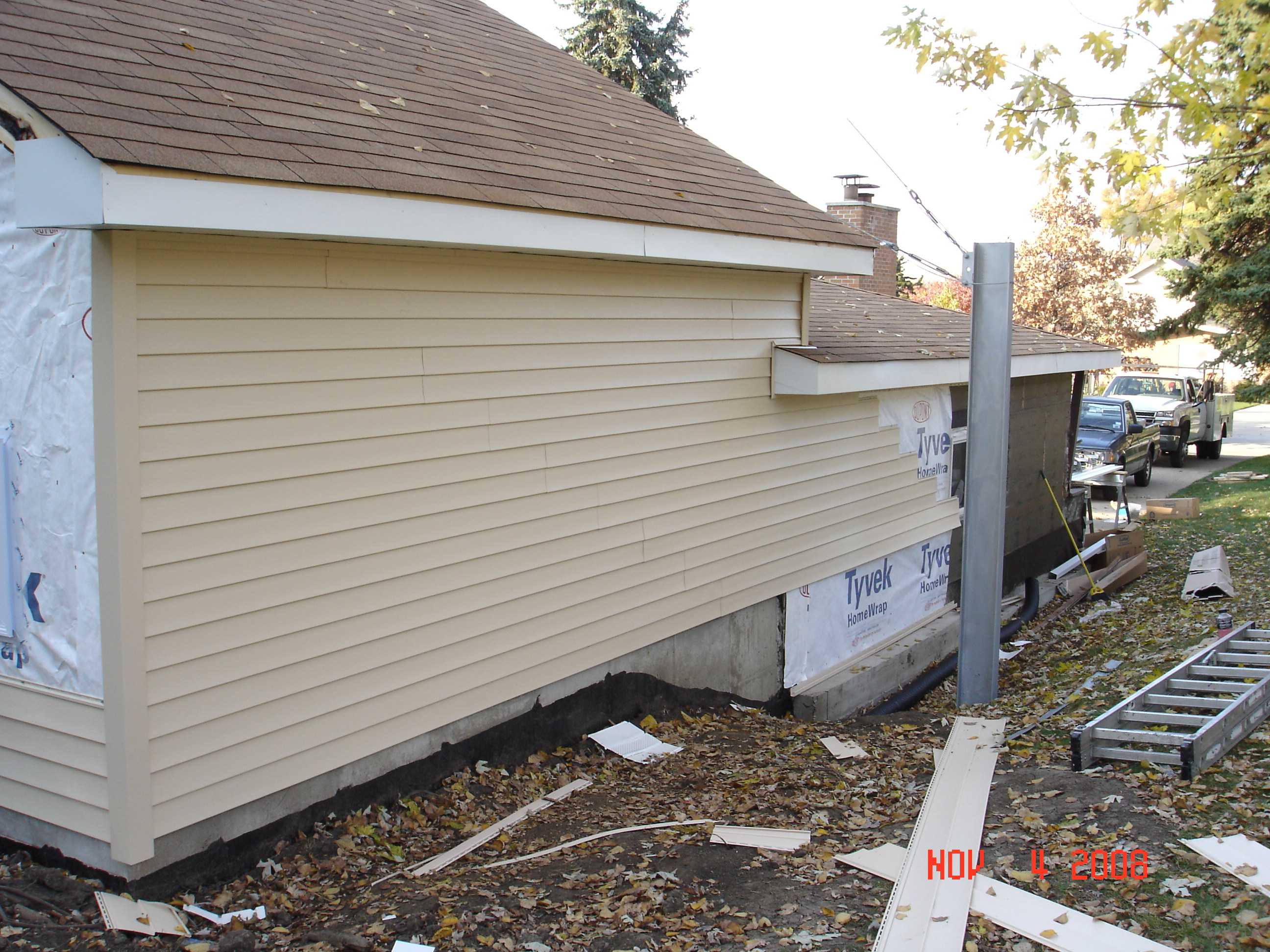

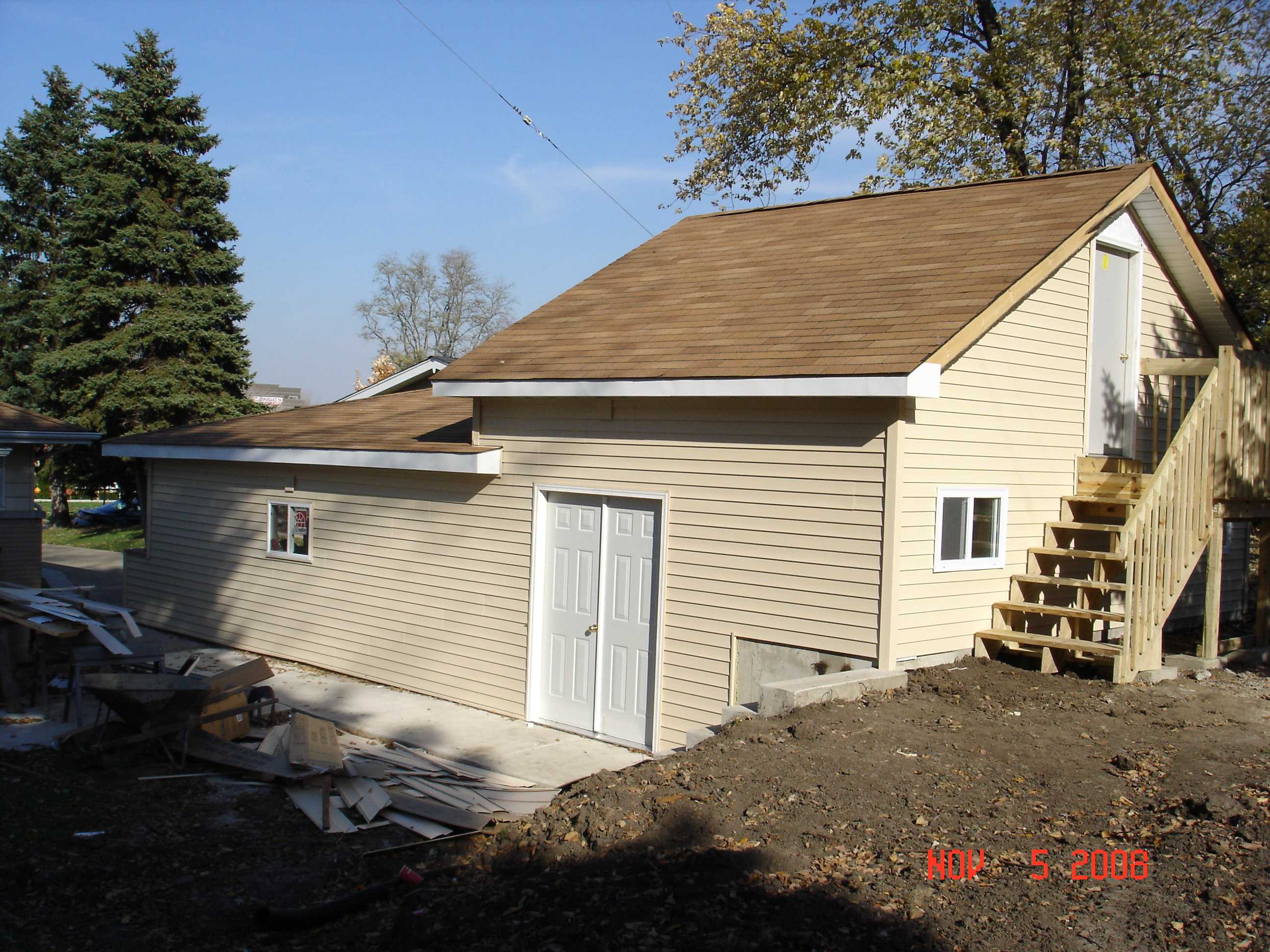

Days 17-19 (Monday - Wednesday 3-5 Nov 08): Siding, Soffits

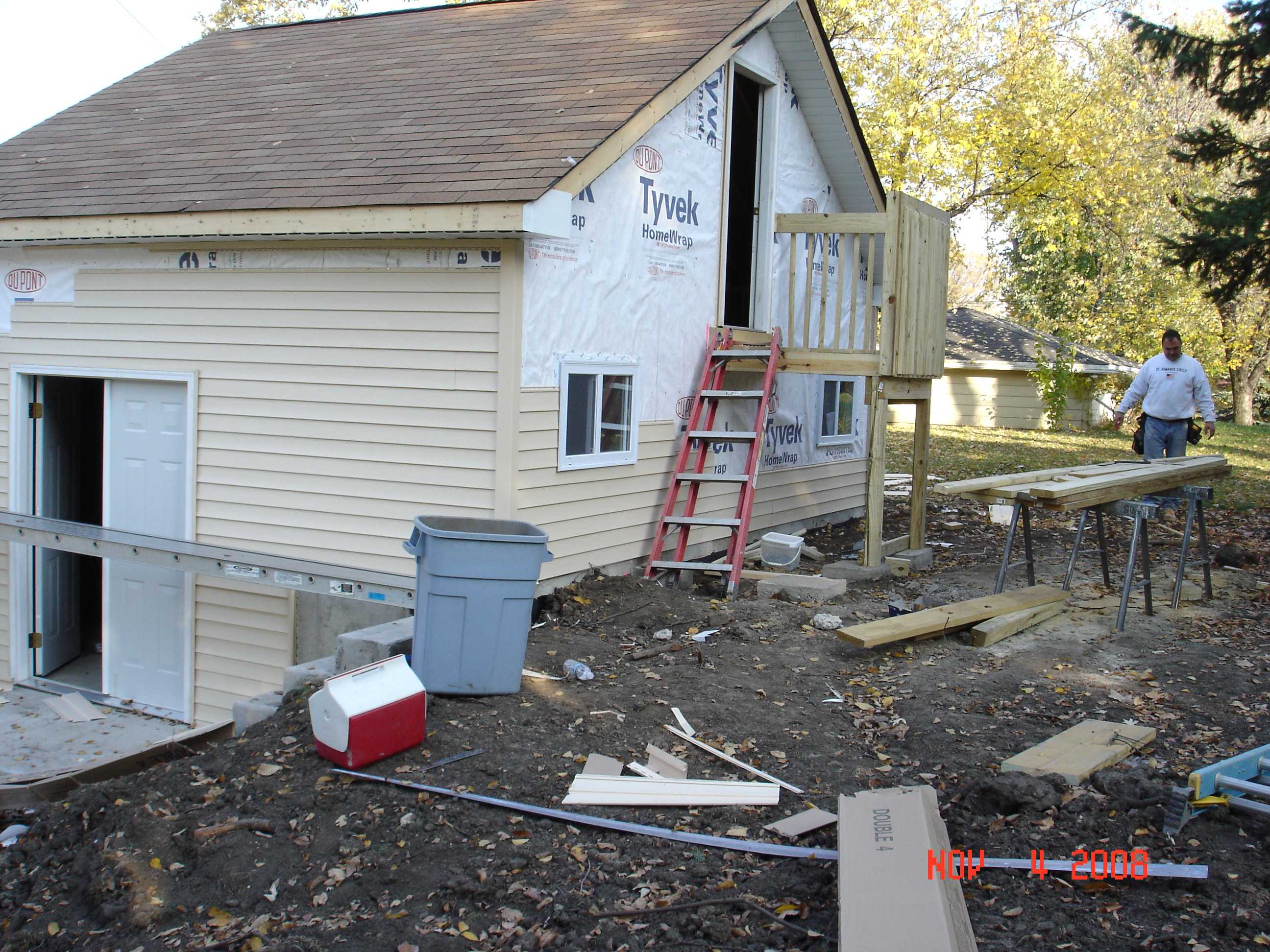

& Fascia almost complete.

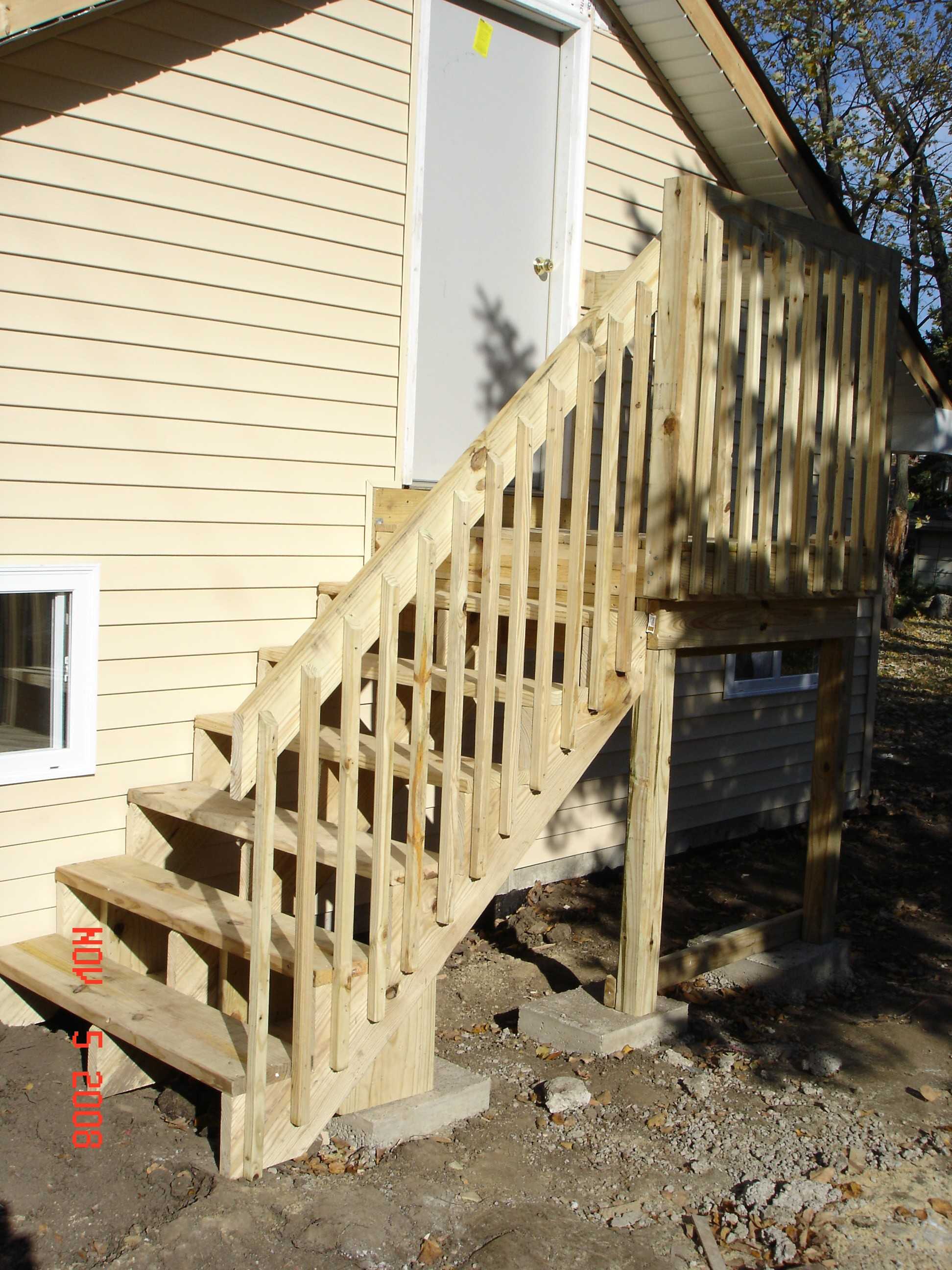

Rear Stairs completed.

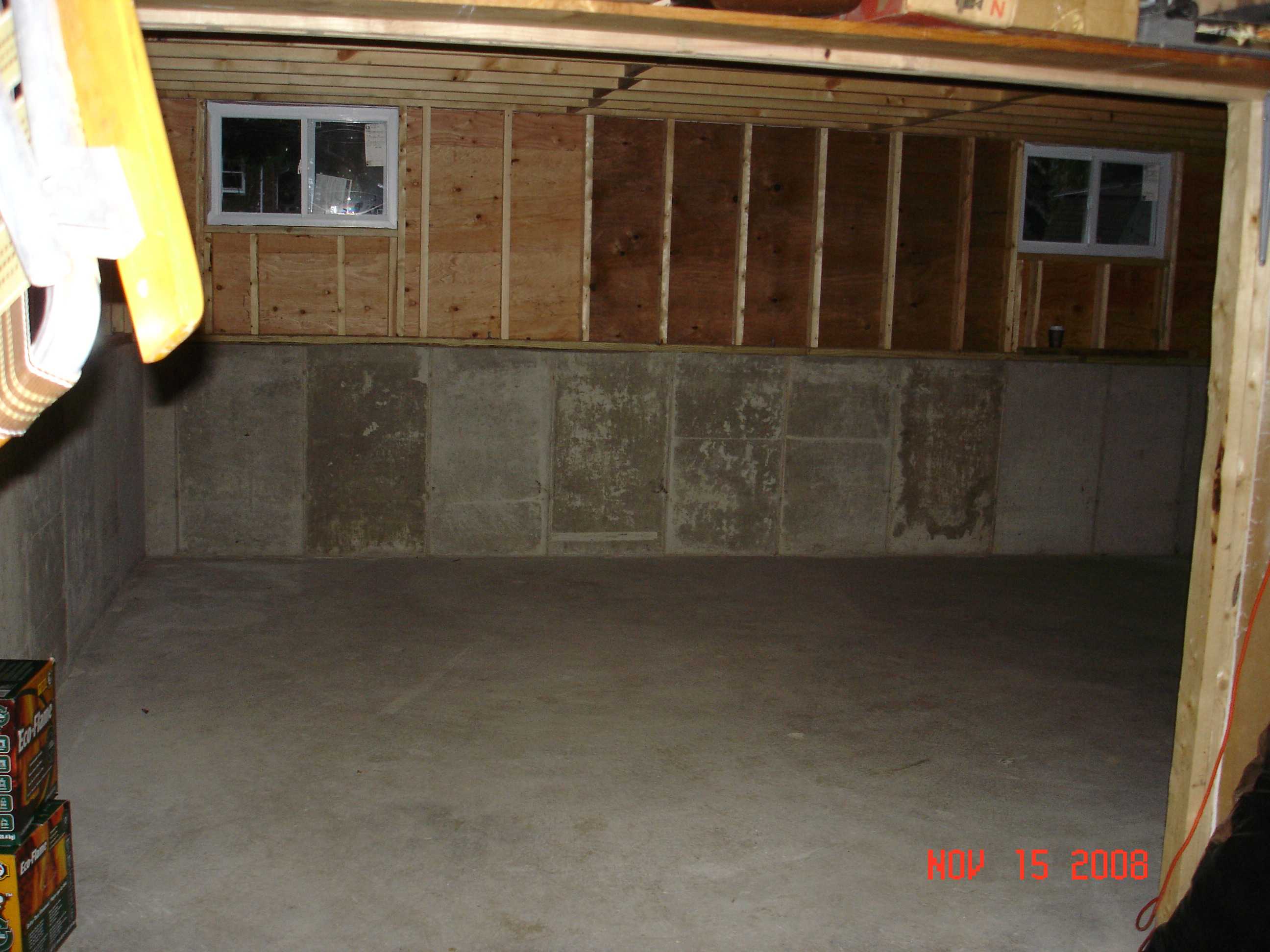

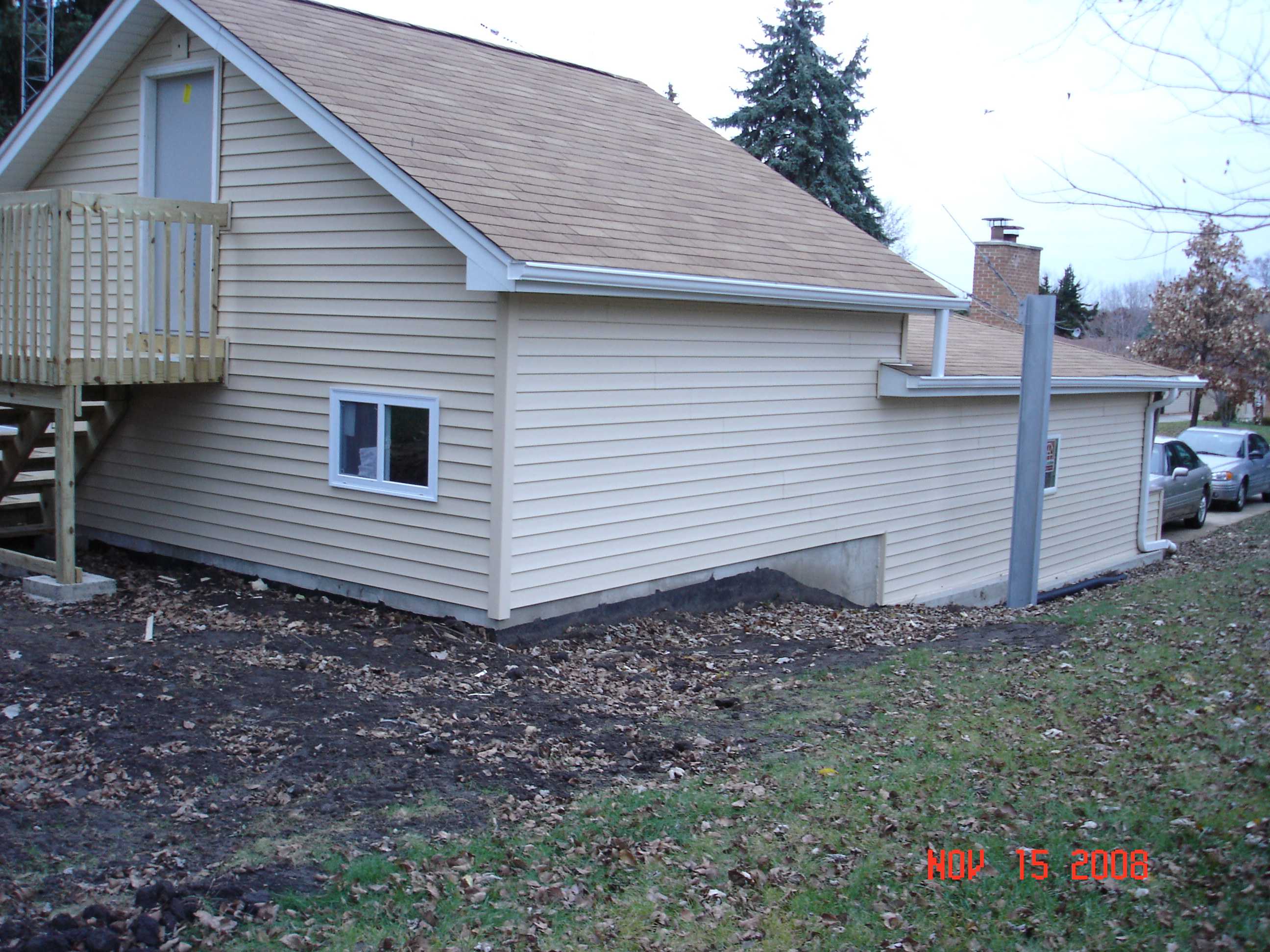

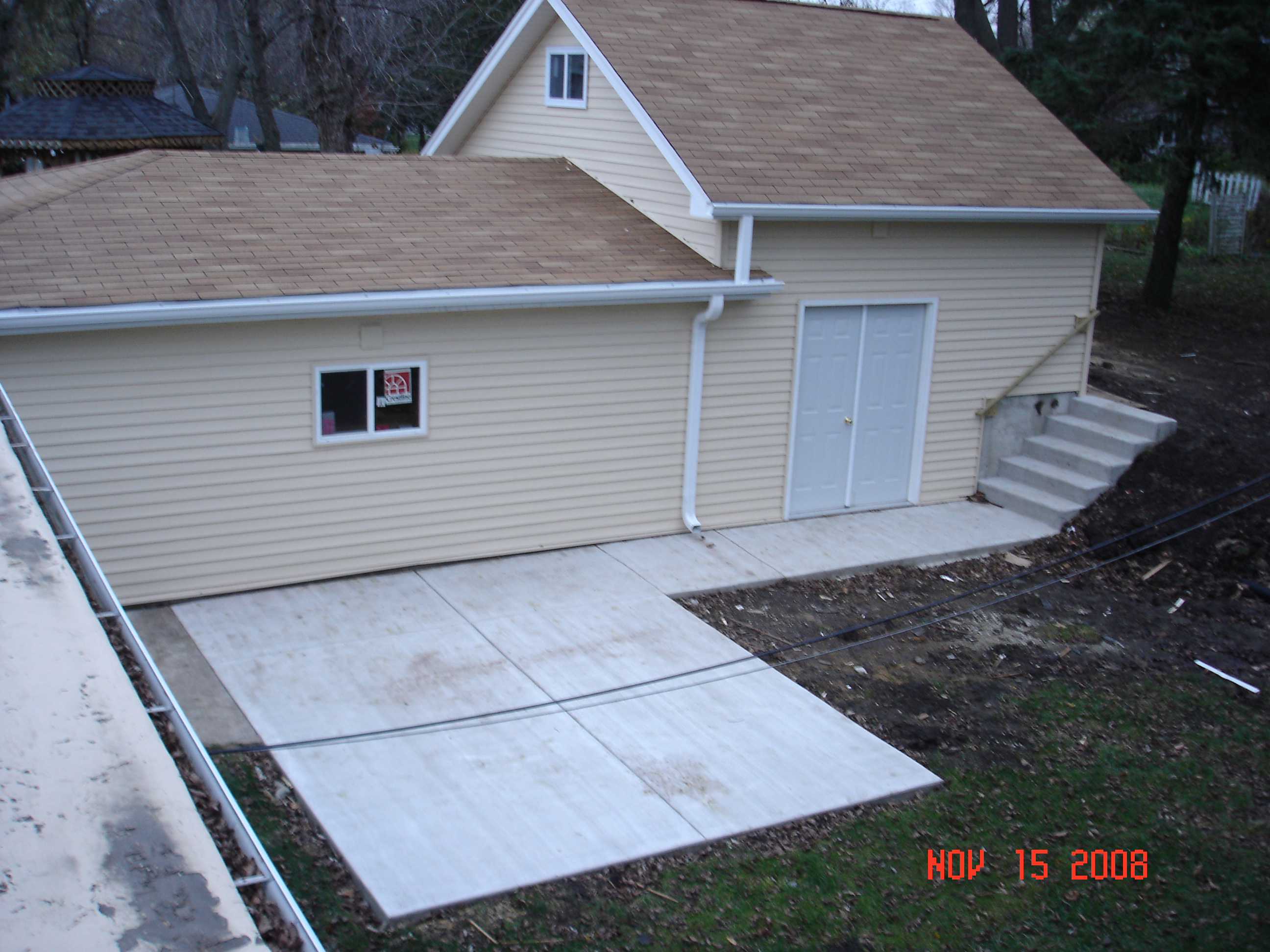

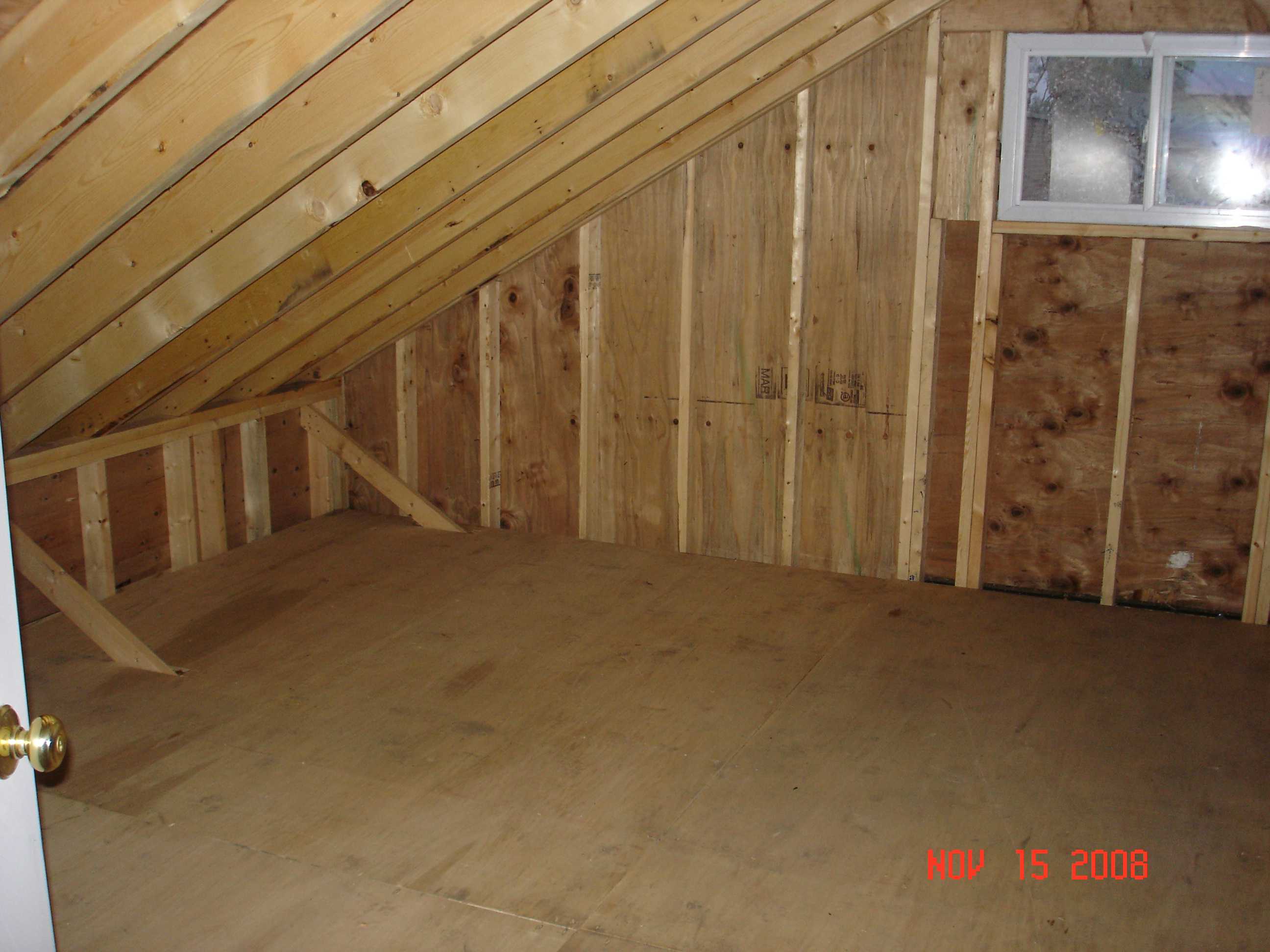

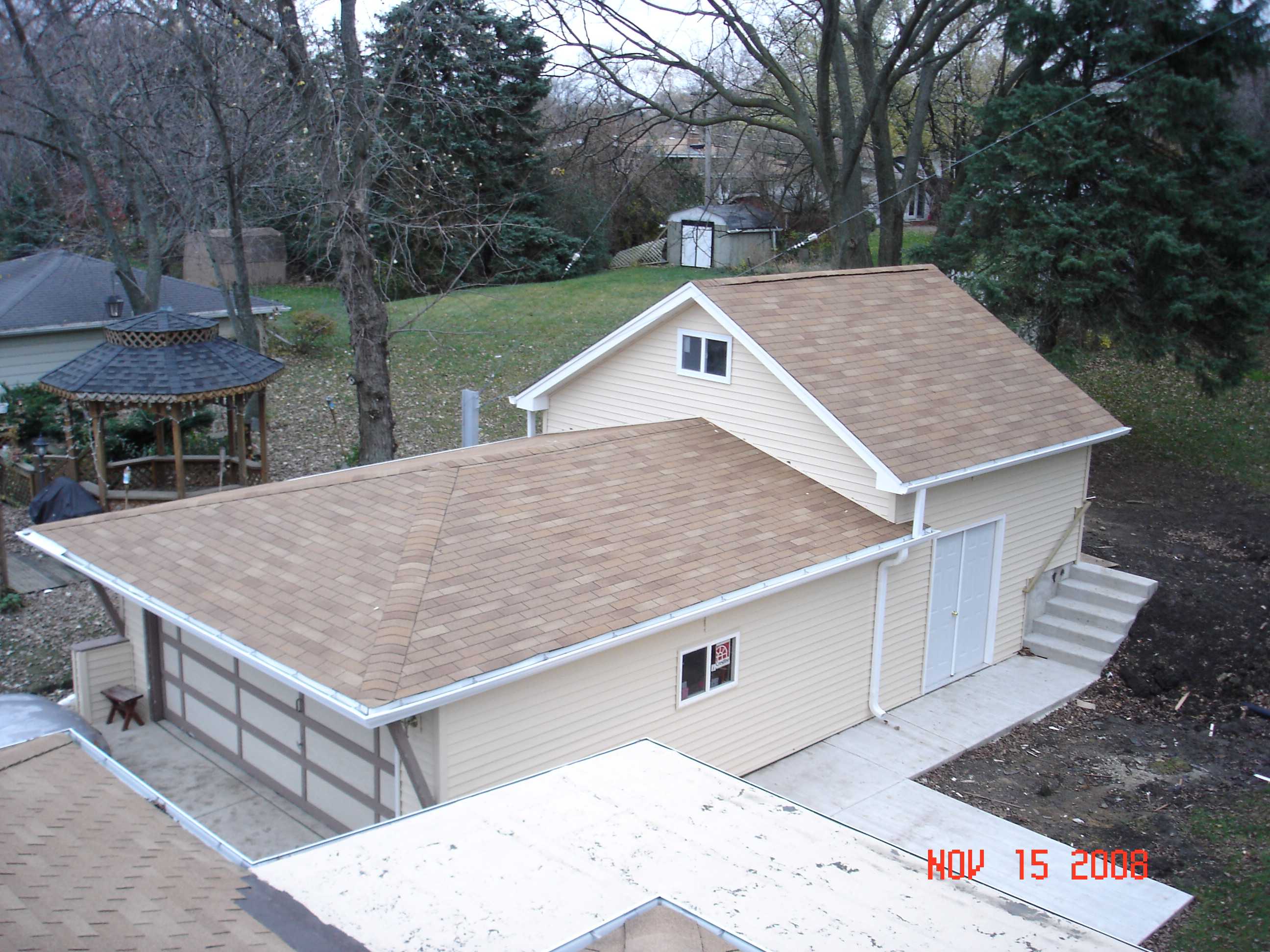

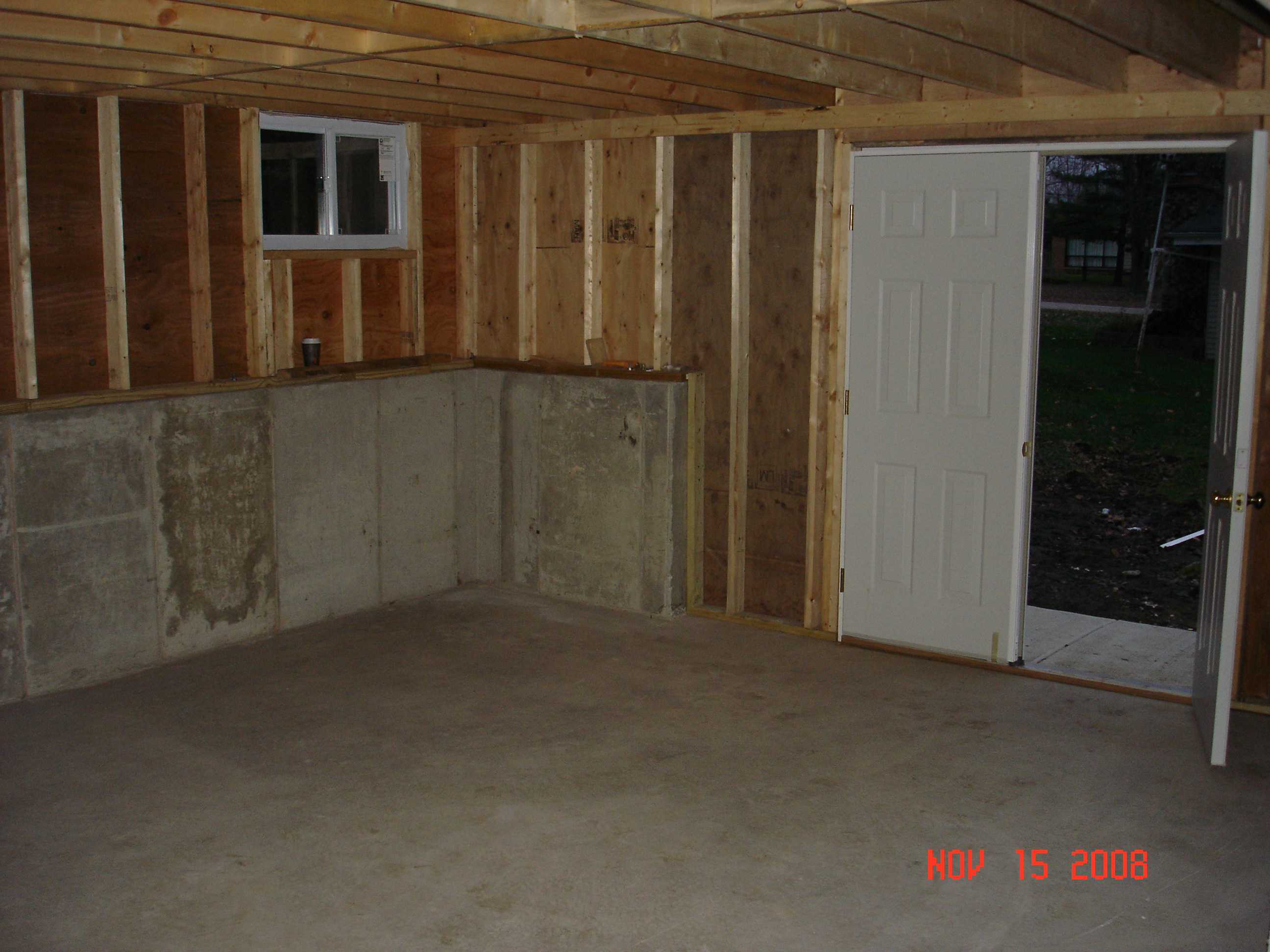

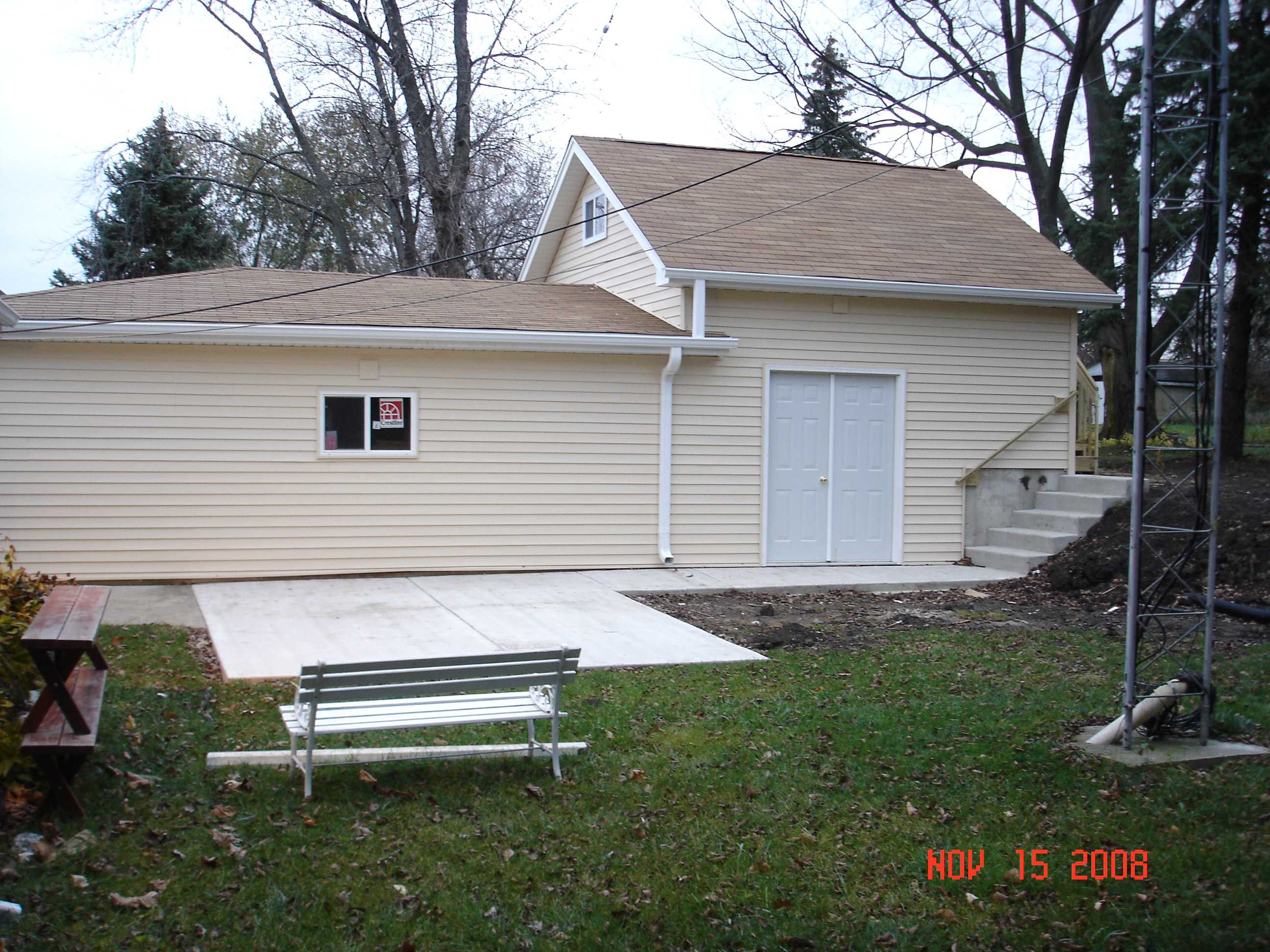

Days 20-25 (Thursday - Thursday 6-13 Nov 08): Siding complete, railing added, front lights added, approval from Bloomingdale received.
